Shelburne Falls Trolley Museum

Car No. 10 Car No. 10

Our New Carbarn

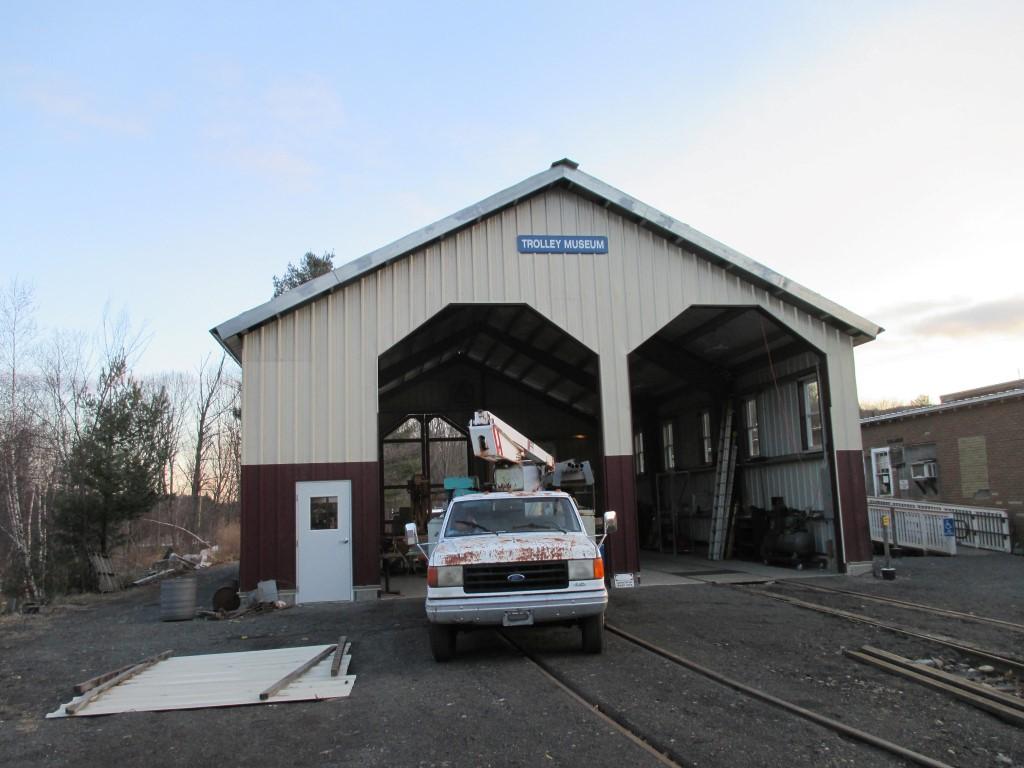

Trolley Car No.10 is back ... On track!

car barn story
No. 10 breaks the ribbon at the New Carbarn Grand opening July 23, 2016

In 2007 David Bartlett, a founding director of SFTM, proposed that the museum's resources should be directed toward building a fire-resistant Carbarn for storing trolley No. 10. The reasoning was that it was unwise to store a wooden museum piece in a wooden shed attached to another wooden building. Although these buildings are protected by a fire detection system, the board agreed with David's concerns, especially in light of recent fires at other museums that had caused loss of important historic railroad rolling stock.

The next few years were spent in designing the building, determining the best site for it on museum property in the Buckland Freight Yard in Shelburne Falls, and searching for funding sources. It was decided that the building should have room for a second stall to allow restoration of other rolling stock. The building should also be sited and designed to allow it to be extended to allow storage of more cars as our collection grows (click here to jump to the Car Barn Extension page). These considerations led to the decision to build a 40'x60' building on the location of an old grain building next to the Visitors Center building. This location would utilize the existing House Track for access, but would require additional trackage, overhead wires and turnouts to serve the two stalls.

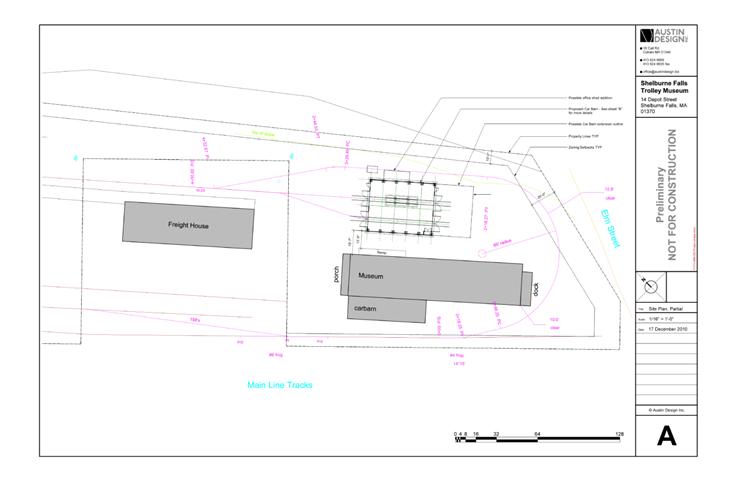

Site Plan
Site Plan (click on the image to get full-sized zoomable pdf version)

A study determined that the total project, including the new trackage and overhead wire to serve the new Carbarn, would cost over $100,000, including much volunteer labor for trackwork and building construction. Fundraising efforts began with a request for donations from our members, which resulted in a very satisfactory response. We also approached foundations and other granting organizations, and were awarded grants from the Amherst Railway Society, the Thomas Dailey Foundation ($2500), the 20th Century Electric Railway Foundation ($10,000 matching grant), the Massachusetts Cultural Facilities Fund ($27,500), the Asahel P.H. Bloomer/Caroline D. Bloomer Charitable Trust (two grants $5000) and the Community Foundation of Western Massachusetts ($3000). Amherst Railway Society supported us with their 2013 Heritage grant for trackwork ($3000), their 2014 Founders Award for the building itself ($10,000) and their 2015 Heritage grant for overhead trolley wire ($3500). Amherst Railway Society has awarded us grants for many other projects over the years as well.

Additional support came in the form of in-kind contributions from local companies. Austin Design of Colrain did much of the architectural and code-compliance work pro-bono, Vreeland Associates provided foundation structural engineering services pro-bono, and W.R. Hillman Sons Excavating and STI Services discounted their services. A donation of the track materials needed for the approach tracks, including rails, turnouts and ties, saved us about $50,000.

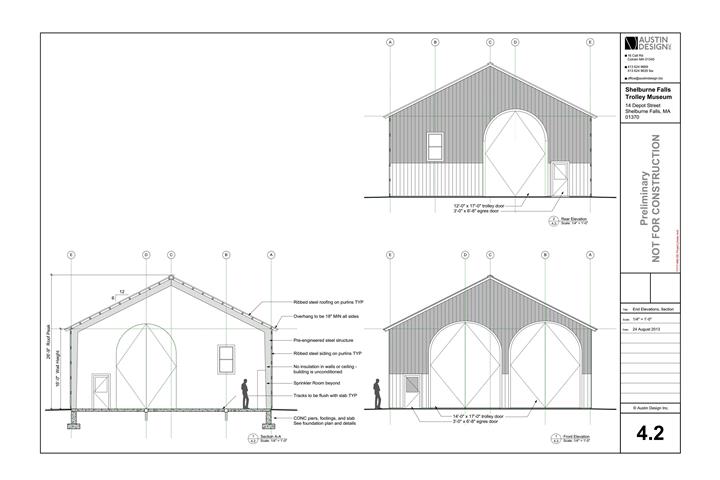

Here is our Building Plan. Note that the architect used compass bearings for his views, whereas we use railroad timetable directions, so what we would consider to be the west elevation is called the north elevation on the Building Plan. See the Site Plan for clarification.

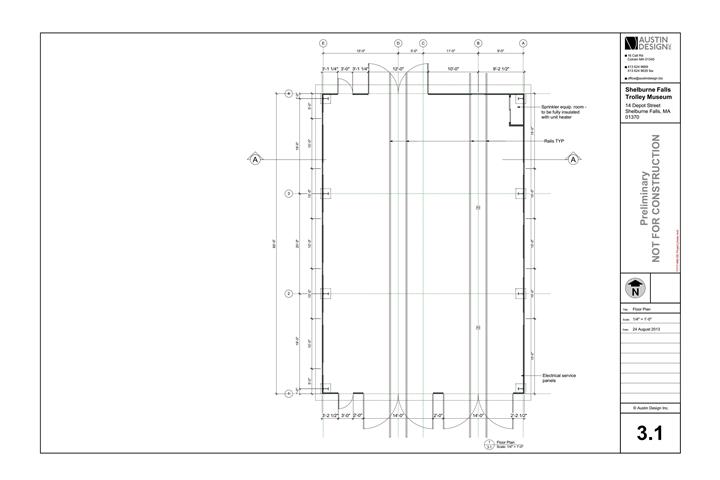

Floor Plan
Floor Plan (click on the image to get full-sized zoomable pdf version)

Side Plan
Side Plan (click on the image to get full-sized zoomable pdf version)

End Plan
End Plan (click on the image to get full-sized zoomable pdf version)

The New Carbarn is designed to fit in aesthetically with the existing 1867 Freight House that it sits next to. The Carbarn's roof line is steeper than typical modern steel buildings and it has eave extensions to mimic the railroad style of the Freight House. Additionally, we chose the siding in a two-tone scheme that matches the Boston & Maine Railroad scheme for the Freight House.

After much online searching for pre-engineered metal buildings (which led to lots of high-pressure return calls to 'pull the trigger now to save $20,000') we settled on Northern Building Systems of Dalton, MA for our building. Although we determined that the arched door openings would be too complicated, we were able to work with NBS to get the rest of the design that we wanted, whereas most other companies tried to to fit us into one of their standard designs. The NBS 'kit' came mostly precut and predrilled, so that we could use our team of volunteers and our cranes, with some additional heavy lifting by Mike Skalski's STI Services, to erect the building. NBS was also very helpful in getting us started on the actual assembly of the building. If you really want to 'get into the weeds', here are the NBS Structure Plans.

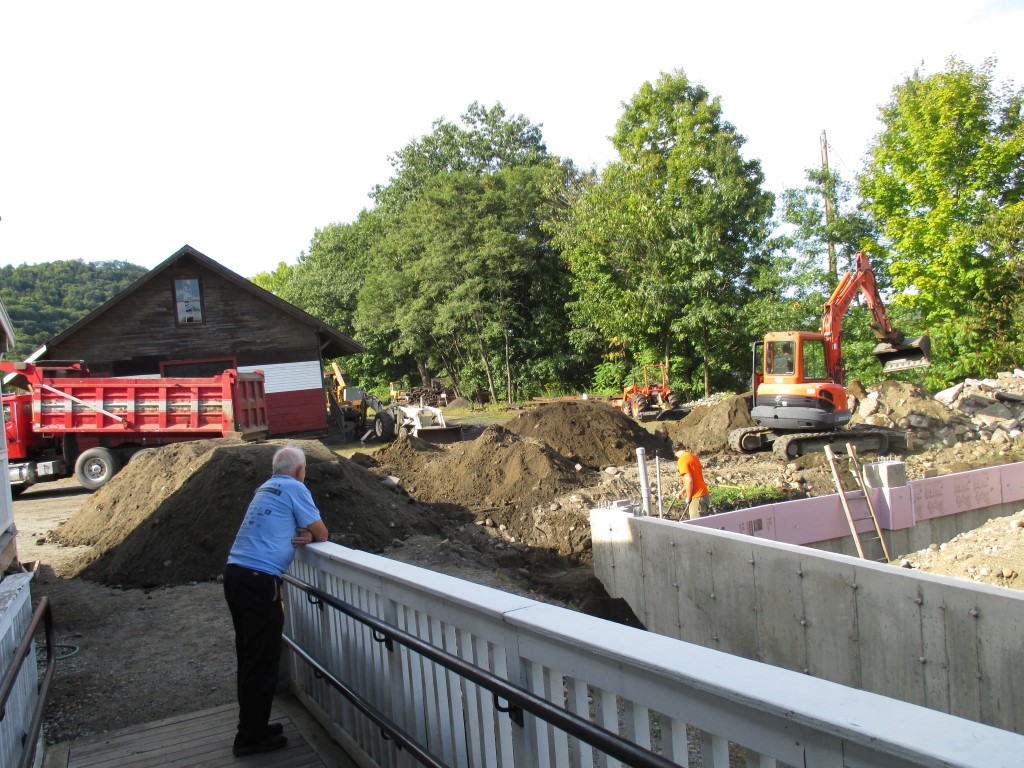

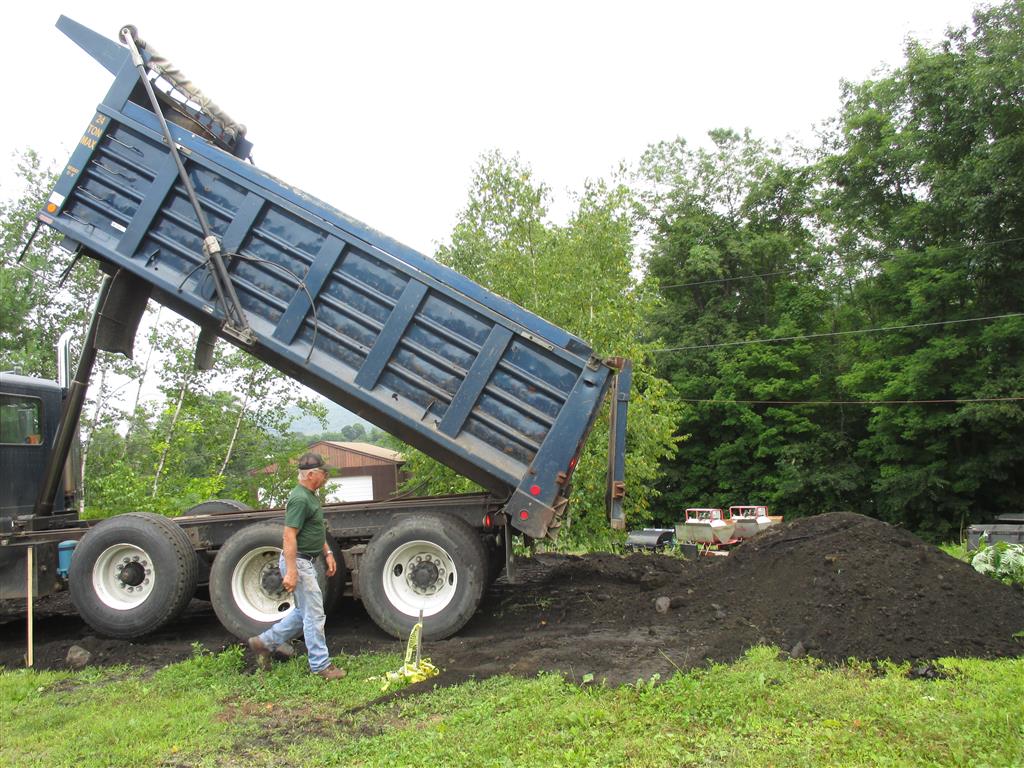

Progress became evident in 2013 when we started the site preparation. The first step was to remove the old Grain Shed.

Grain Shed
This building was once used to sell bagged grain to local farmers.

There are some pictures of the Old Grain Shed and its demolition on this page. The new Carbarn is situated right where this building once stood (compare to the picture at the top of the page). You can see ruts in the foreground where the end of the House Track has been removed.

At this point we were able to move ahead on several fronts. We needed to keep raising money, we needed to rebuild the track with the new turnouts (see pictures of that project here), we needed to install poles, bracket arms and overhead wire (see pictures of that project here), we needed to finalize the foundation plans and get a permit, and we needed to prepare the site for the building.
Use these links to jump to certain phases:
Site Preparation, Fall 2013
Foundation, Summer 2014
Stall Tracks, Fall 2014
Frame, Winter 2014
Siding, Windows and Roof, Spring 2015
Floor, Spring 2015
More siding and details, Summer 2015
Doors, Fall 2015/Winter 2016
Interior and overhead wiring, Spring 2016
Finale! Summer 2016

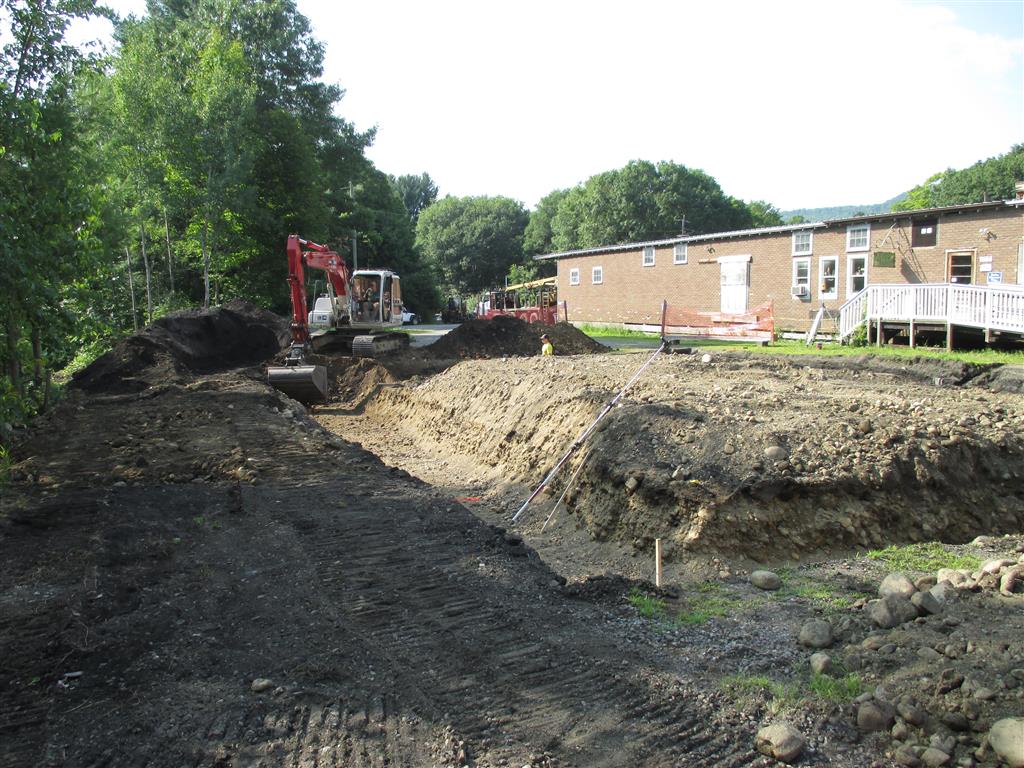

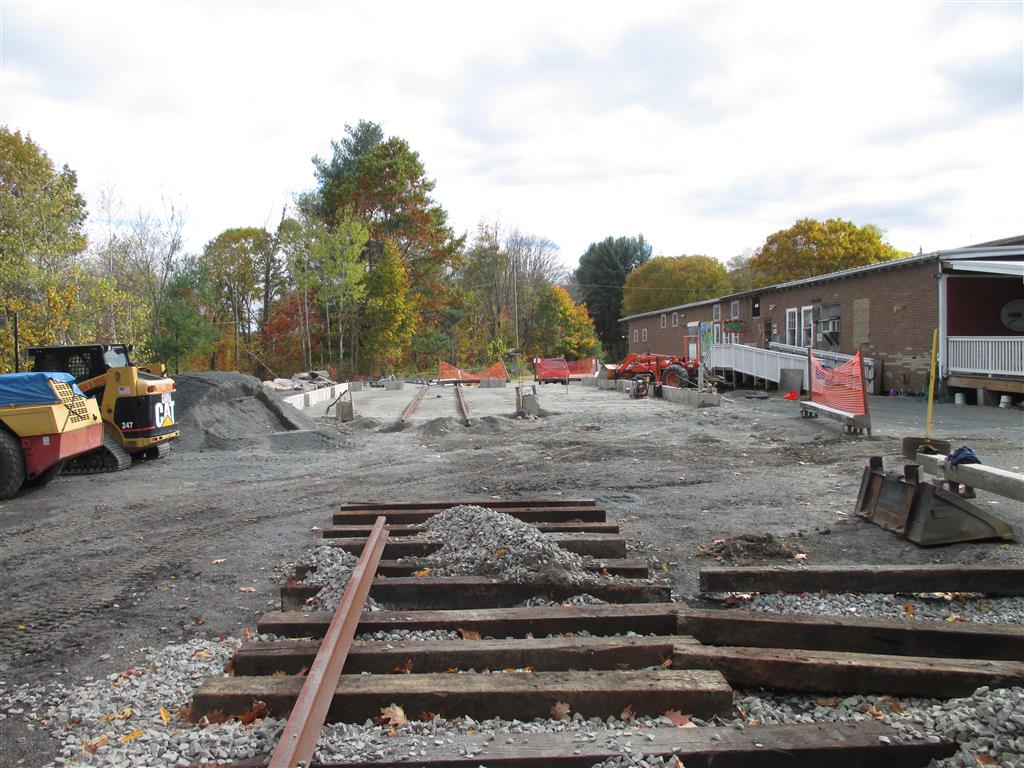

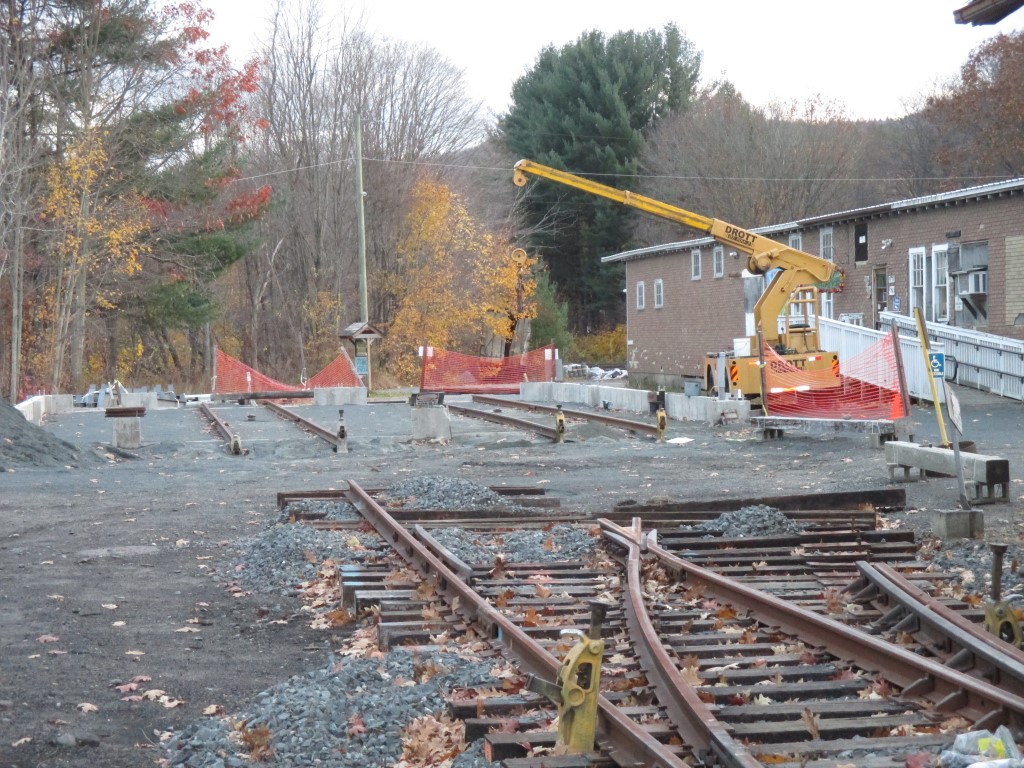

Fall 2013 - Preparing the site for the foundation work.
car barn progress
Fall of 2013, some Directors and volunteers at the ceremonial groundbreaking. (Photo by Tyler Trahan)
car barn progress

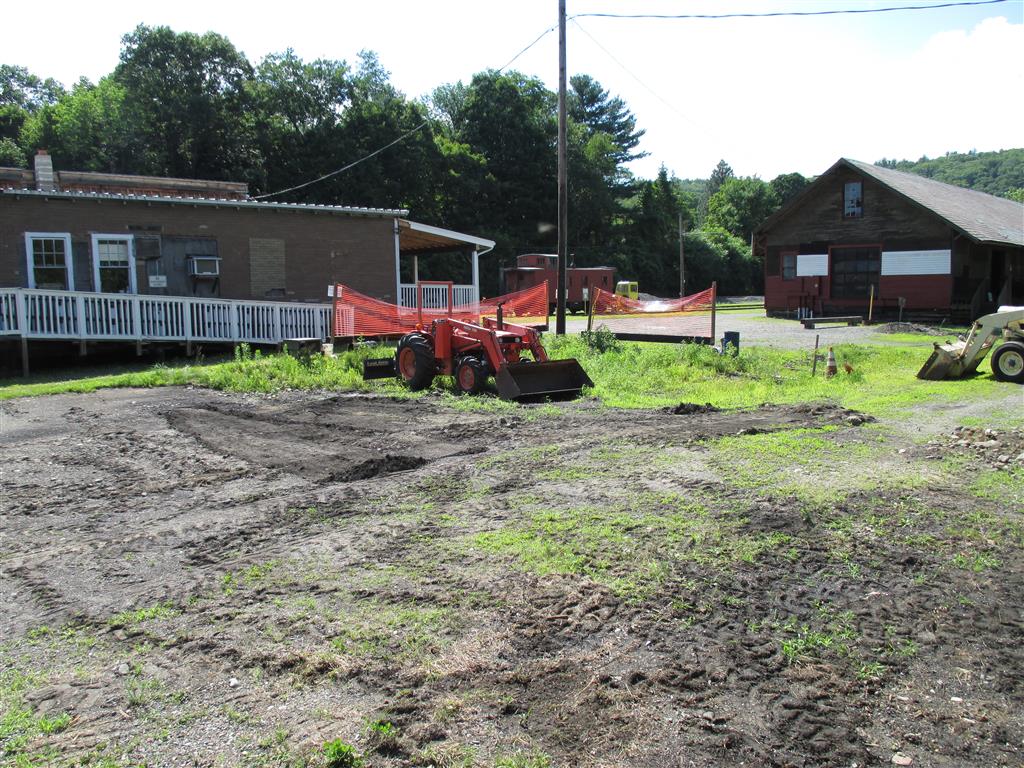

July 2014, this is where the old shed used to be, and the future site of the new Car Barn.
car barn progress

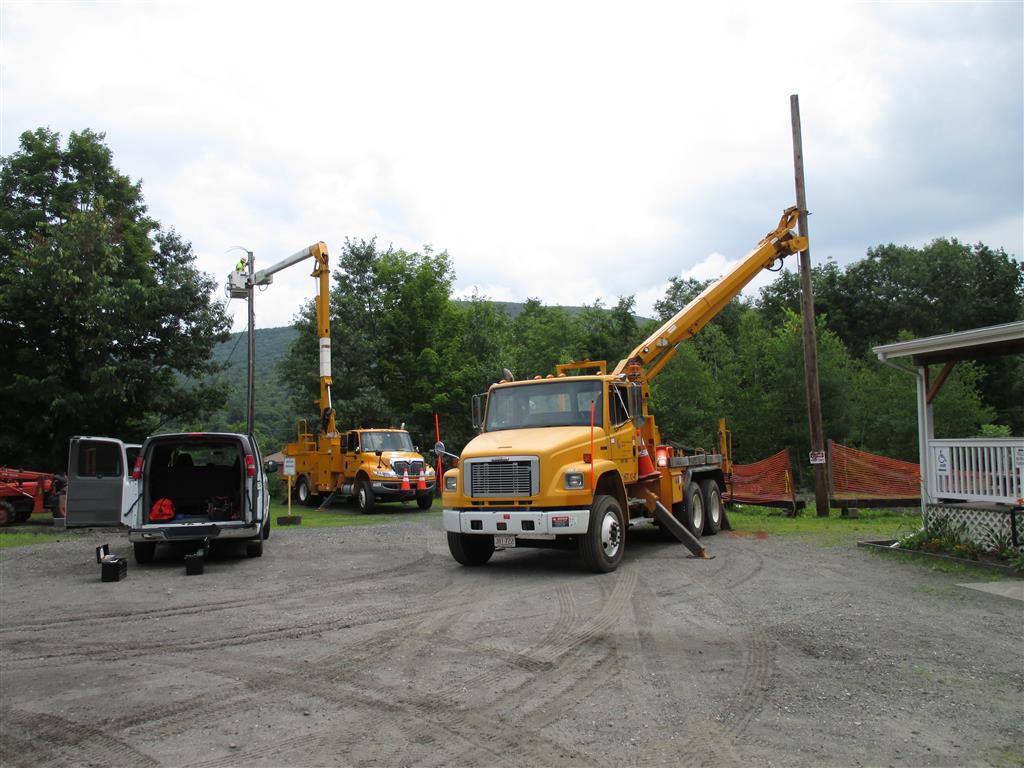

Here is WMECO removing the power pole that used to stand near the shed. The wiring has been put underground by the Franklin County Technical School electricians.
car barn progress

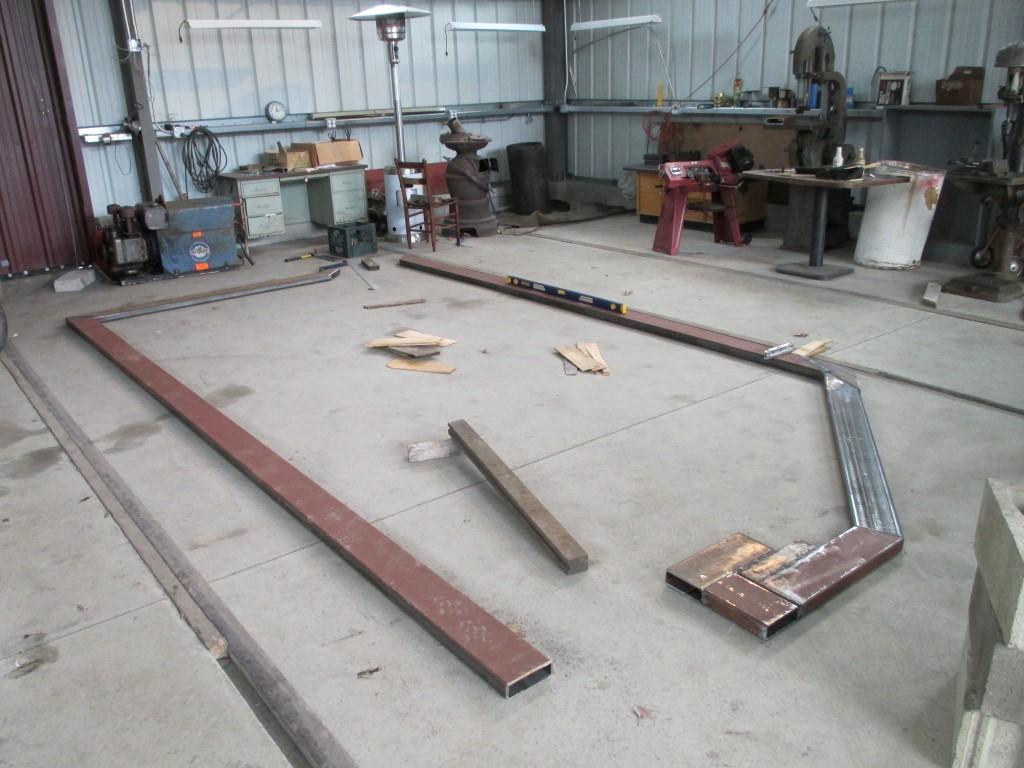

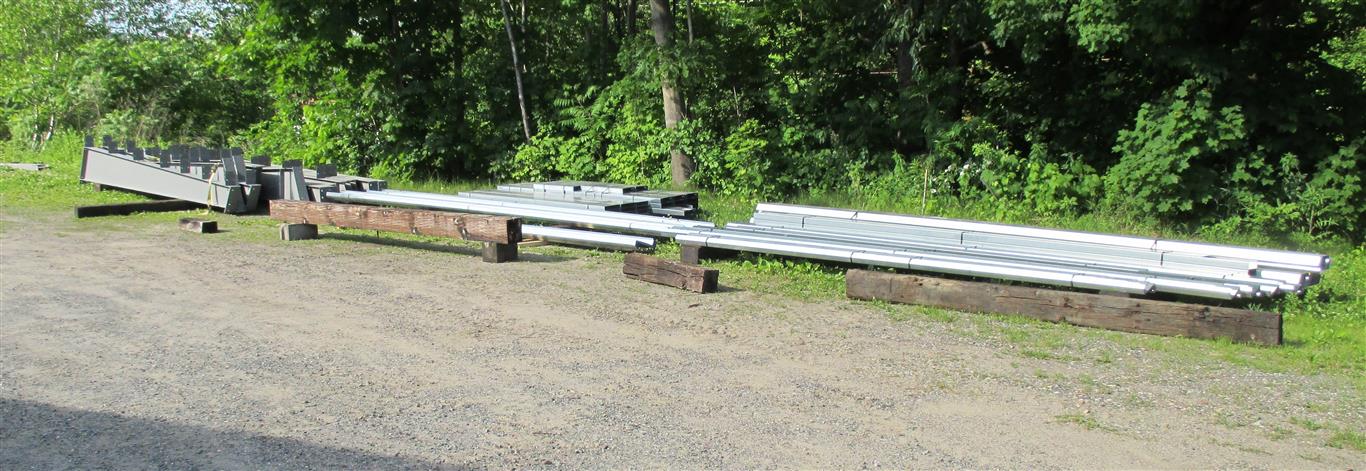

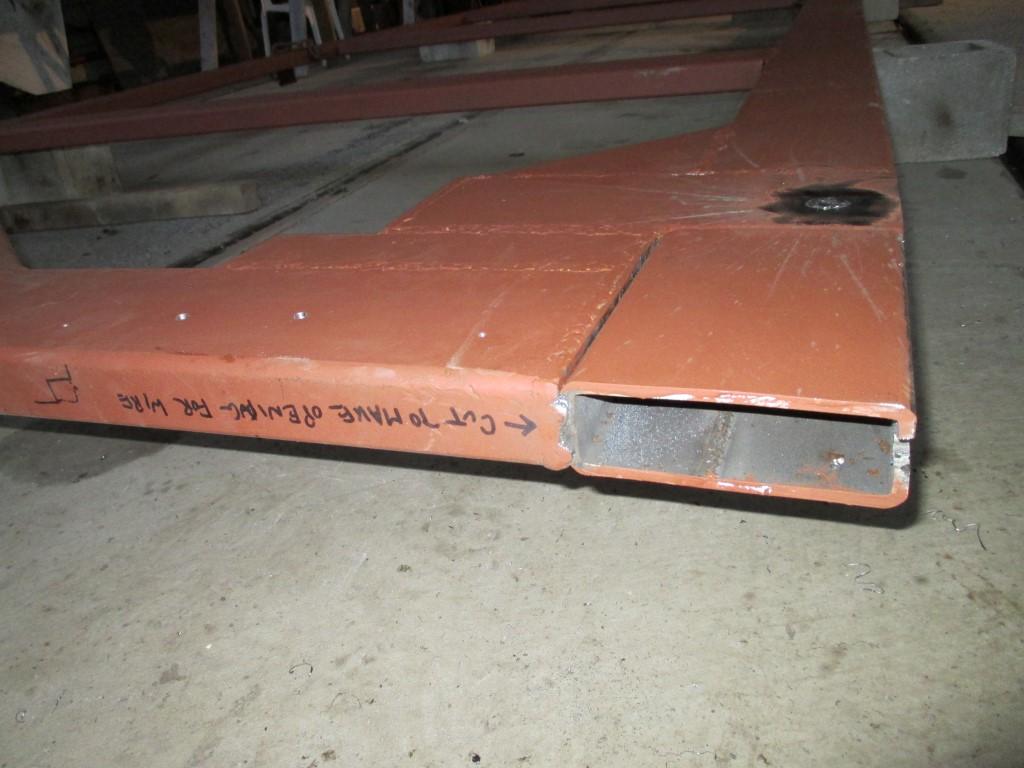

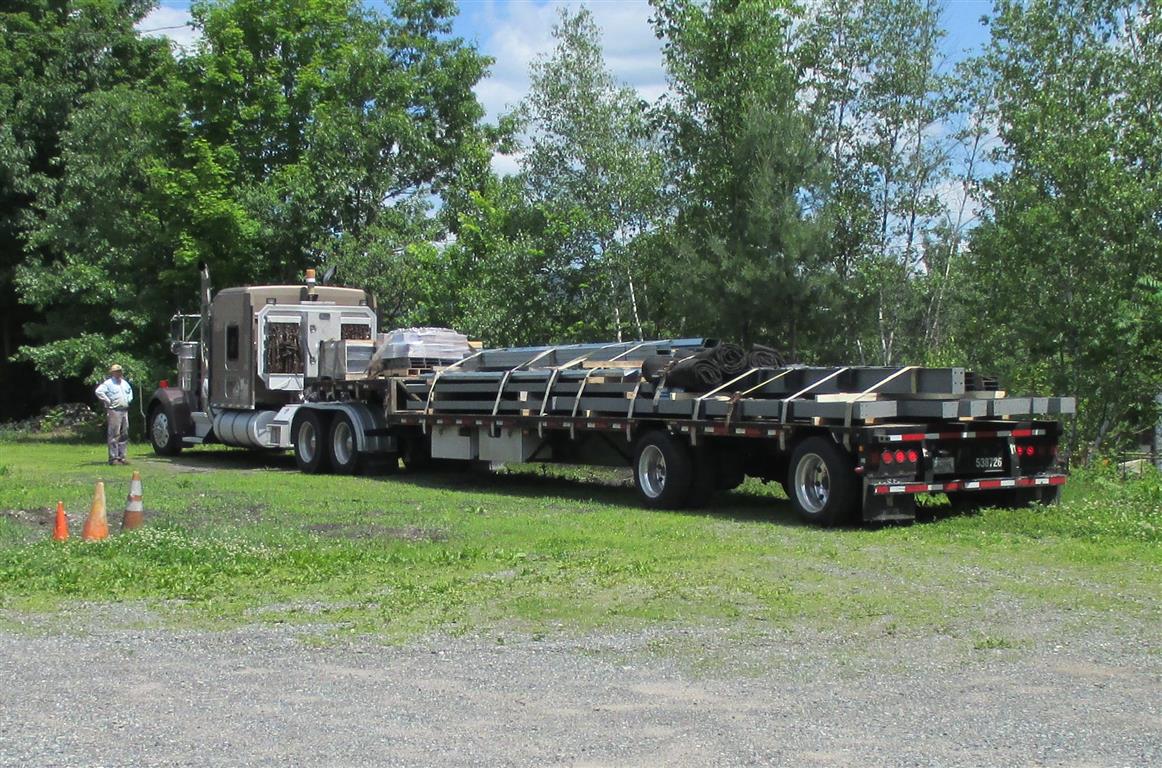

Here are the structural members for the pre-engineered metal building, arriving on a truck,
car barn progress
and waiting for the foundation so it can be put up.
car barn progress

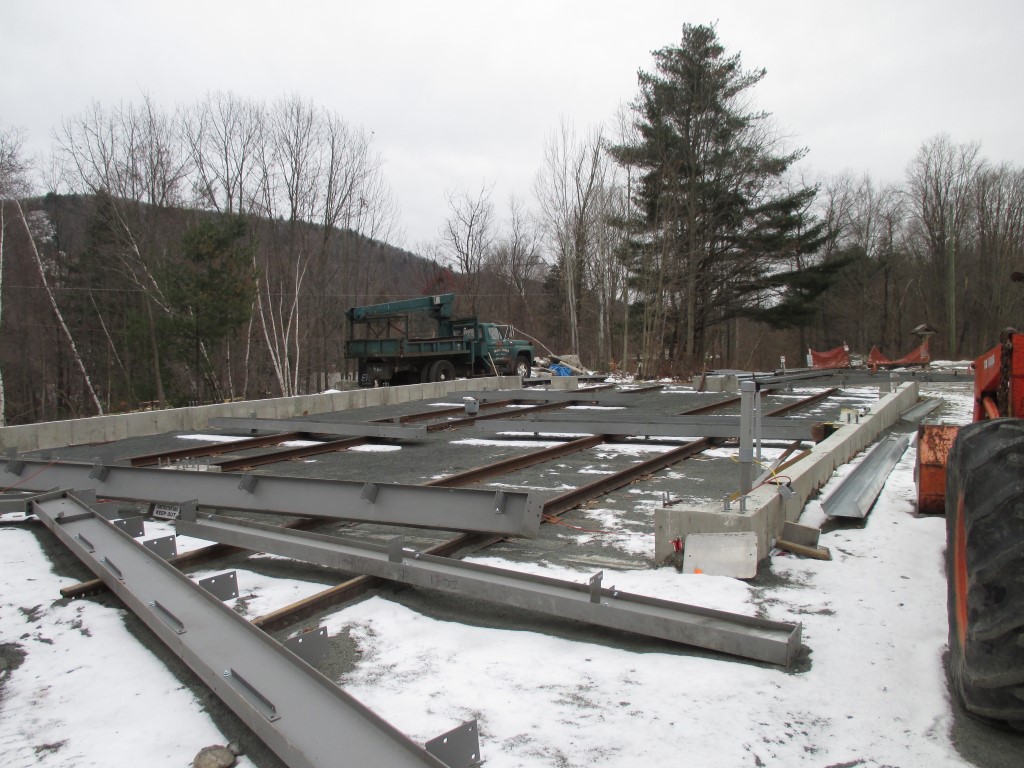

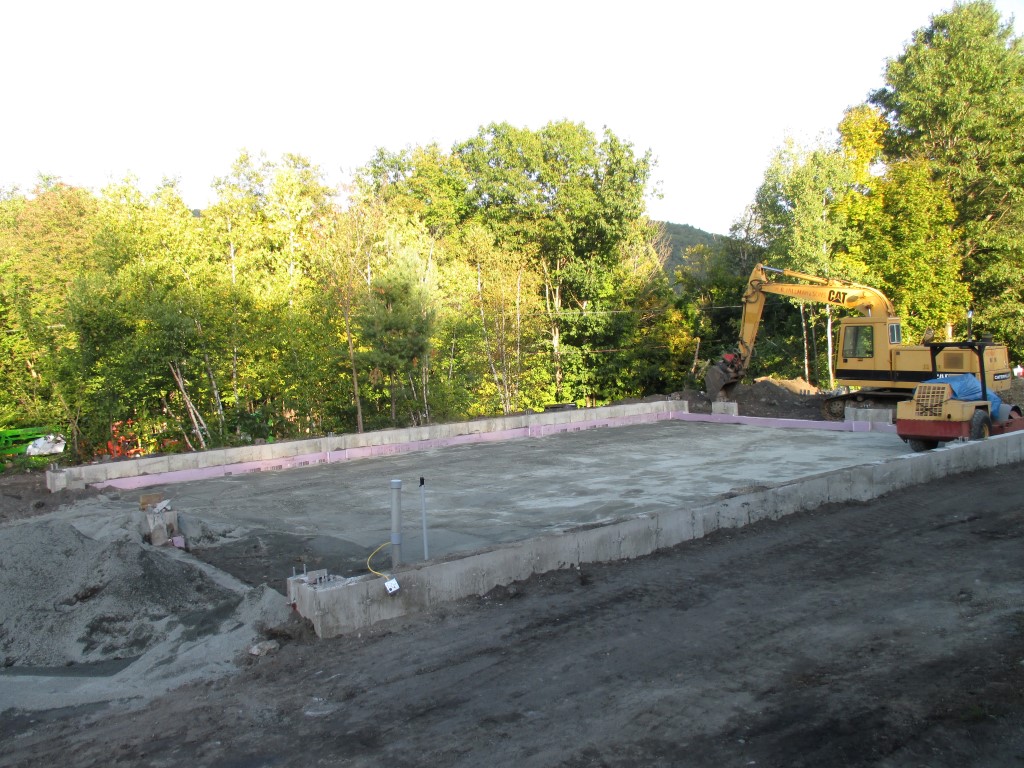

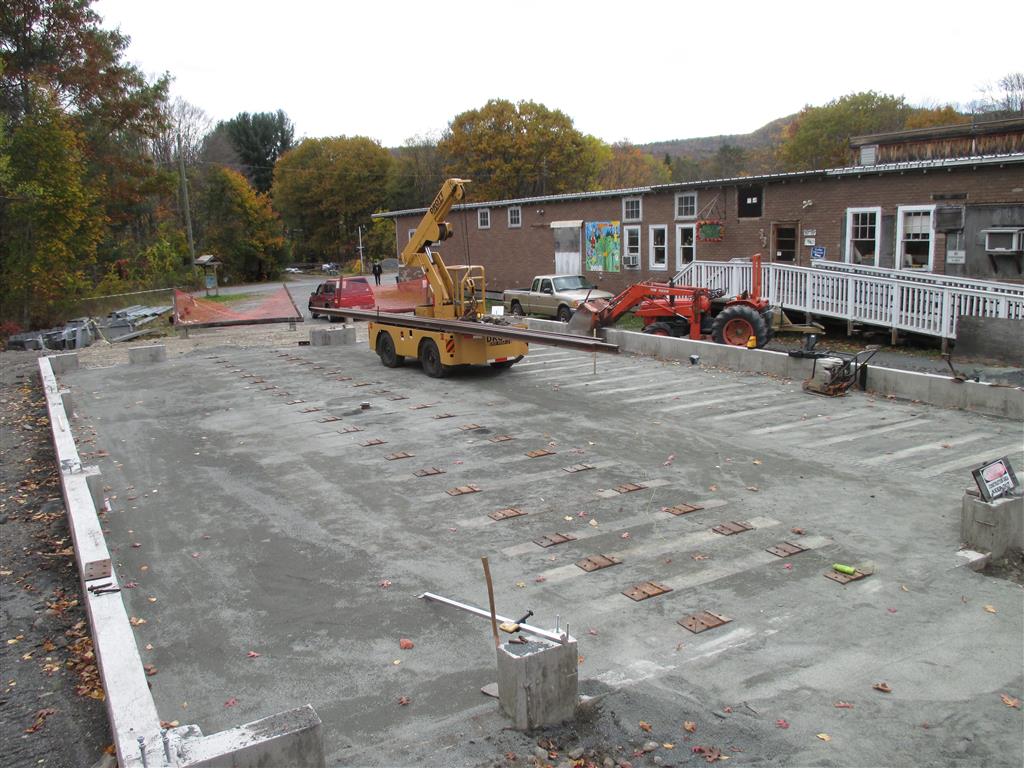

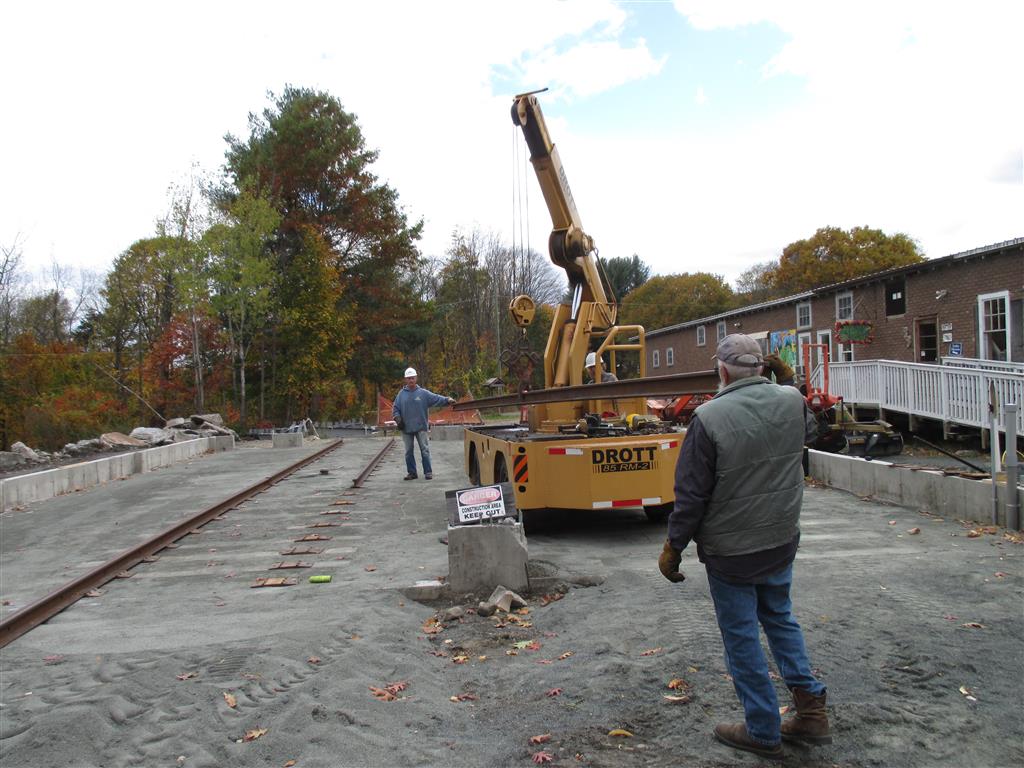

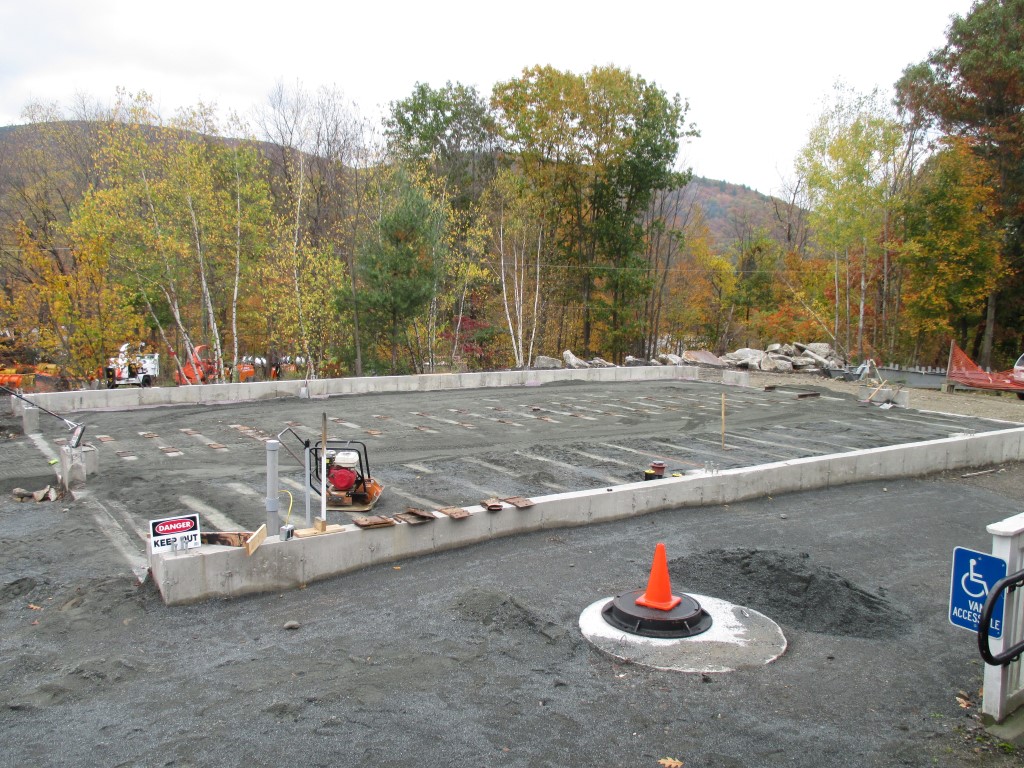

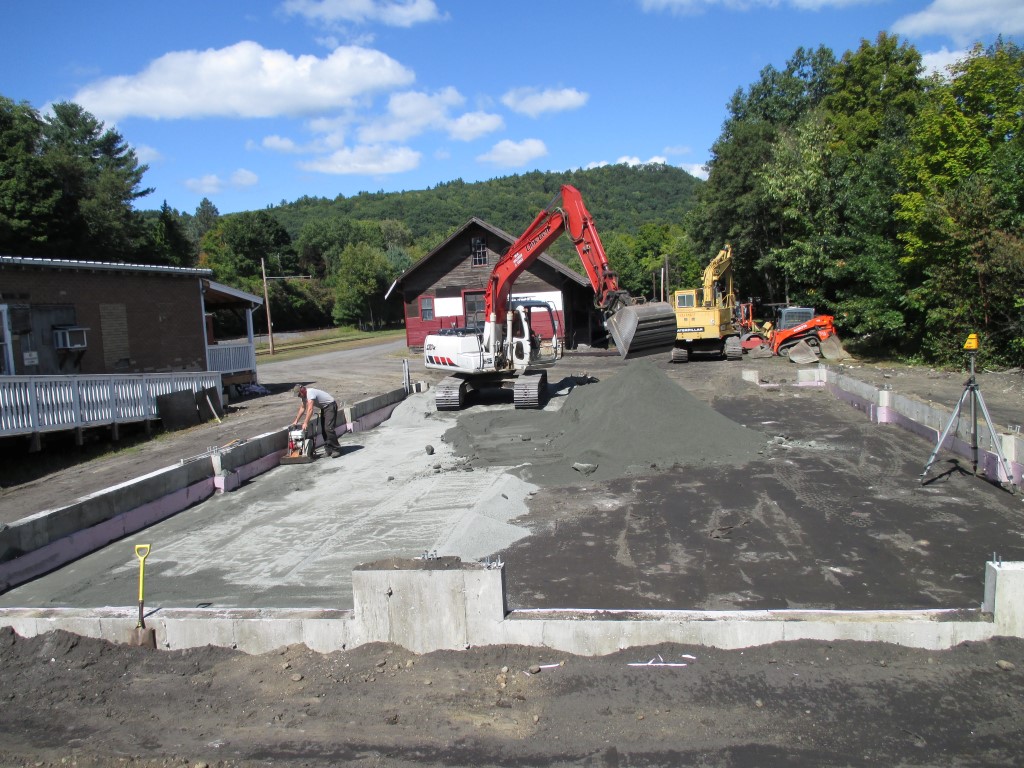

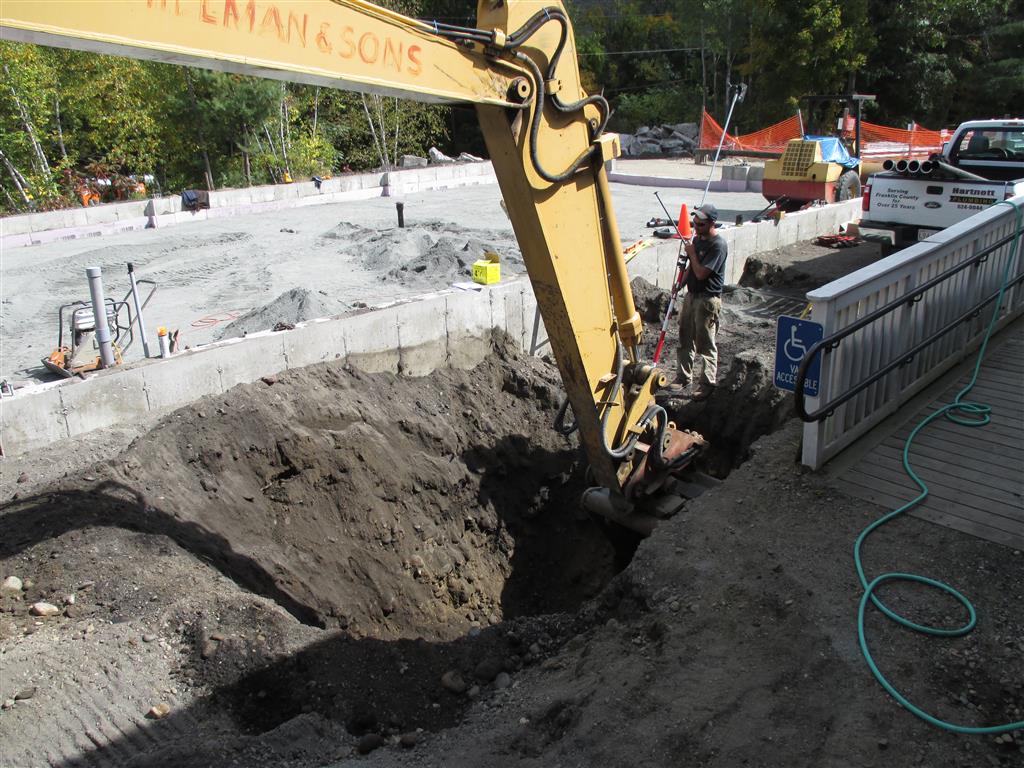

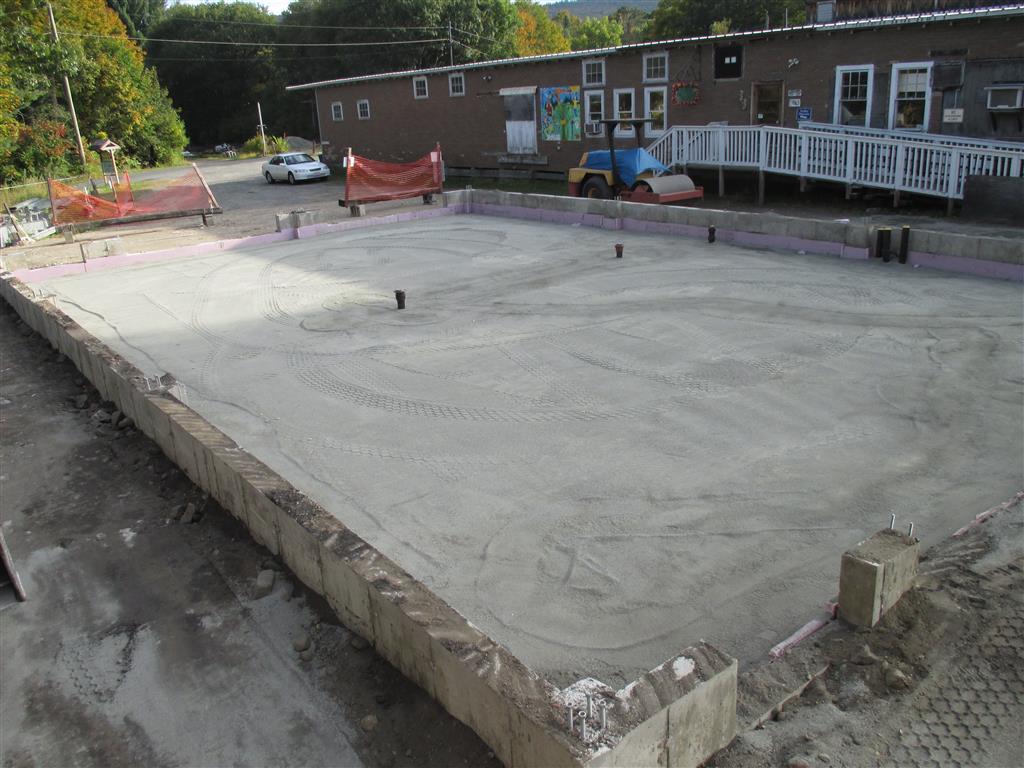

August 2014 W.R. Hillman Excavating is digging the foundation.
car barn progress
Rob Hillman moving material out of the way.
car barn progress

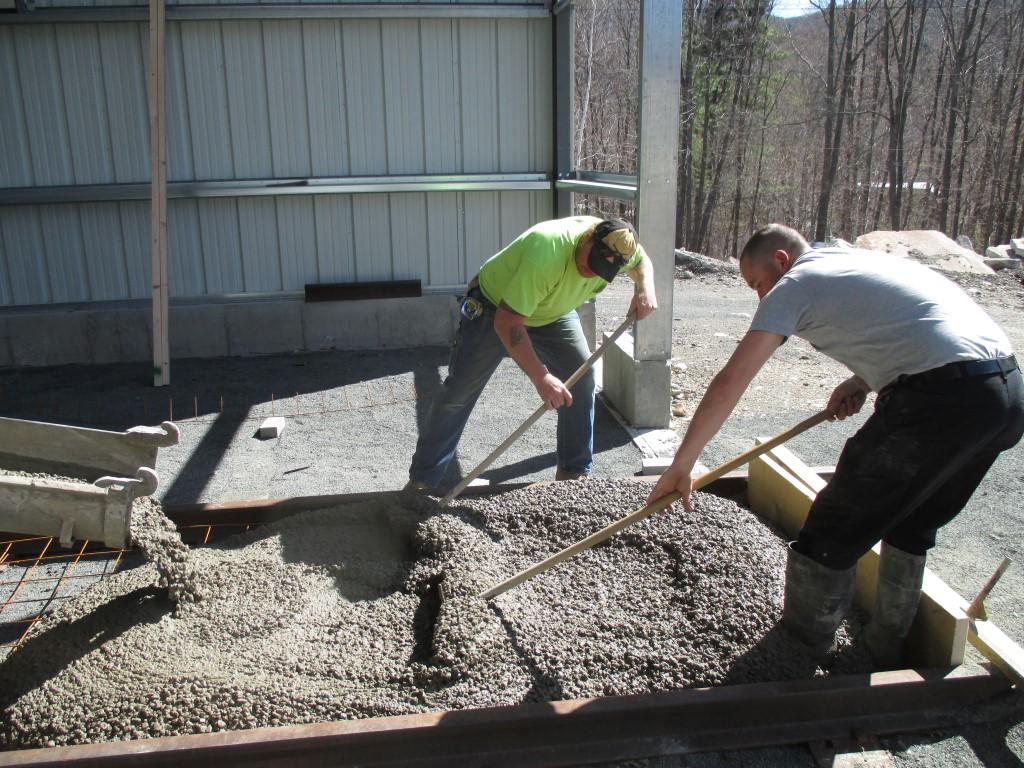

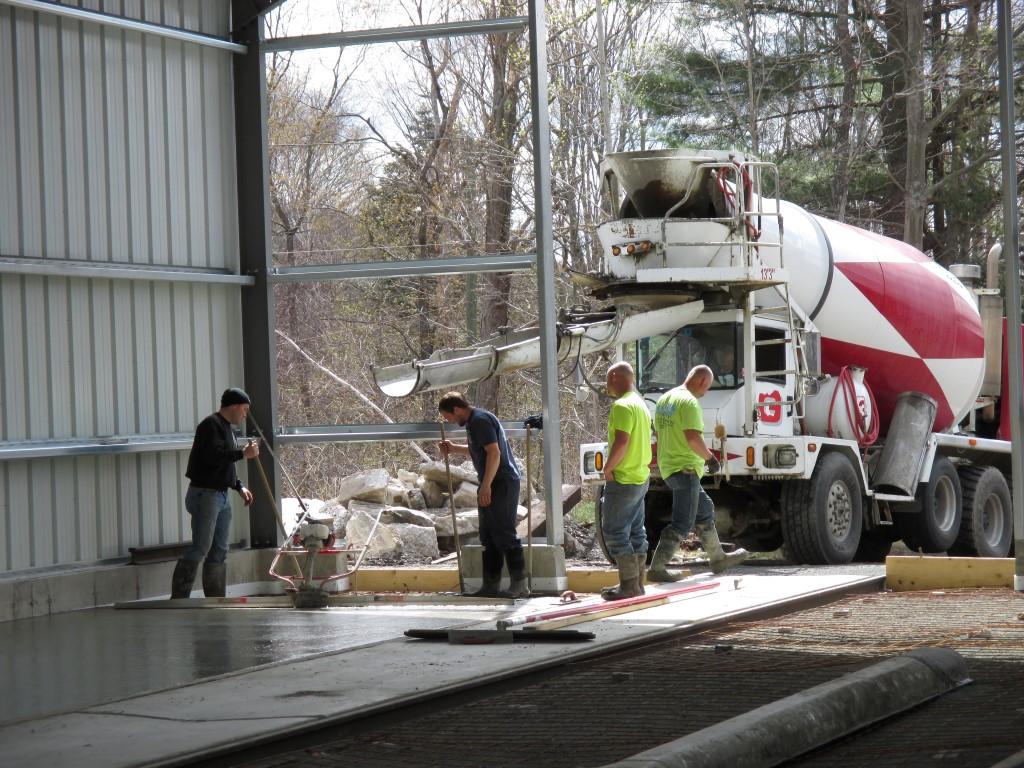

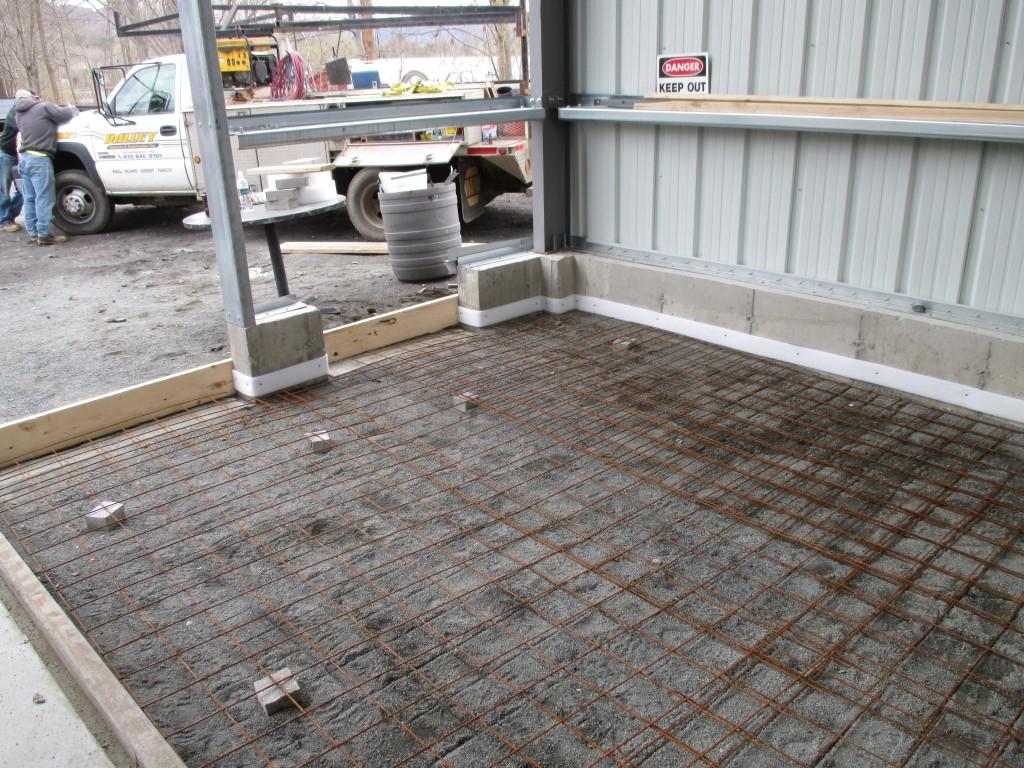

Summer 2014 - Pouring the foundation and frost walls.

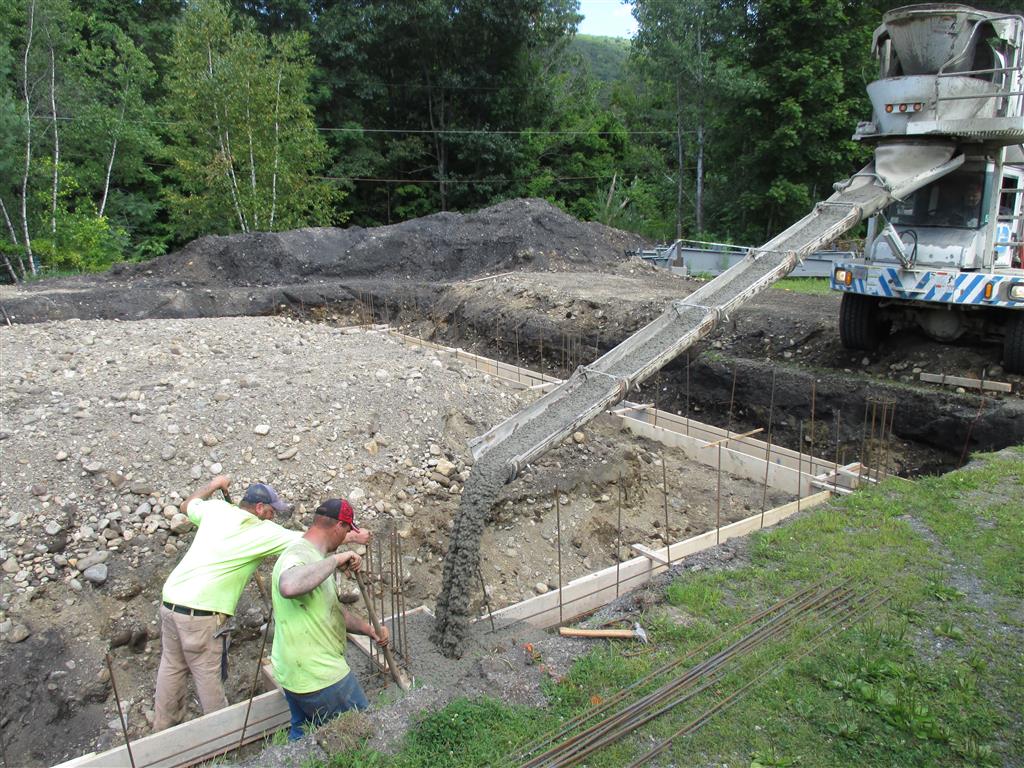

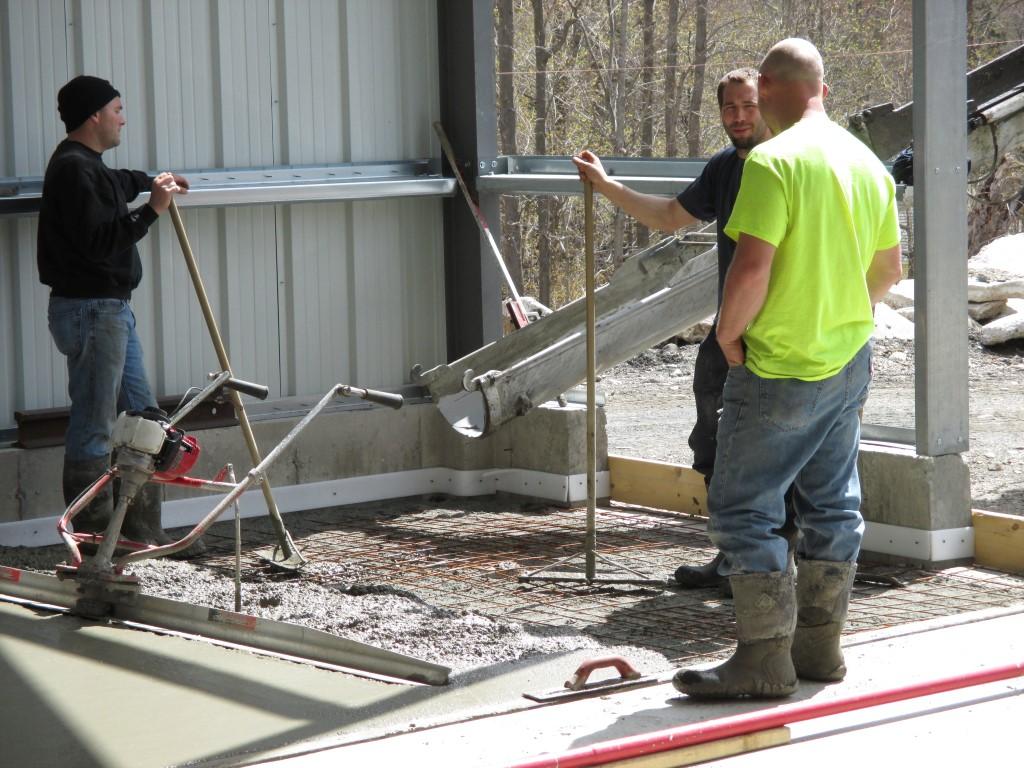

Valley Concrete crew pouring the footings.

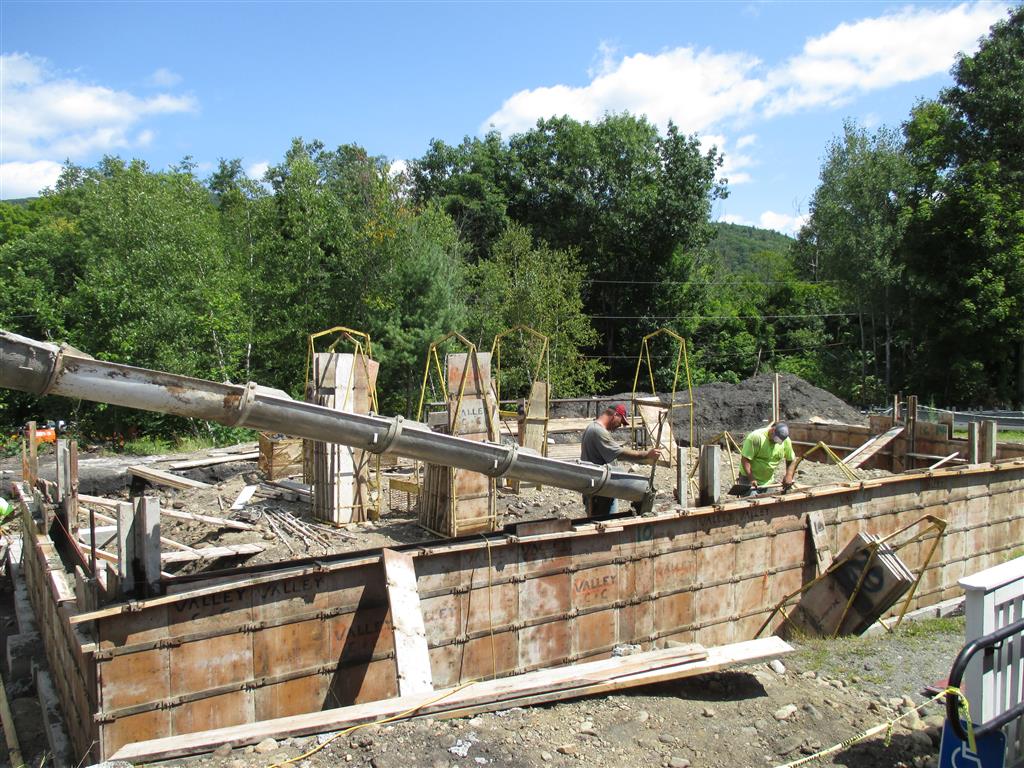

car barn progress
Valley Concrete crew pouring the walls.
car barn progress

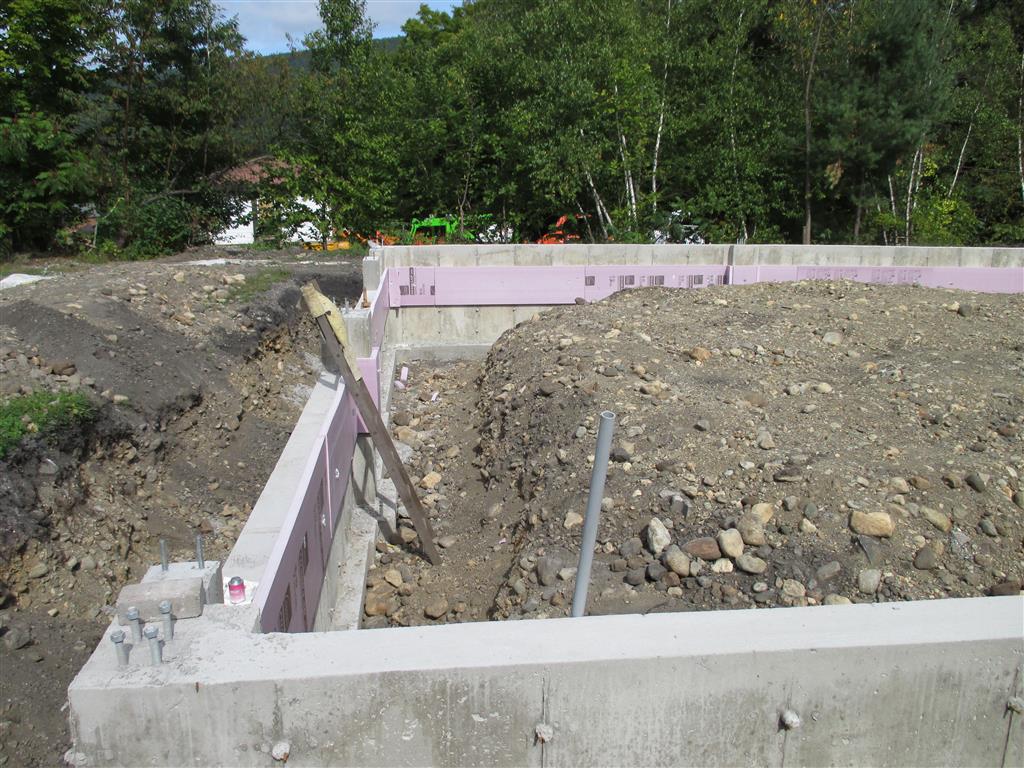

Finished walls awaiting backfilling.
car barn progress
Sept 2014 Chief Engineer Dave Bartlett inspects the progress.
car barn progress
The walls have been backfilled, Hillman is spreading stone dust and compacting it up to the level of the bottom of the new ties.
car barn progress
The floor is leveled and compacted and ready for the floor drains to be installed.
car barn progress

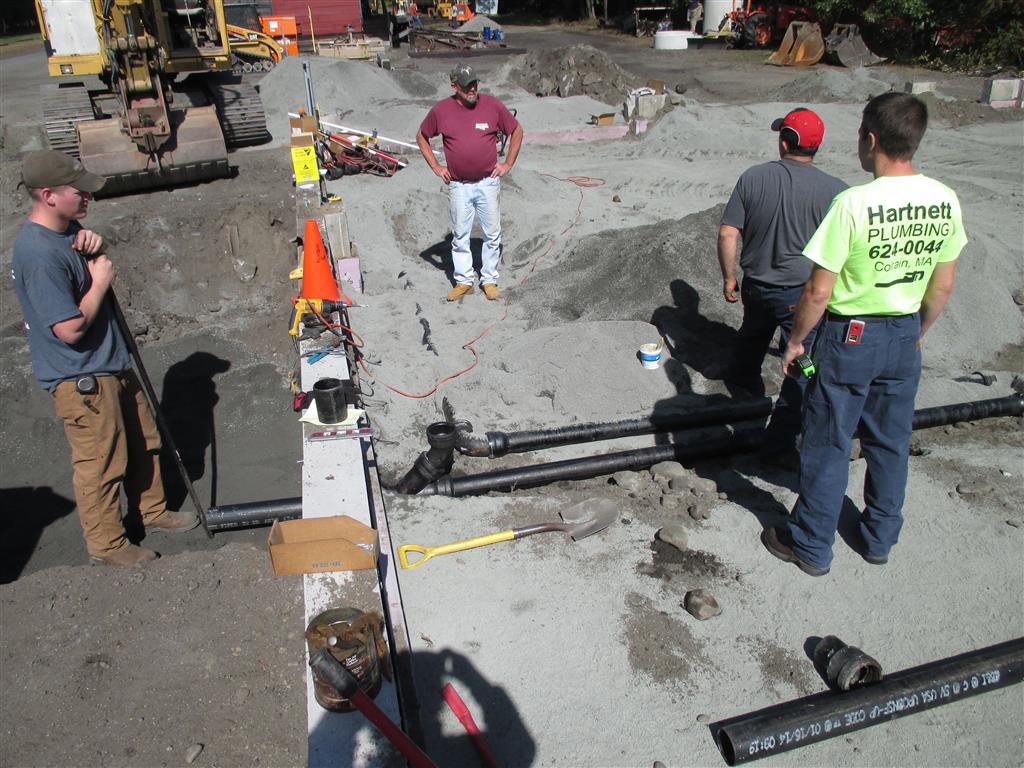

Hartnett Plumbing crew runs the drains through the wall.
car barn progress

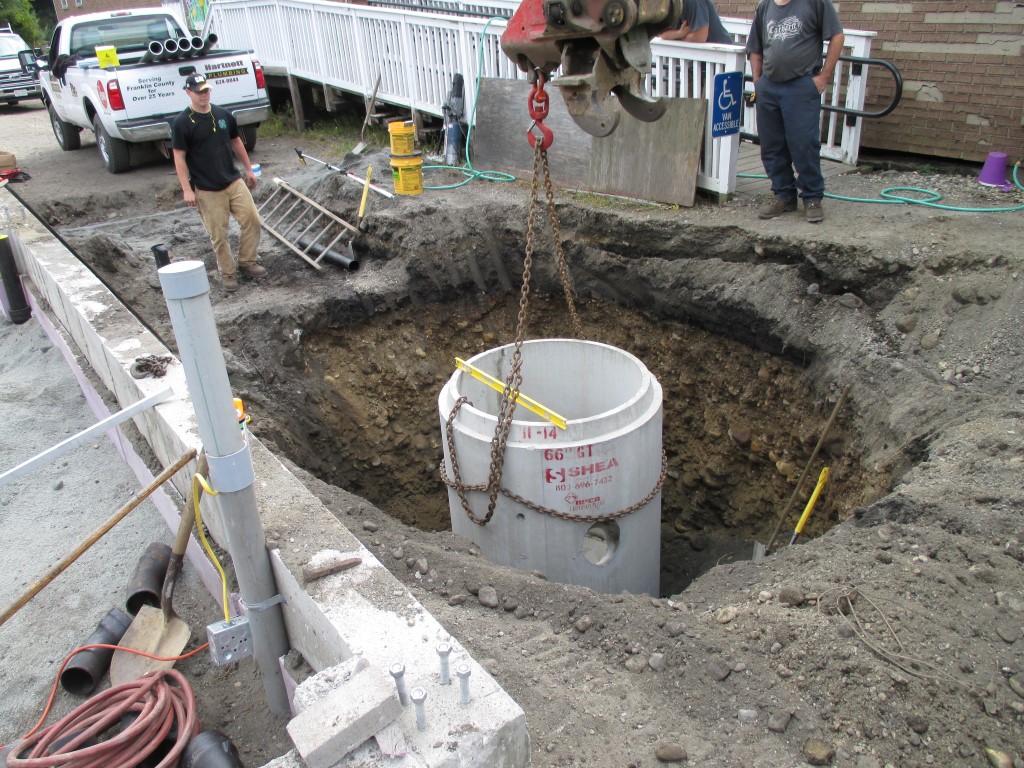

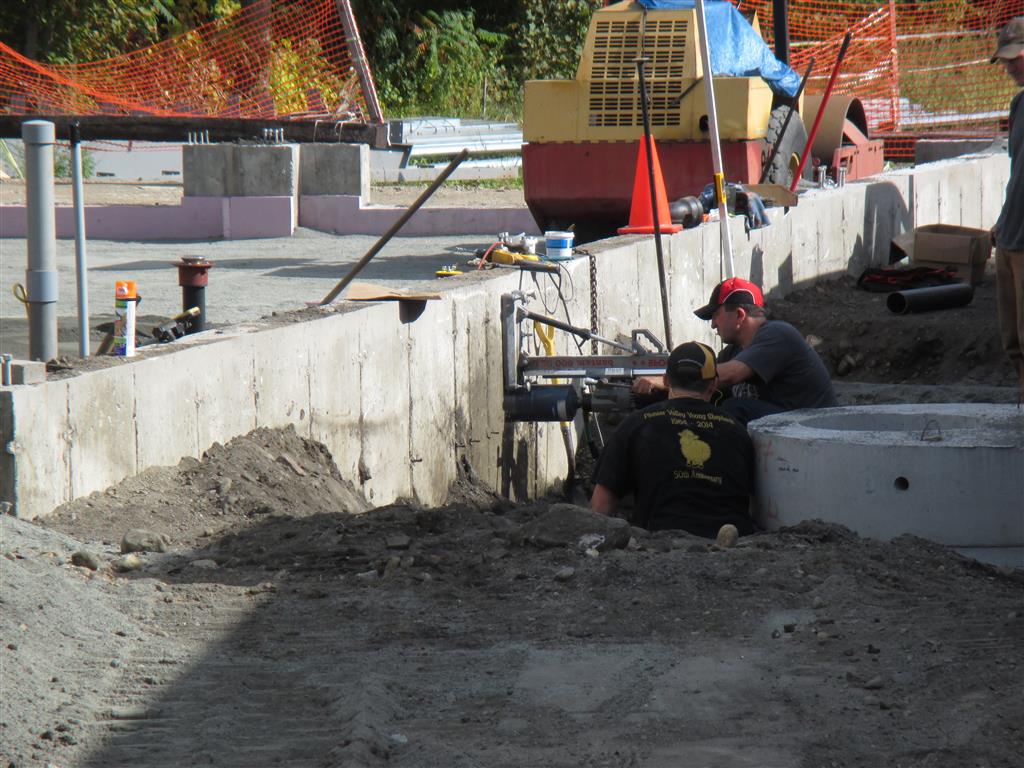

Hillman digging out the hole for the Oil/Water separator.
This allows us to connect to the town sewer without contaminating it it with any spilled oil, etc.
car barn progress
$2000 worth of concrete, buried out of sight.
car barn progress
Hartnett Plumbing drills through the wall for a vent pipe.
car barn progress

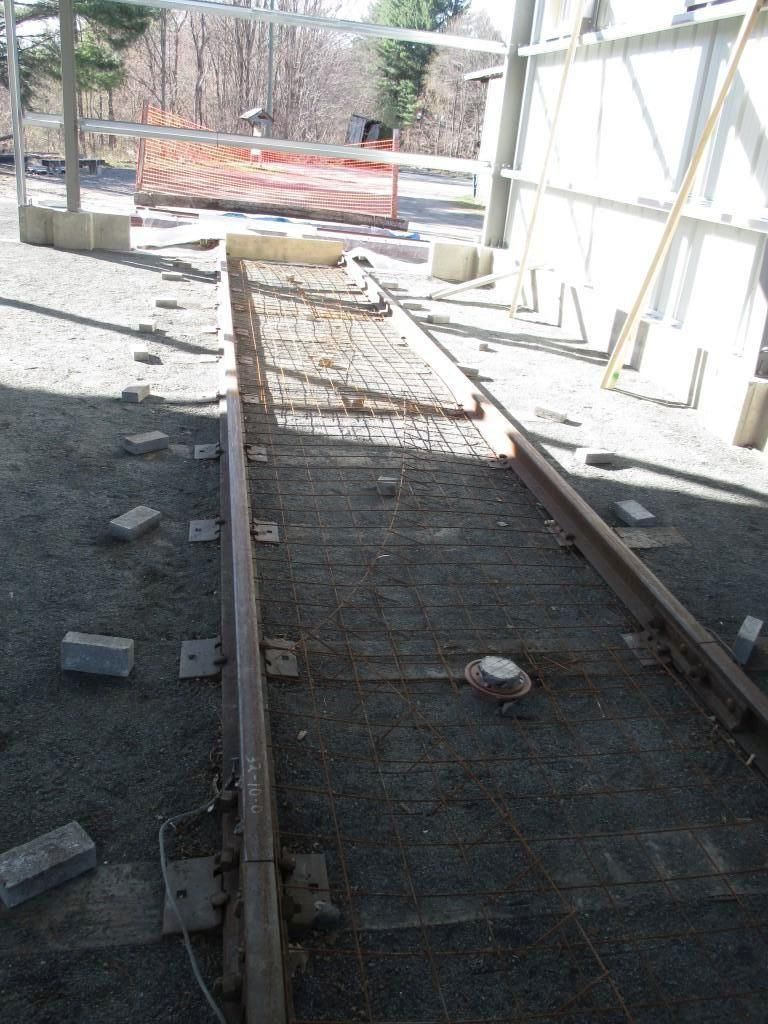

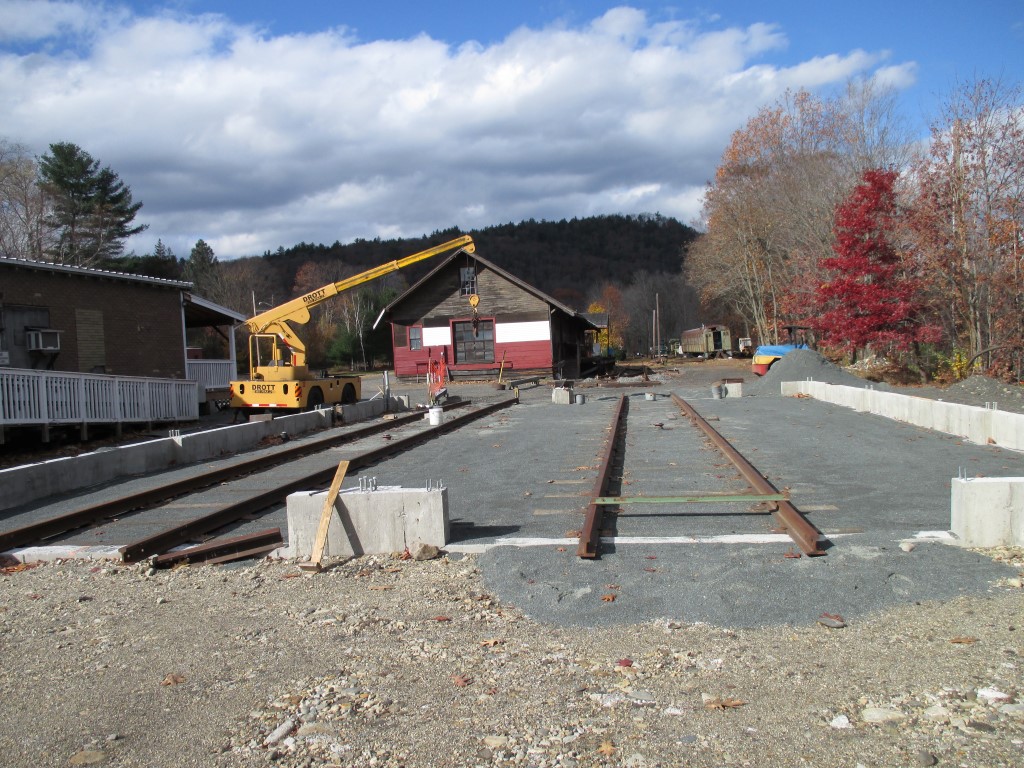

Fall 2014 - Putting in the tracks.
Everything is backfilled, compacted and "fit to be tied".
car barn progress
The protrusions in the middle are the floor drains.
car barn progress

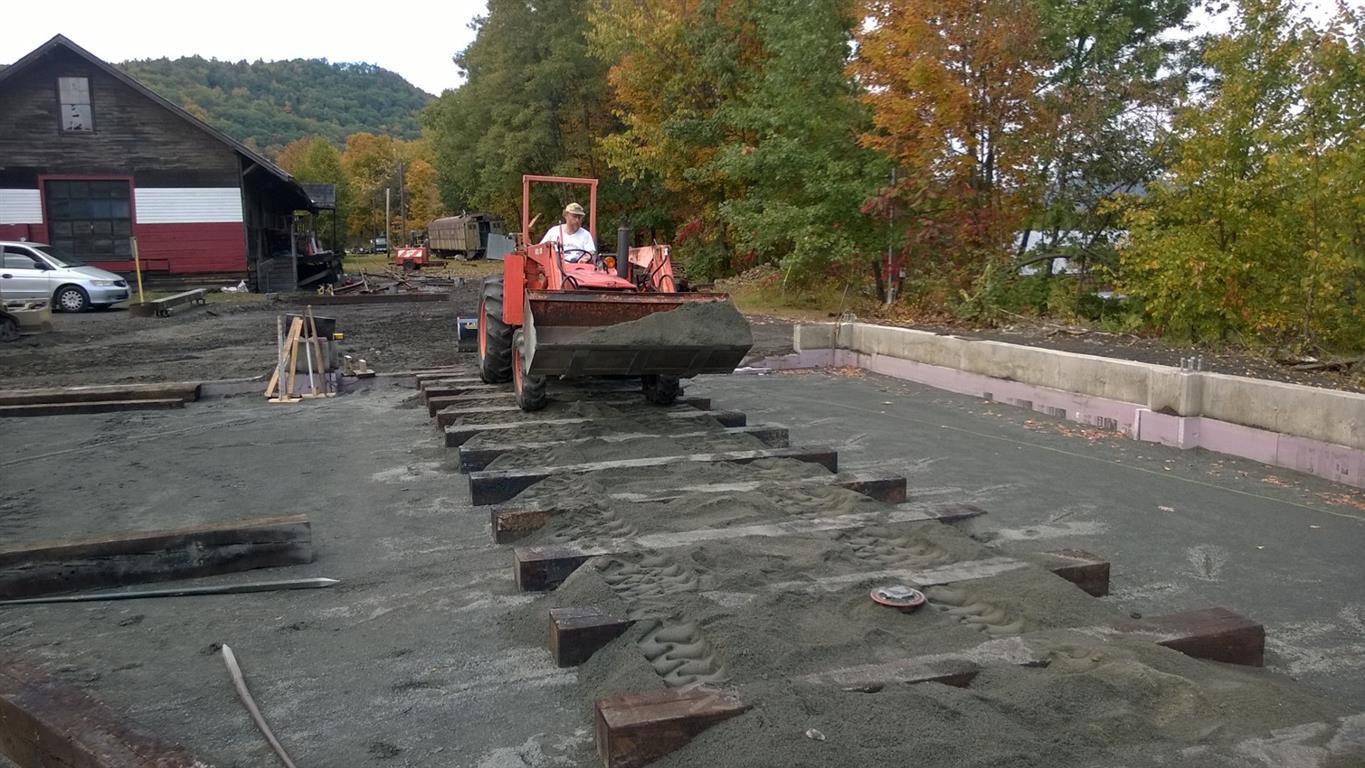

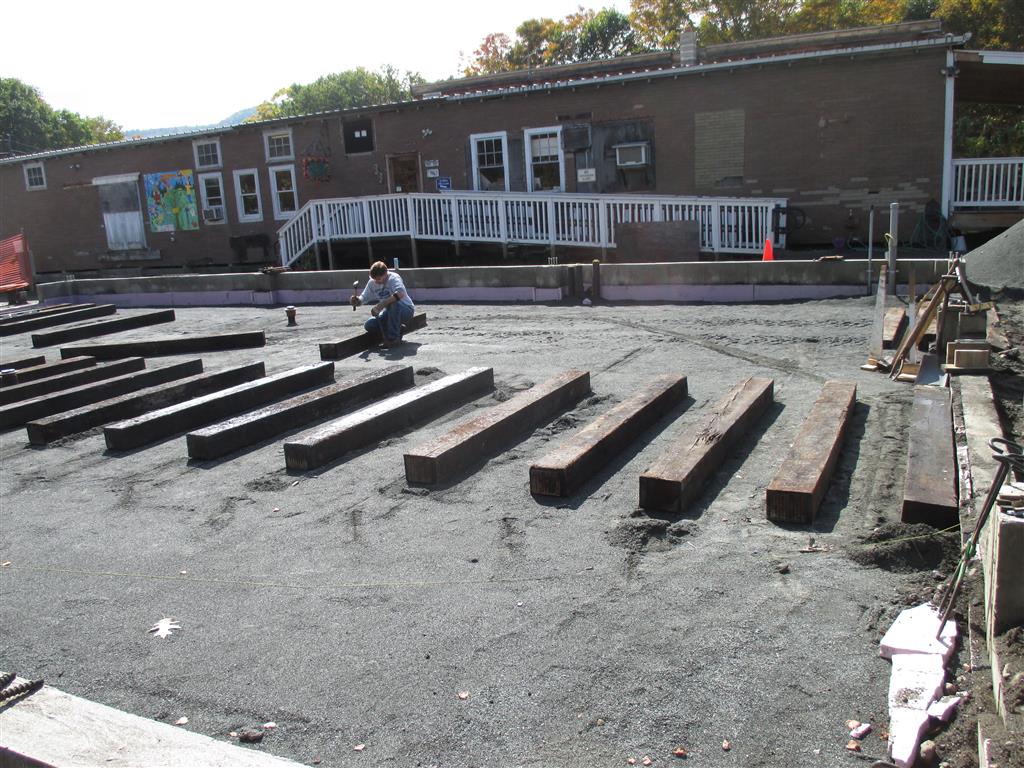

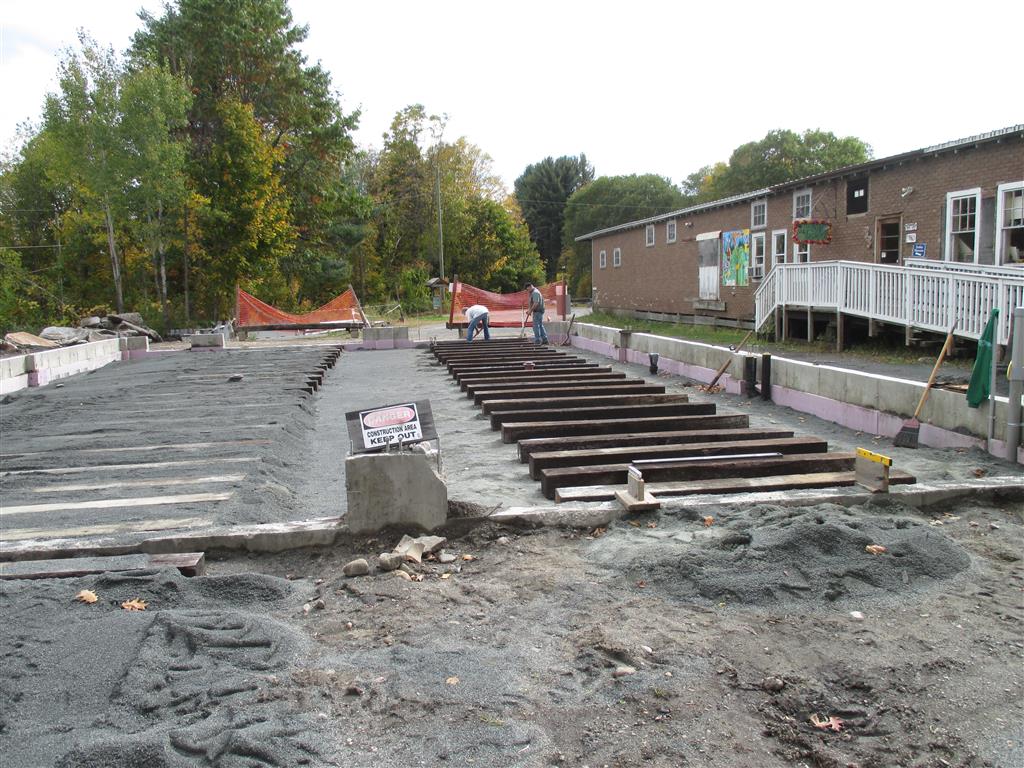

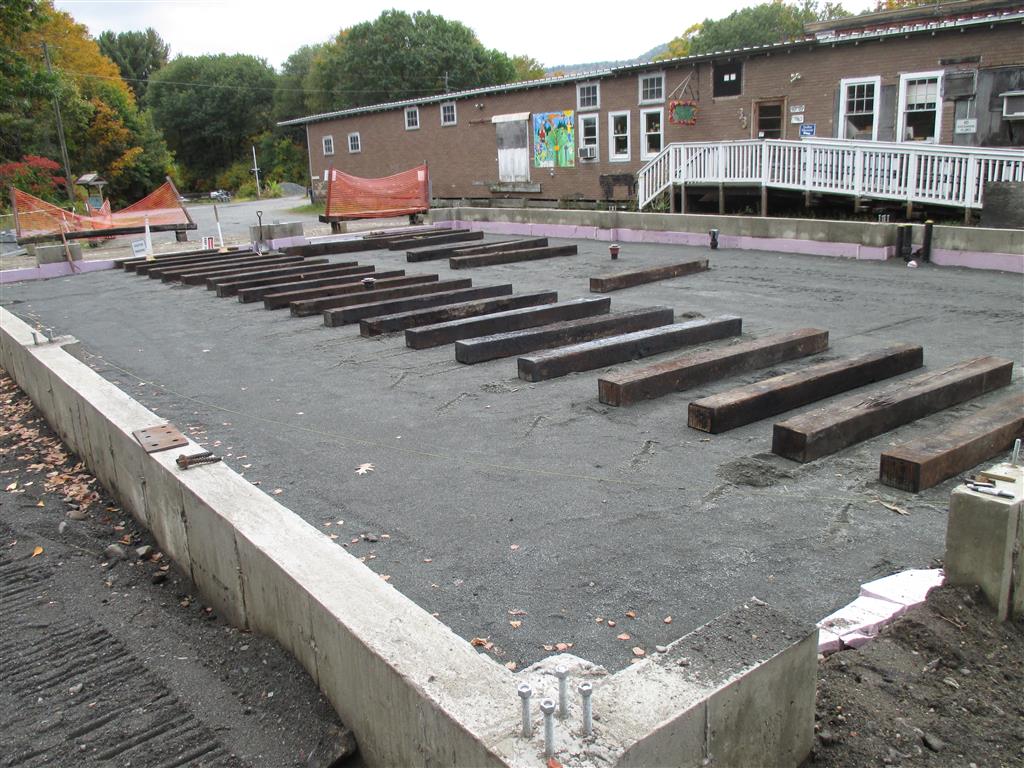

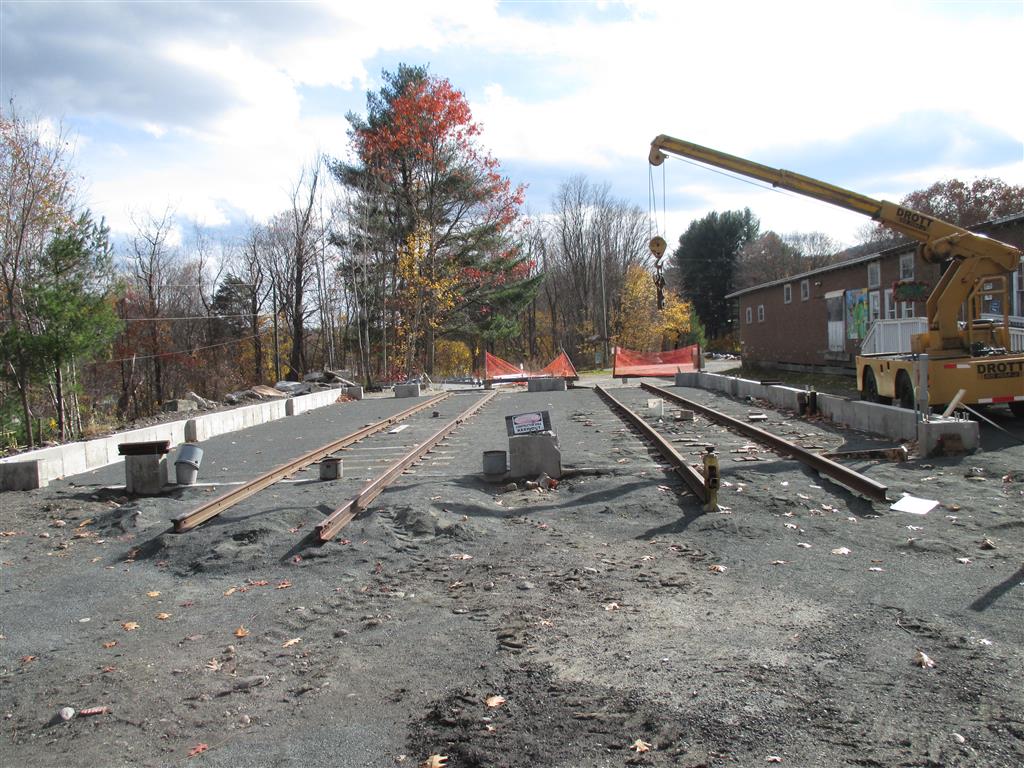

October 2014 The ties are being placed and leveled here.
car barn progress
Dave G is plugging the holes in these relay ties to lengthen their life.
car barn progress
The opening in the rear wall allows us to extend the building in the future.
car barn progress
The tractor makes easy work of backfilling the ties with stone dust.
car barn progress
The ties are backfilled on the left track, the right track is nearly ready for backfilling.

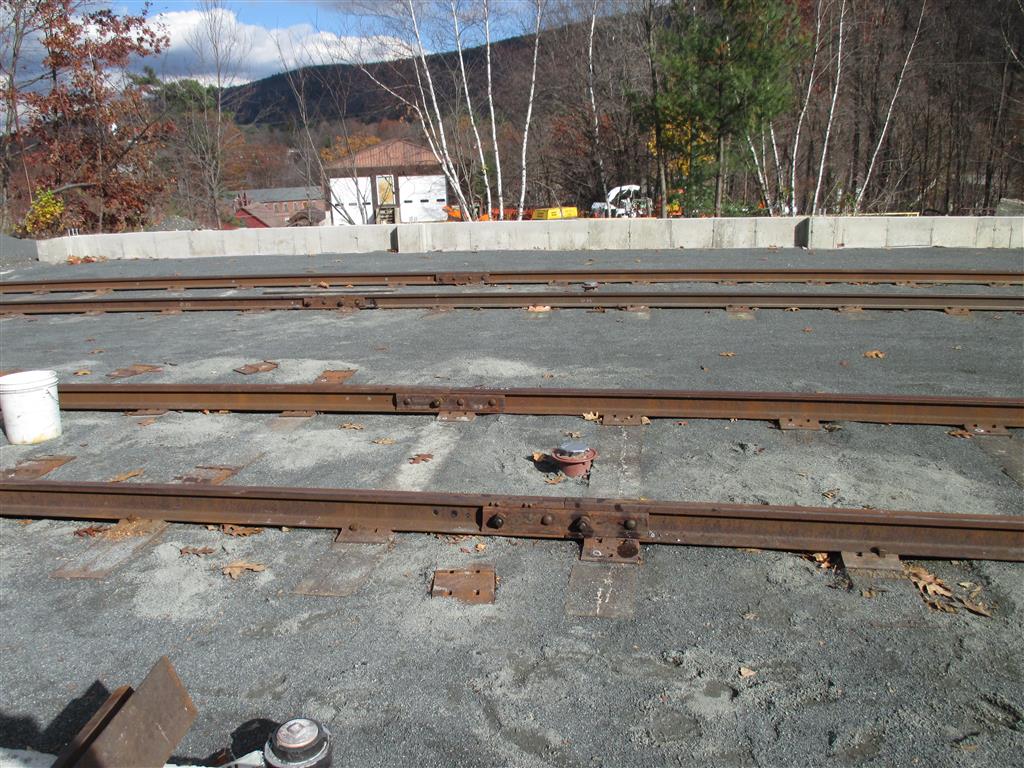

car barn progress

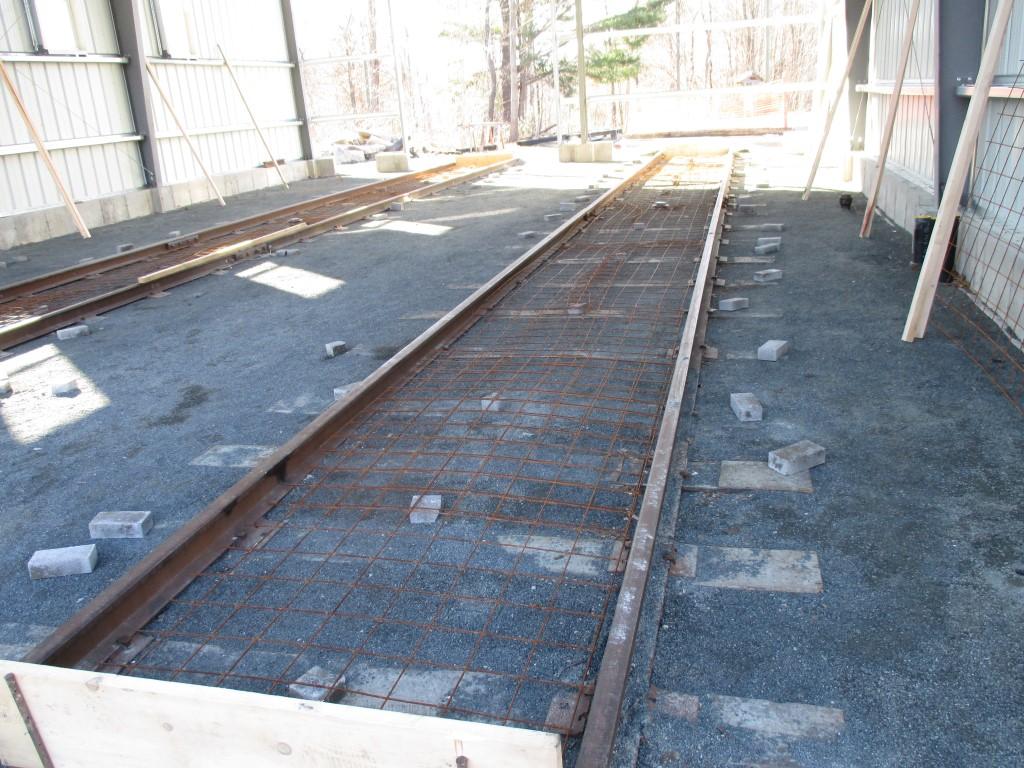

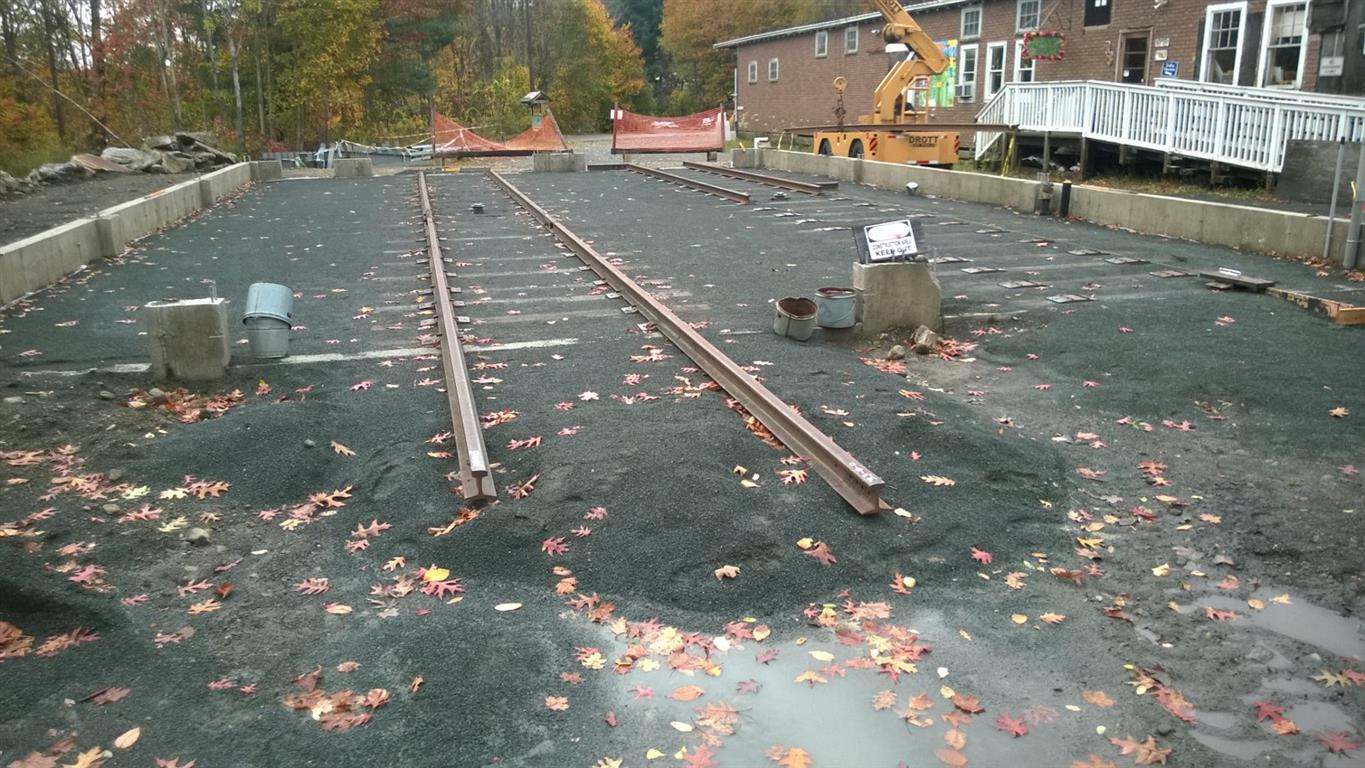

Both tracks are now ready for tie plates and rails to be installed.
car barn progress
Meanwhile, we've also been building a turnout to connect the House Track to the Car Barn approach tracks, with another turnout for the eventual Loop Track.
car barn progress
The tie plates are in place, the first rails are ready to be placed.
car barn progress

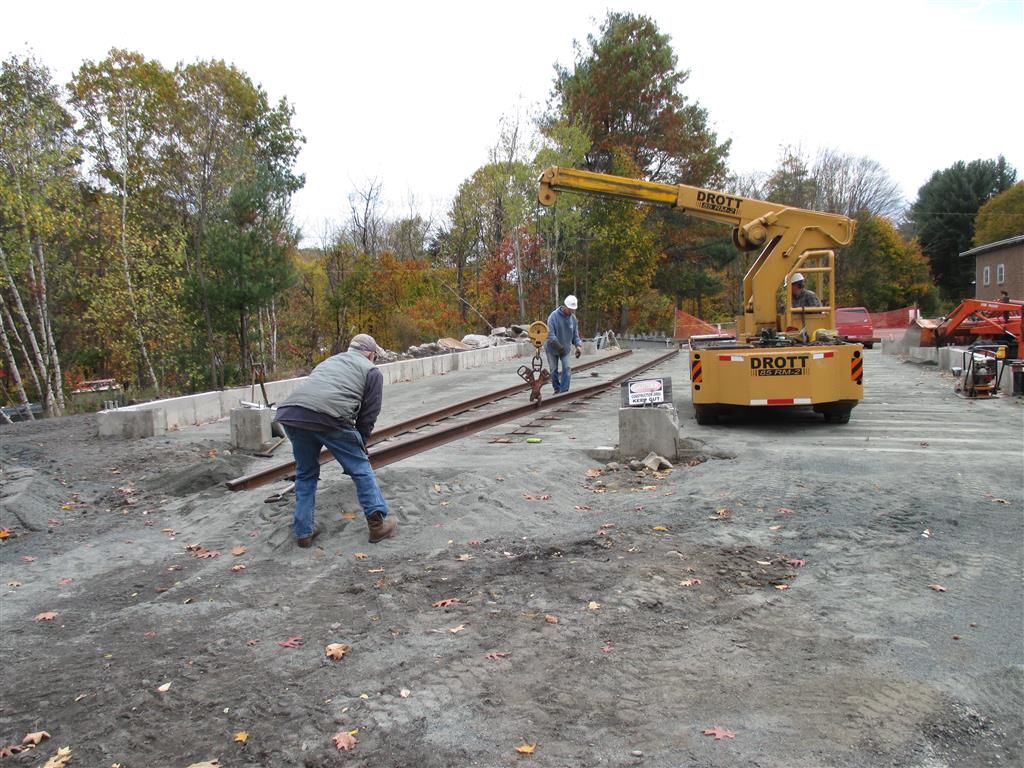

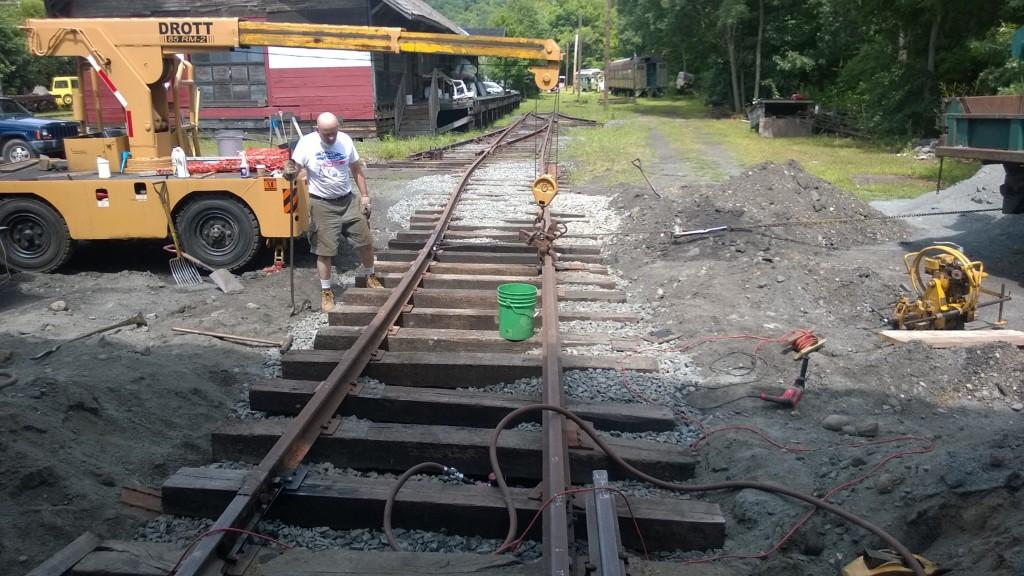

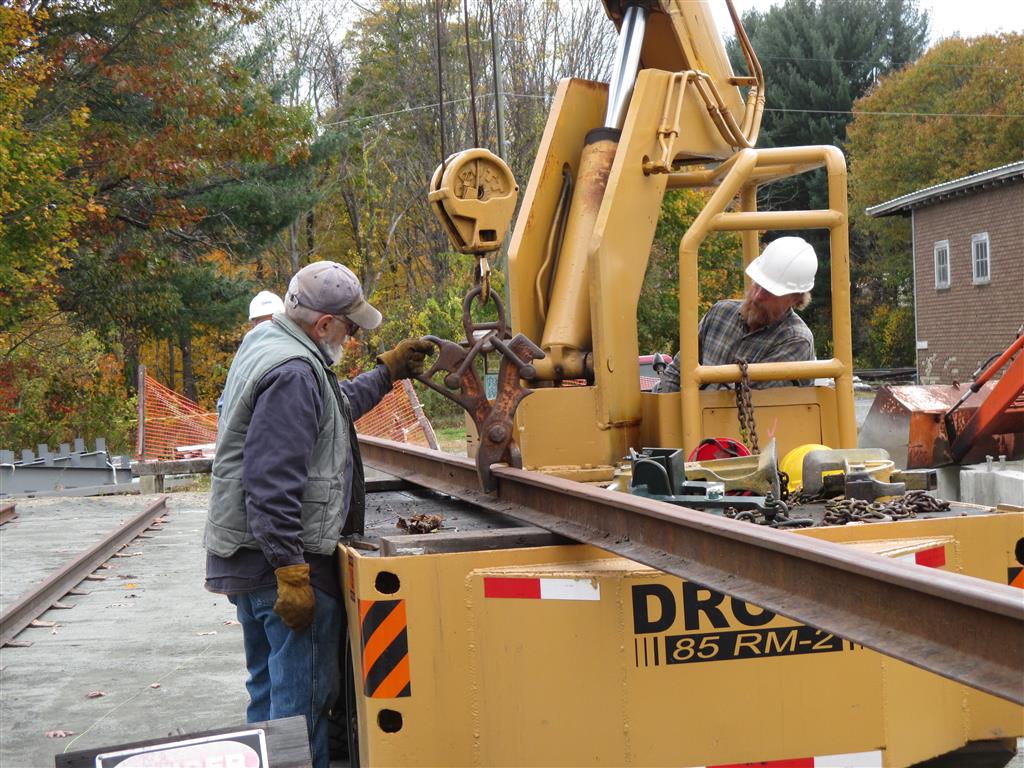

Tom, Larry and Sam putting in rails.
car barn progress
The Drott has sure come in handy for this job.
car barn progress
The trick is to get the rail down without moving the tie plates too much.
car barn progress
The rails extend from the Car Barn so they can be connected to the approach tracks.
car barn progress
car barn progress
Four rails down, four to go, plus a lot of spiking!
car barn progress
The second track has begun.
car barn progress
The House Track will make a 3 foot S-curve to align with the Stall One track.
car barn progress

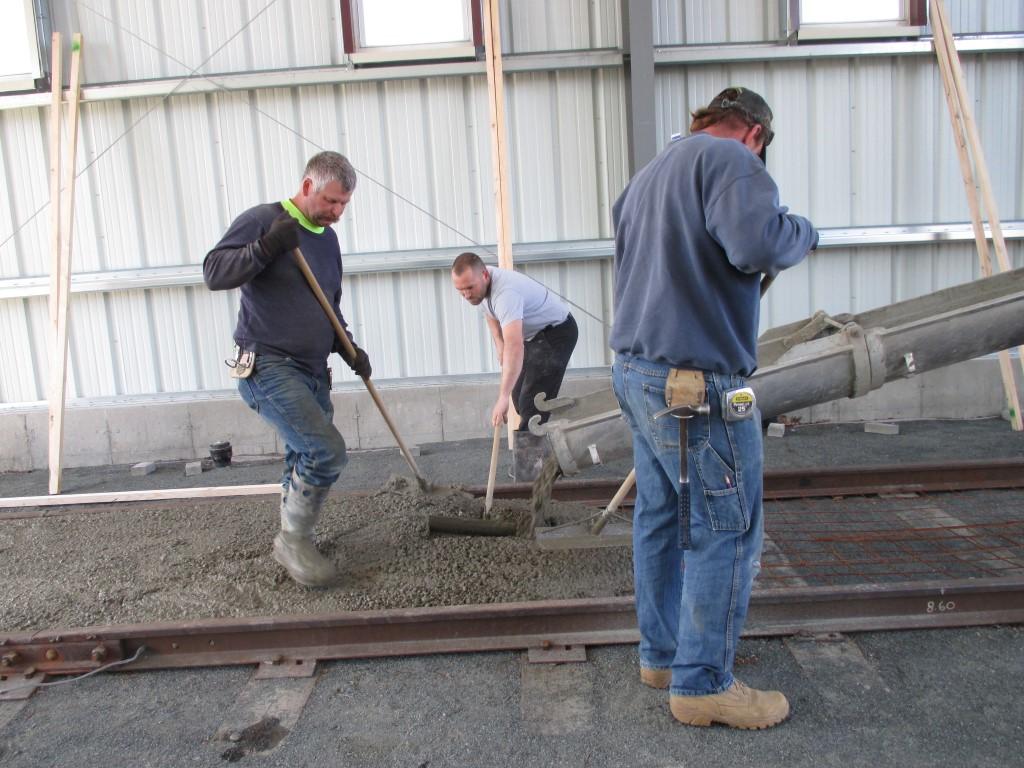

Nov 2014 All spiked and ready for concrete.
car barn progress
Bond wires will be installed before these joints have concrete poured around them.
car barn progress
Winter is approaching...
car barn progress

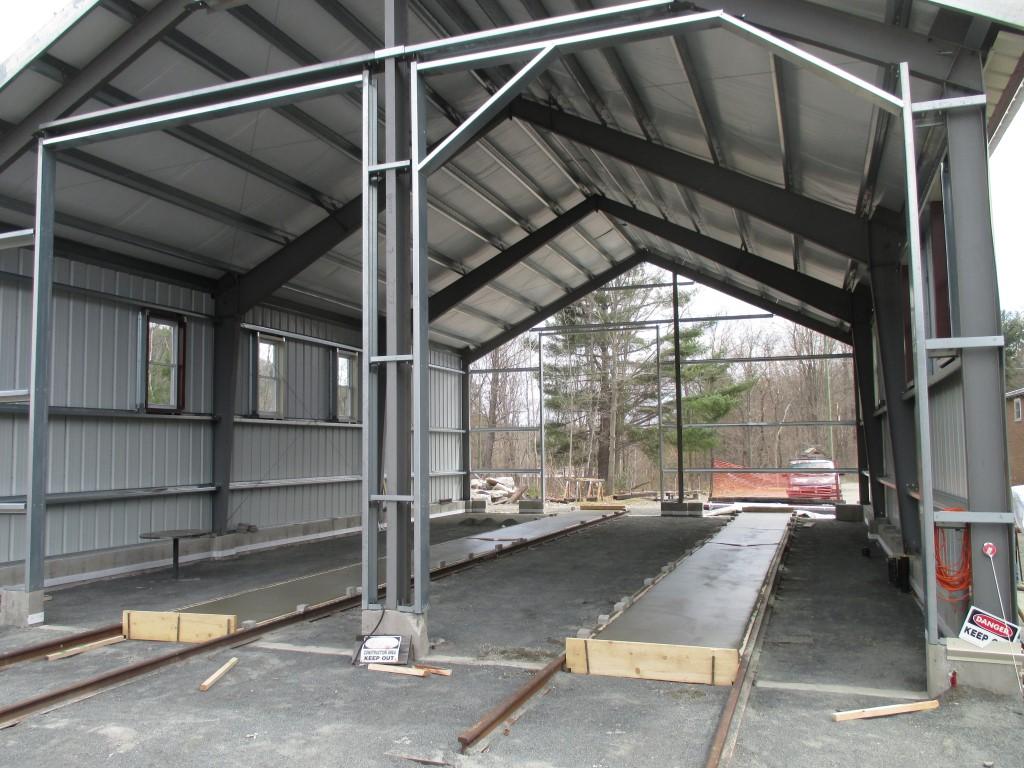

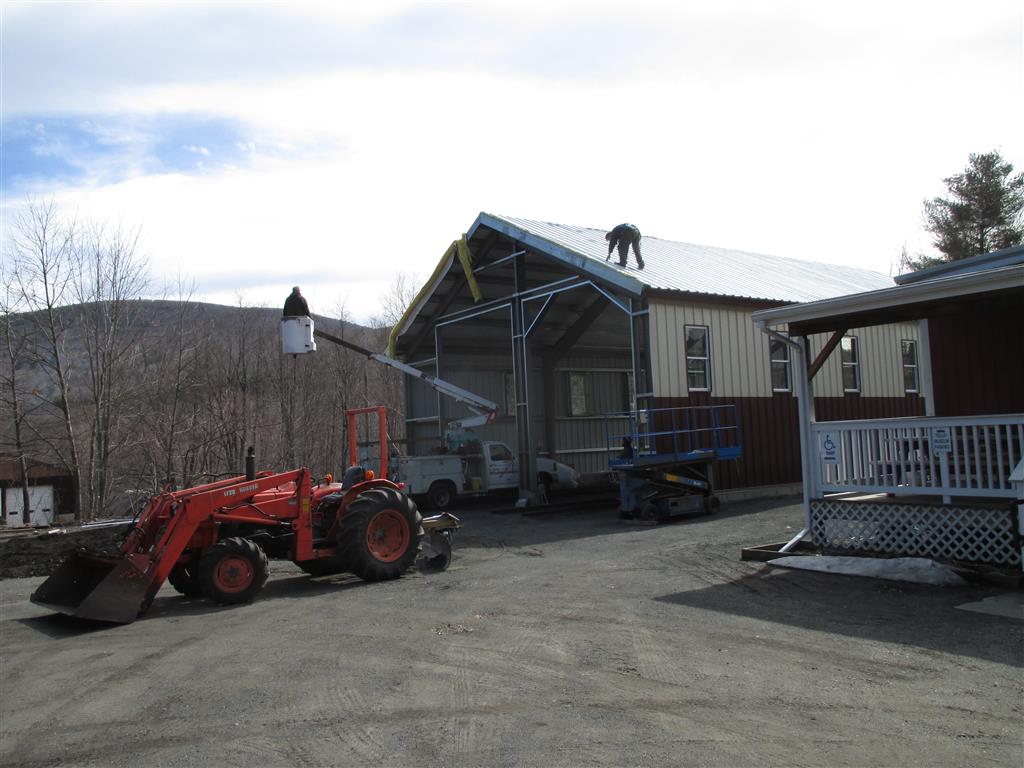

Winter 2014 - Putting up the building frame.
It is too cold now to pour concrete for the floor, so we'll put up the building next.

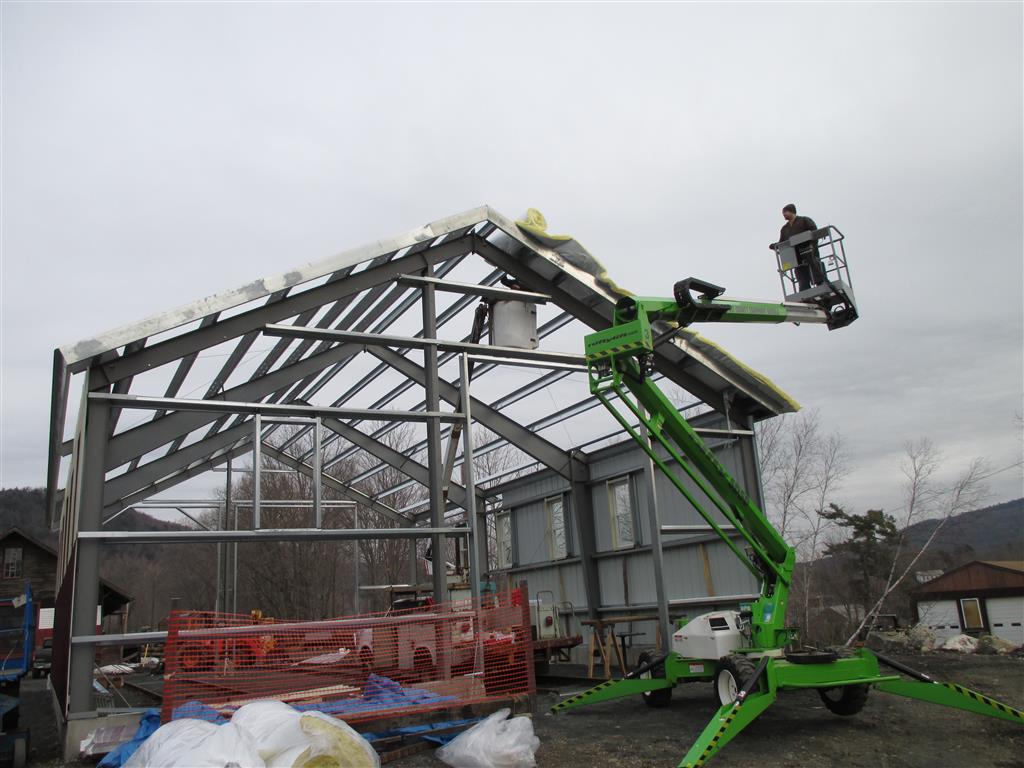

car barn progress

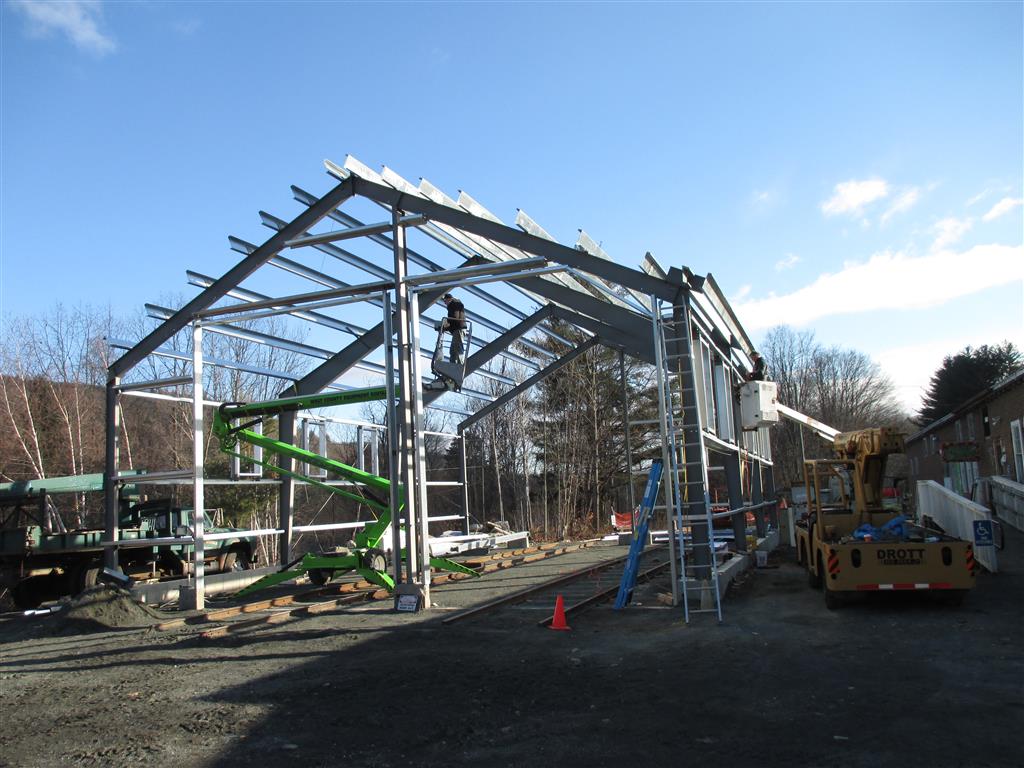

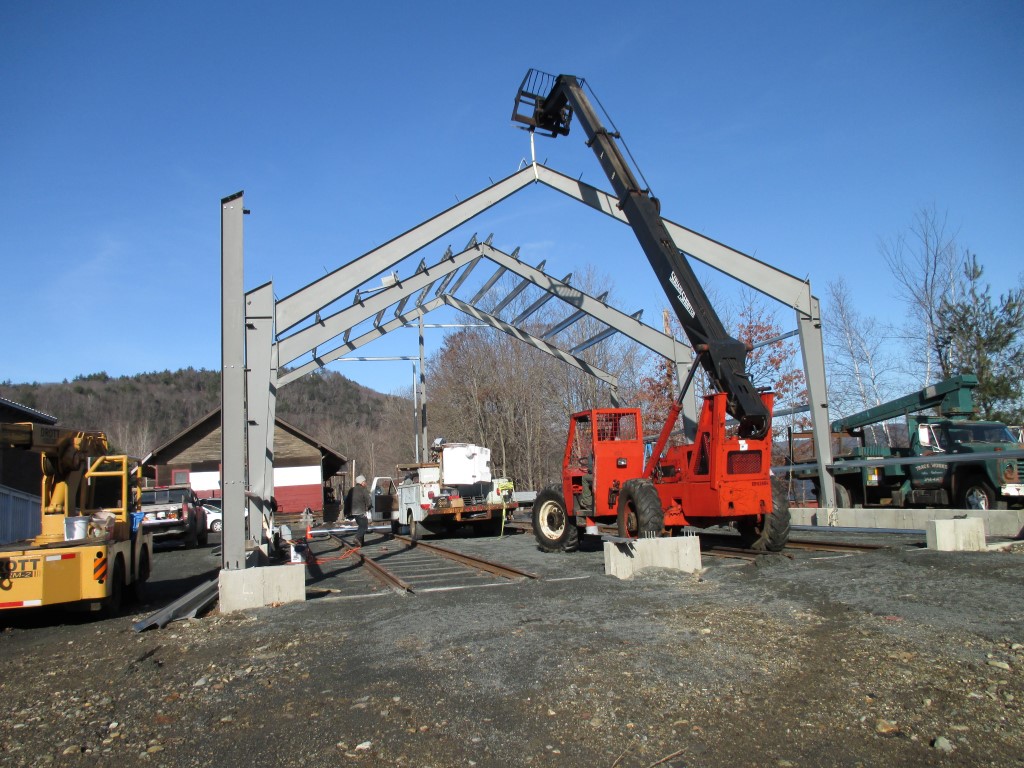

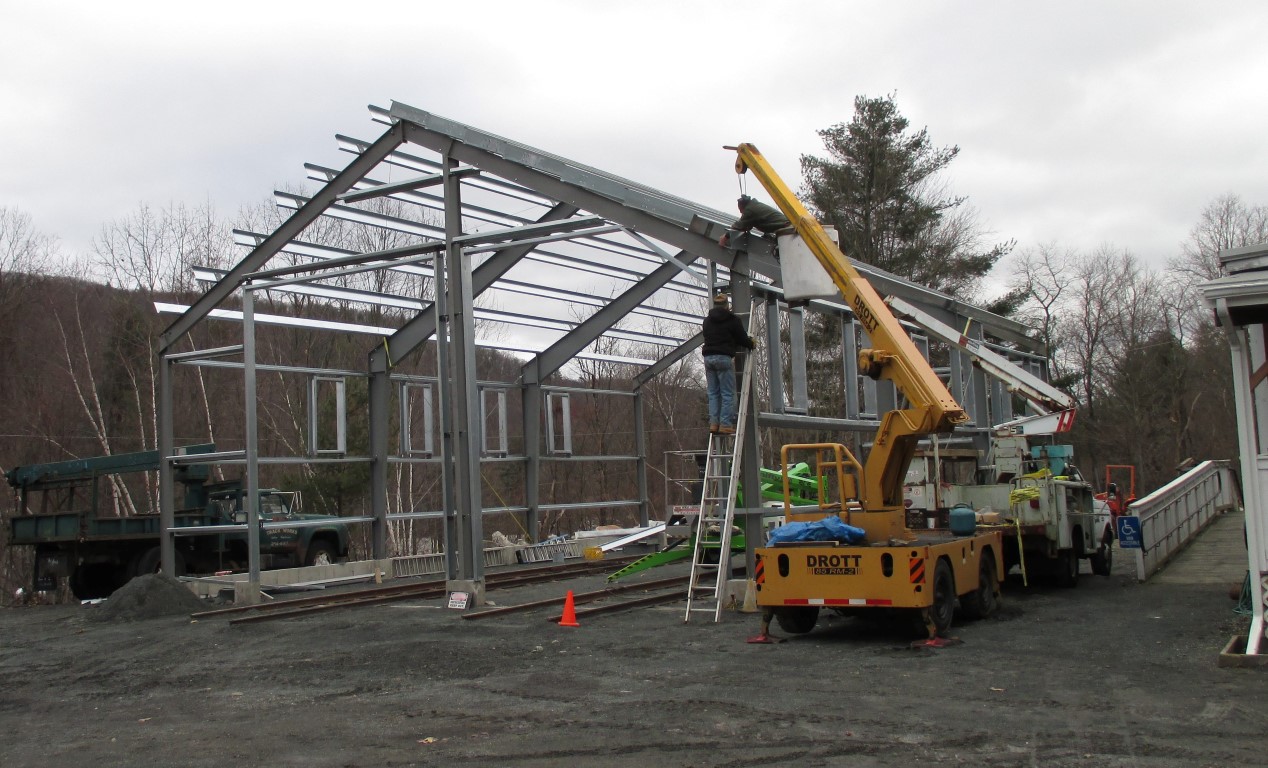

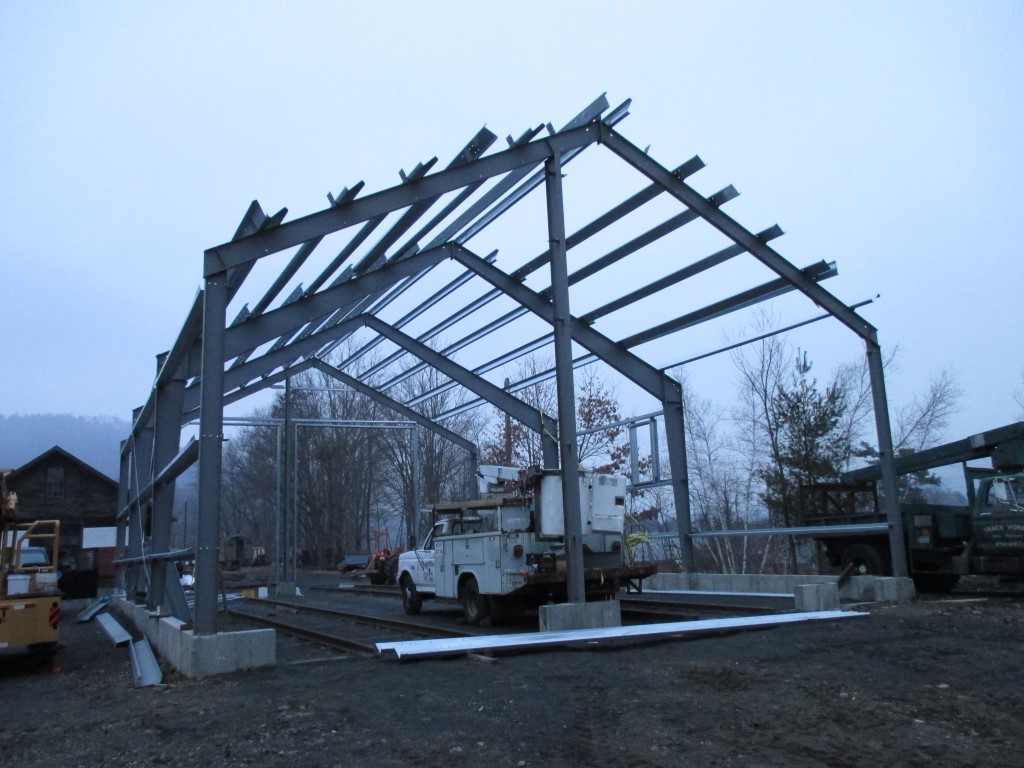

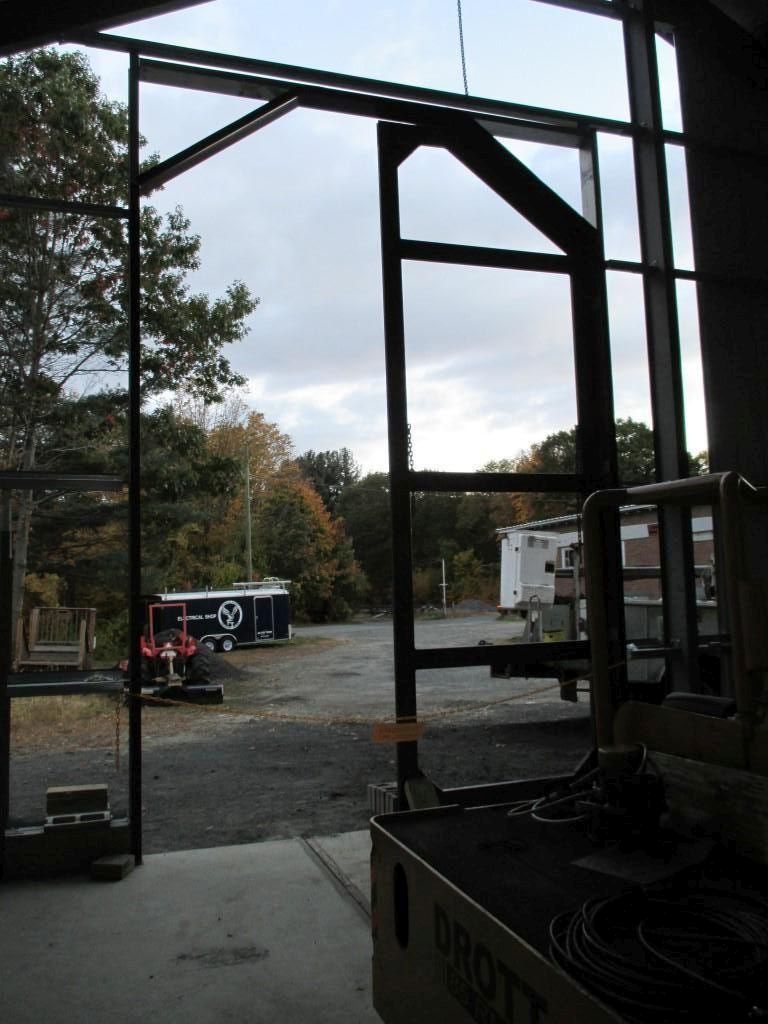

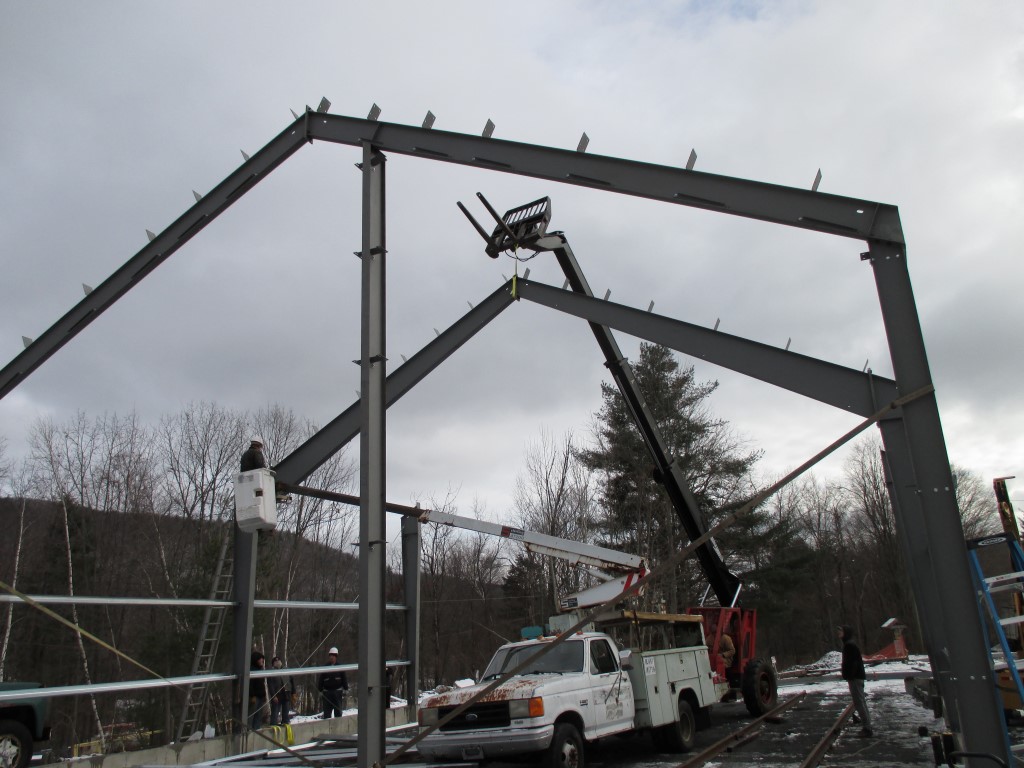

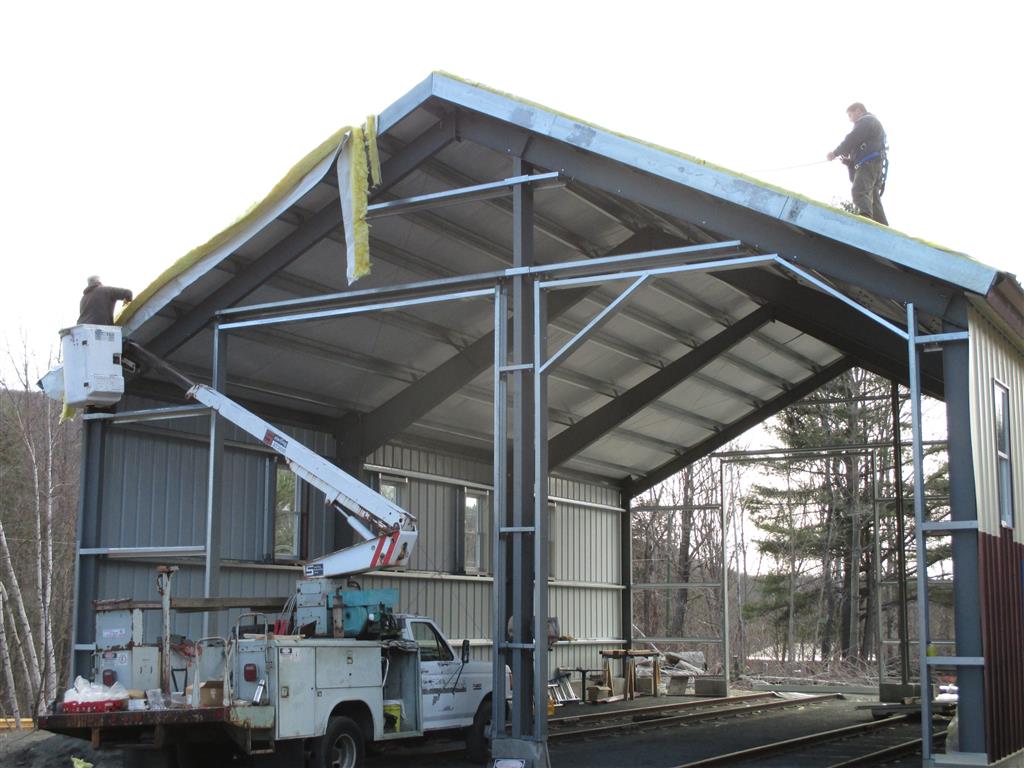

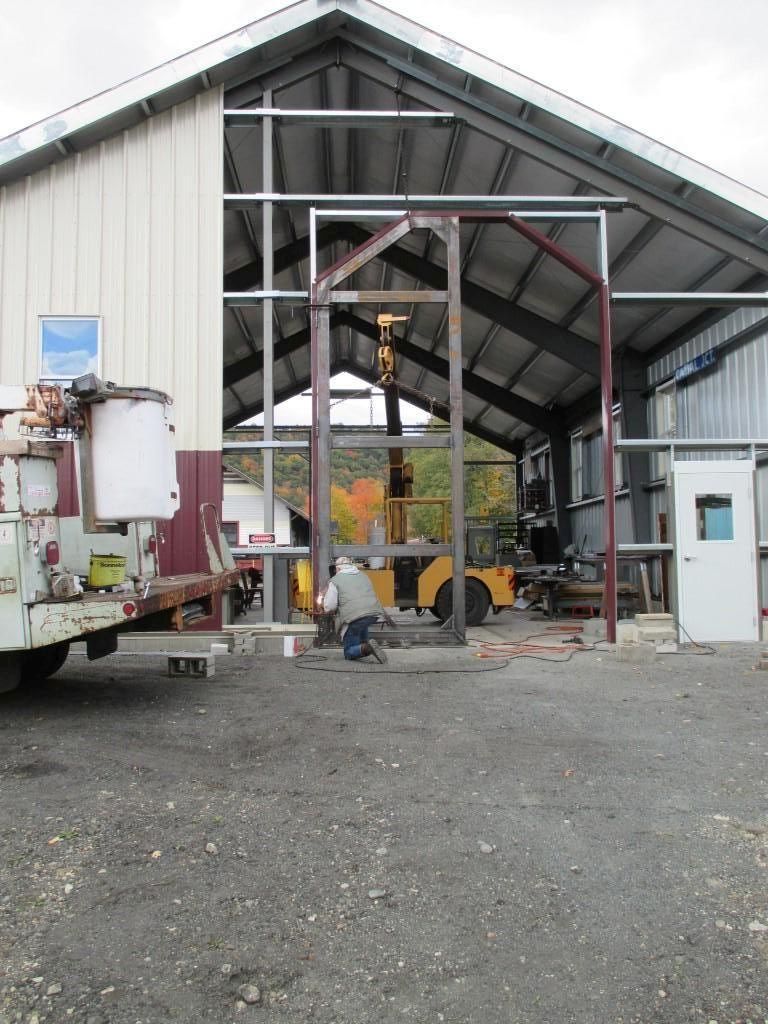

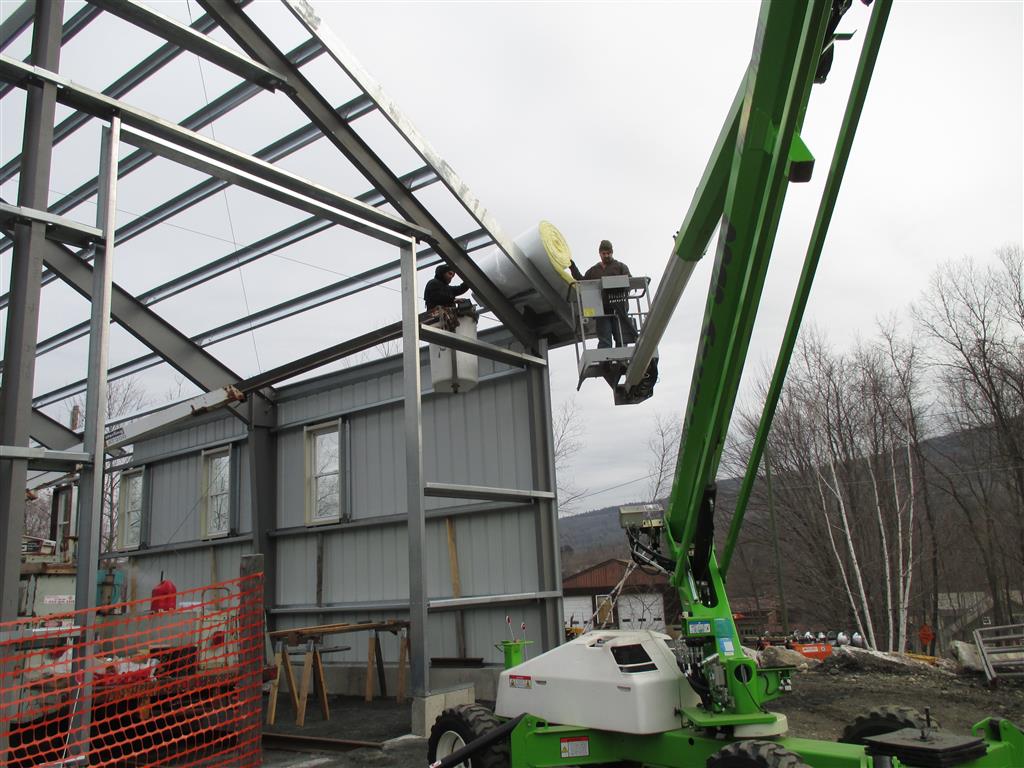

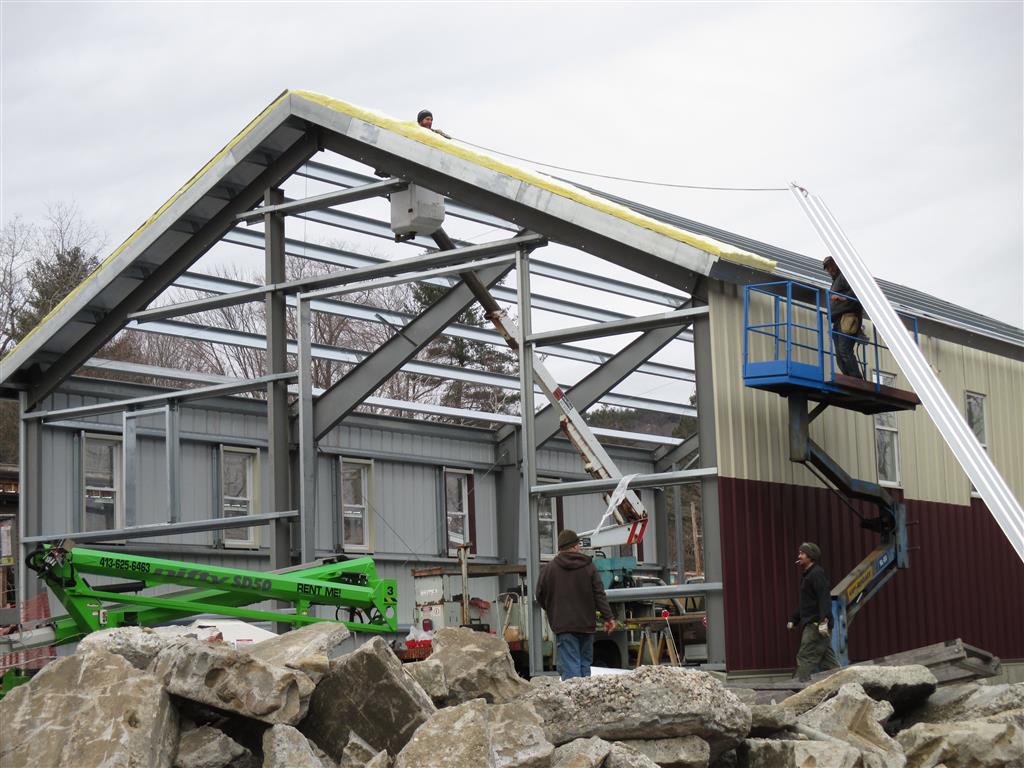

Dec 2014 The columns are placed, ready to go up, and the roof arches are bolted together.
car barn progress
Here is two bays of the frame up, thanks to Mike Skalski for his help with his tele-handler lift.
car barn progress
Third frame going up, purlins installed on the first bay.
car barn progress

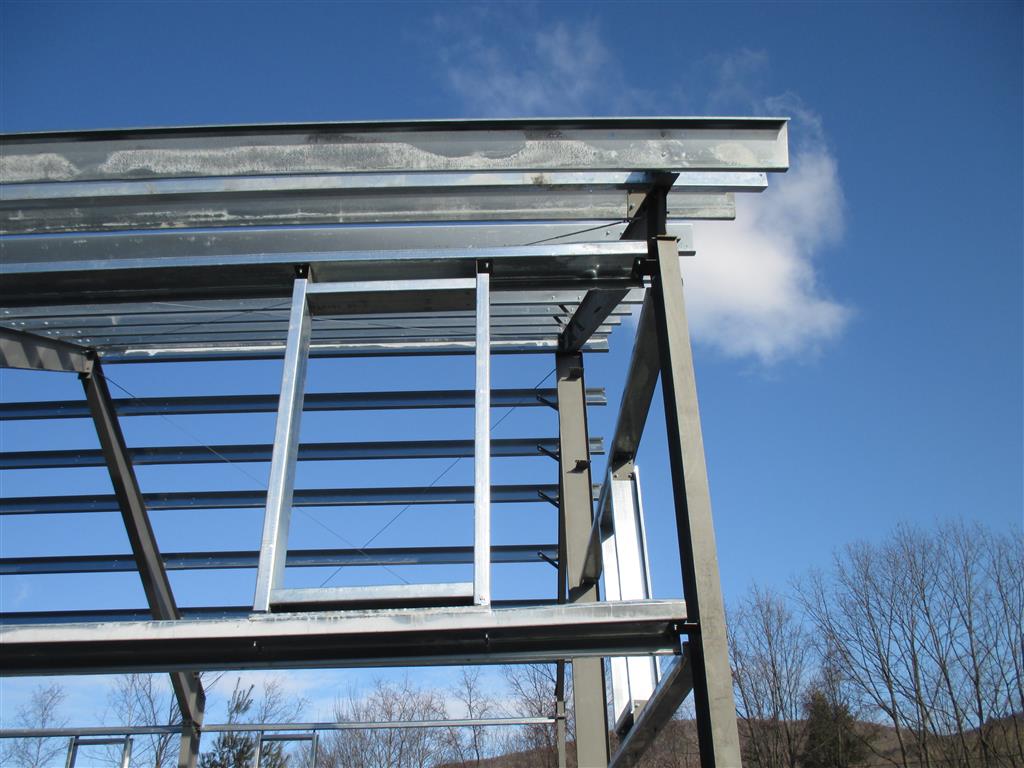

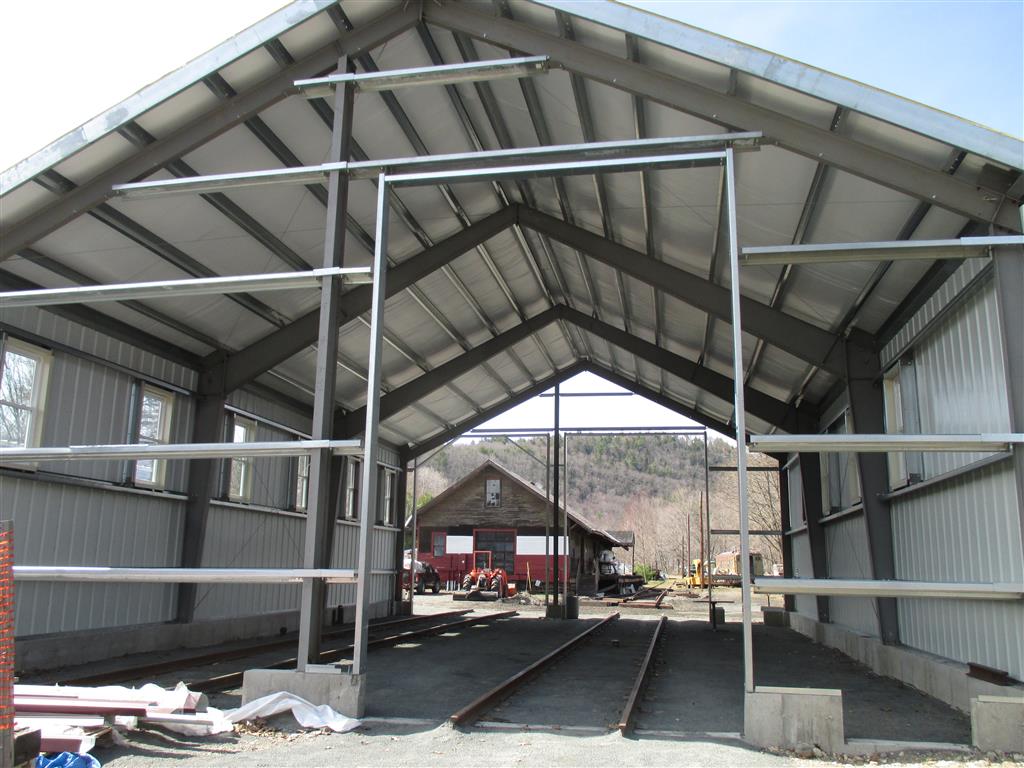

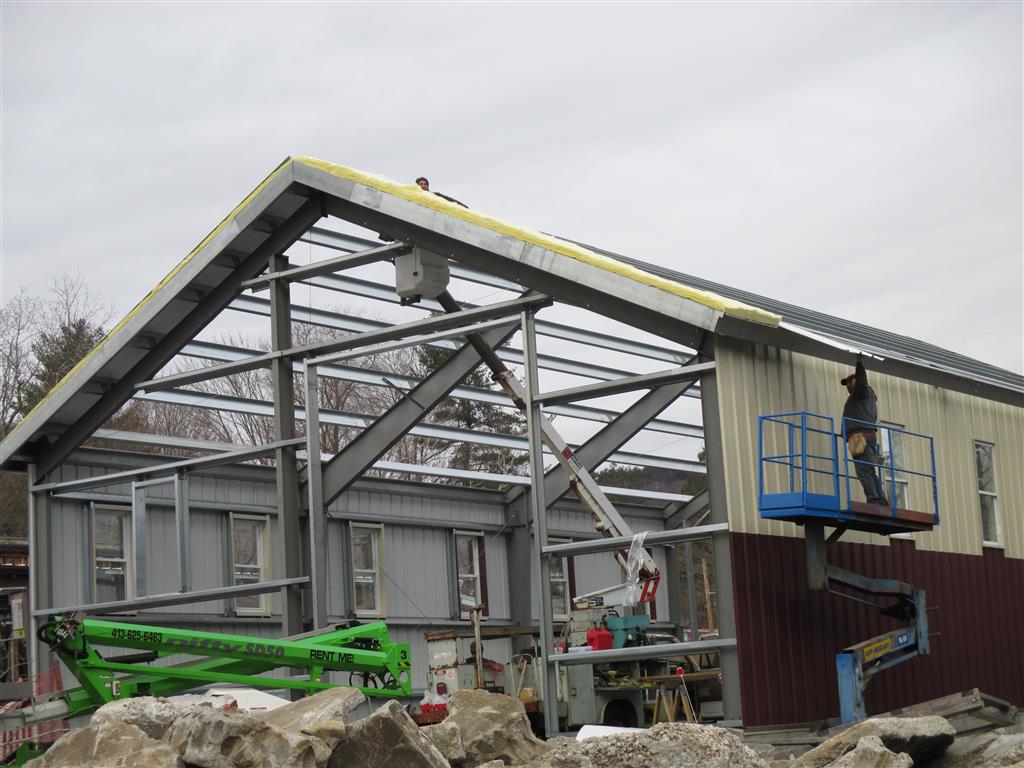

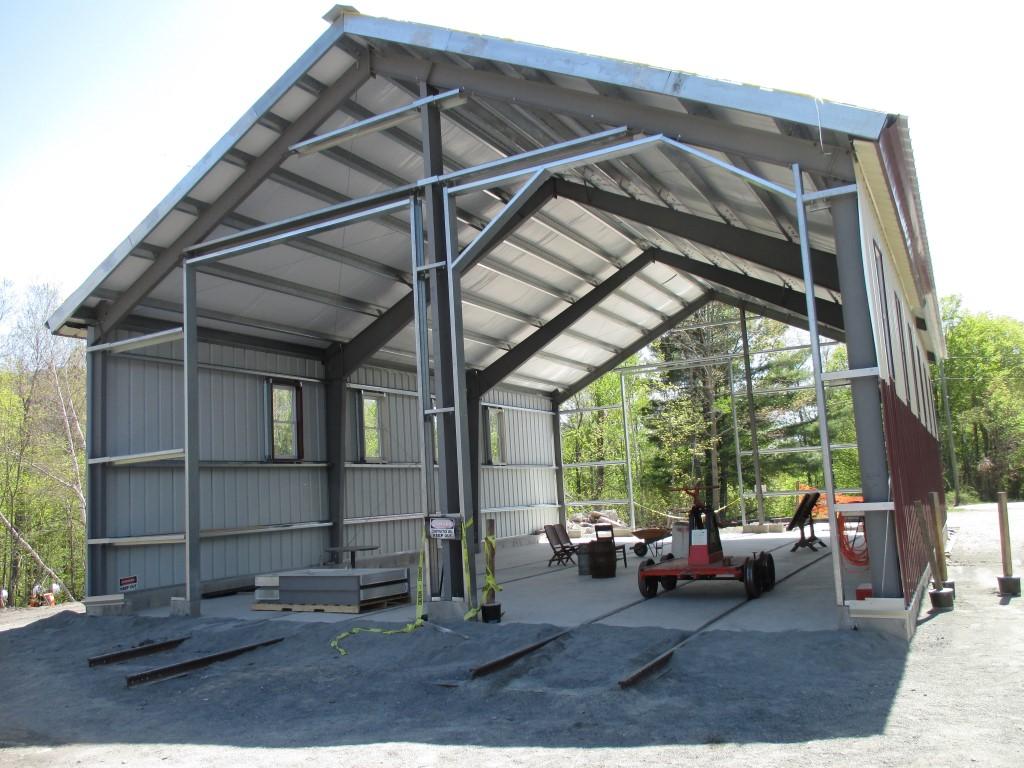

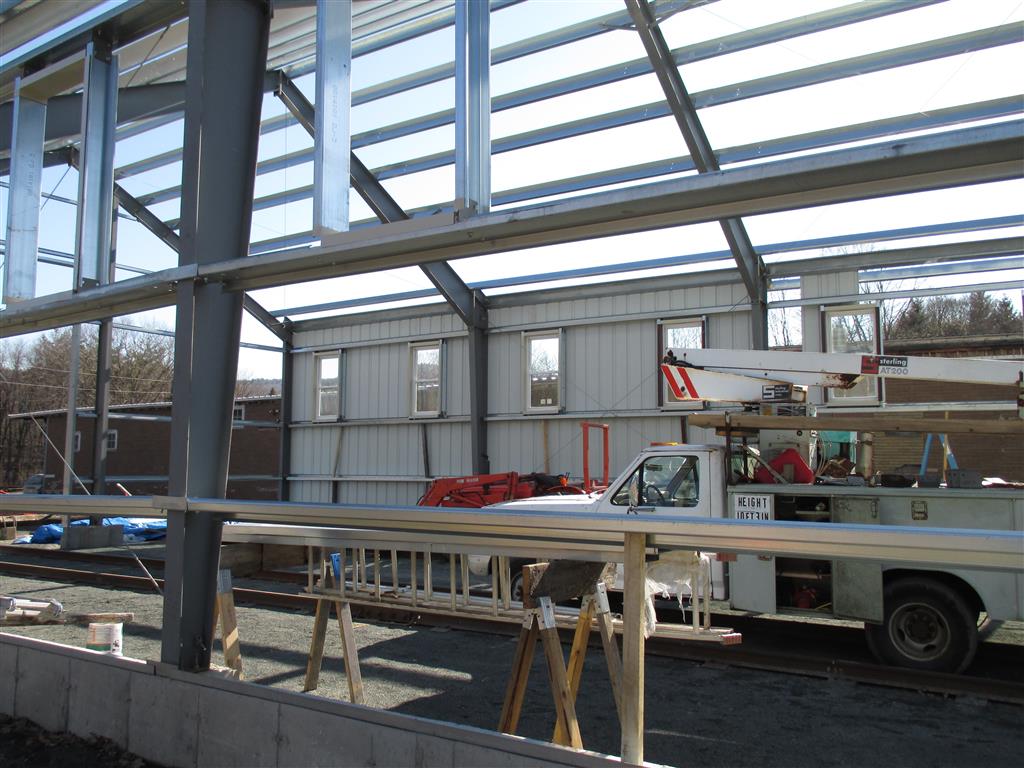

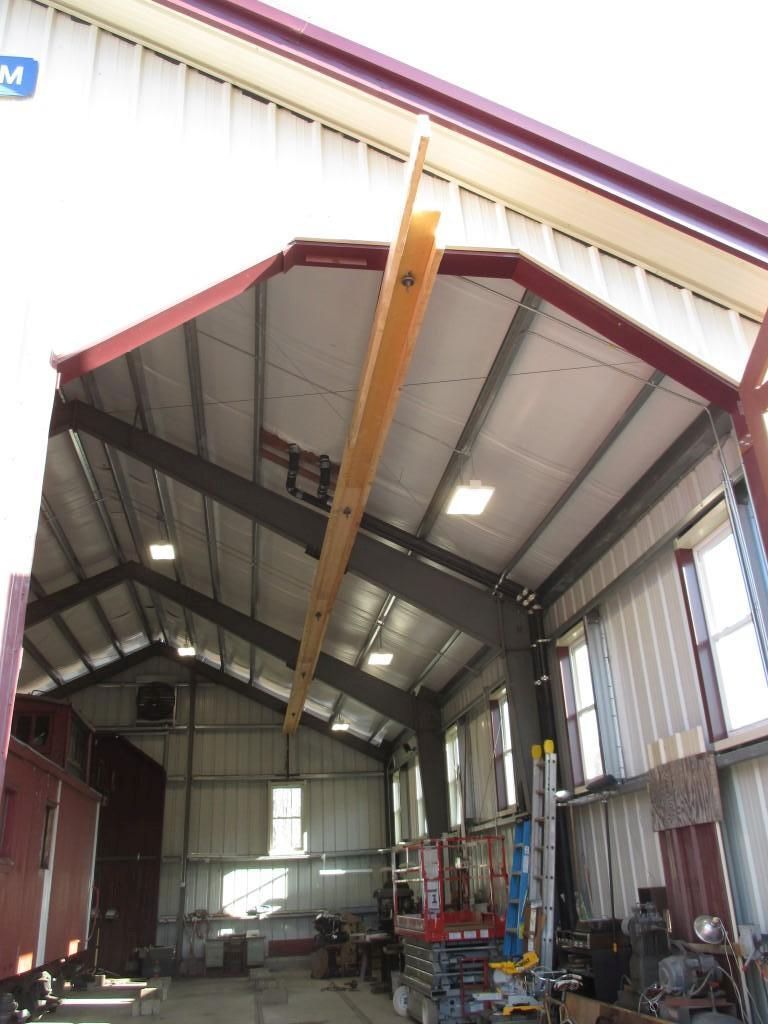

All the frames are up, the purlins are installed or in place, the end wall framing has begun.
car barn progress

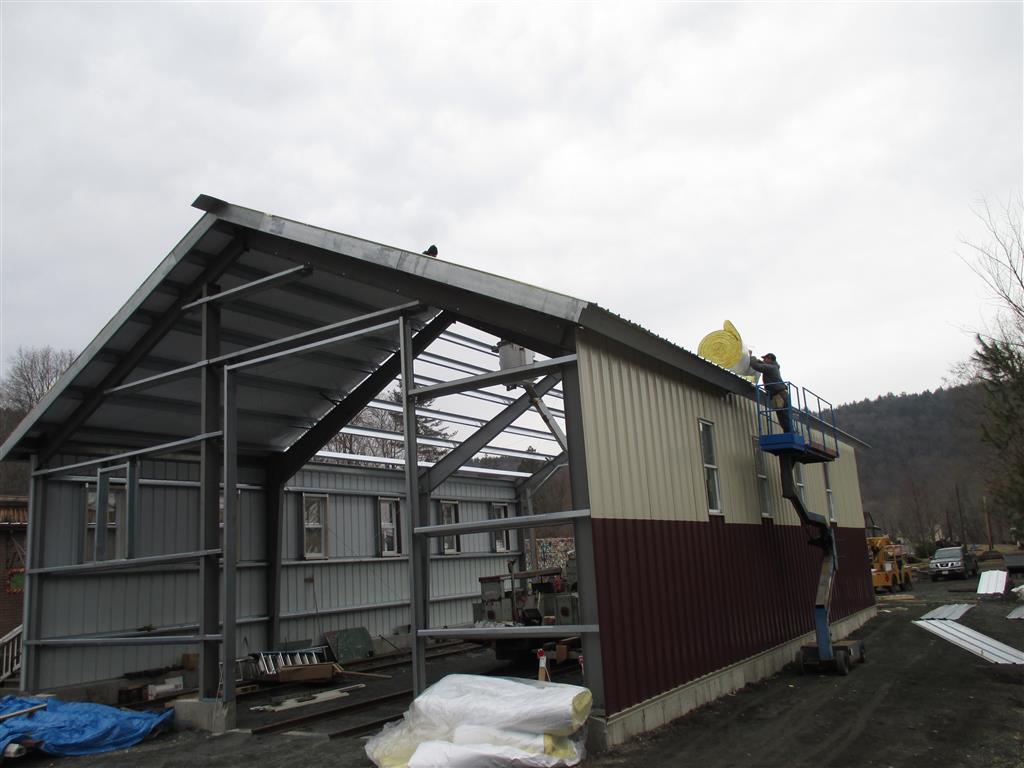

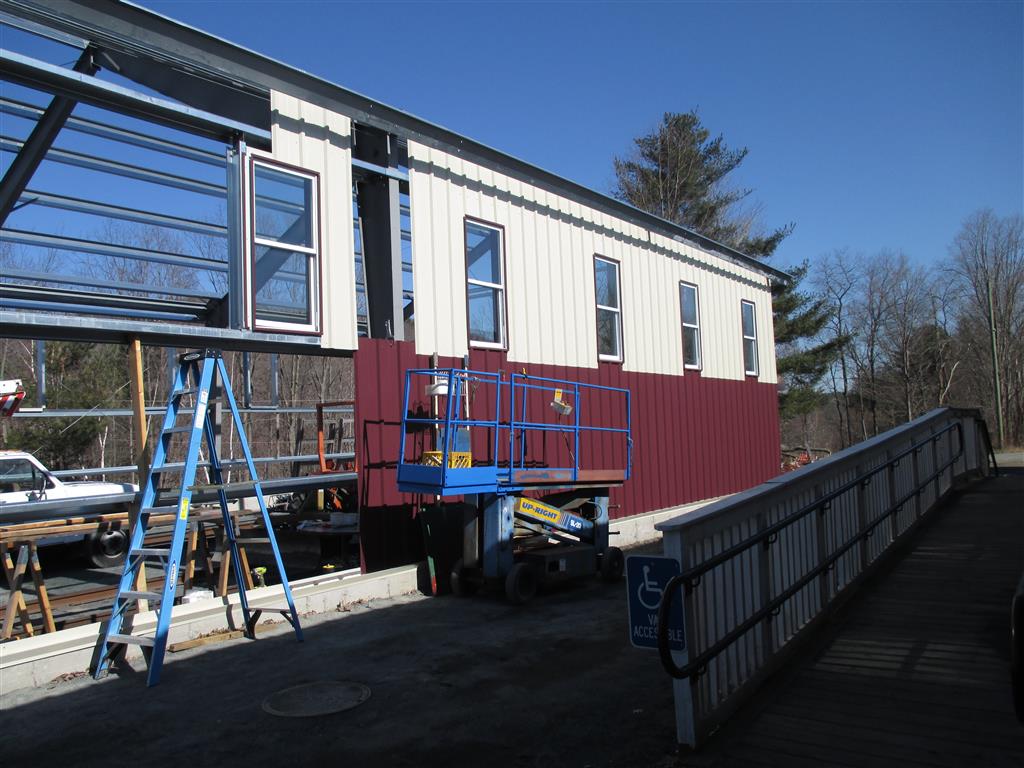

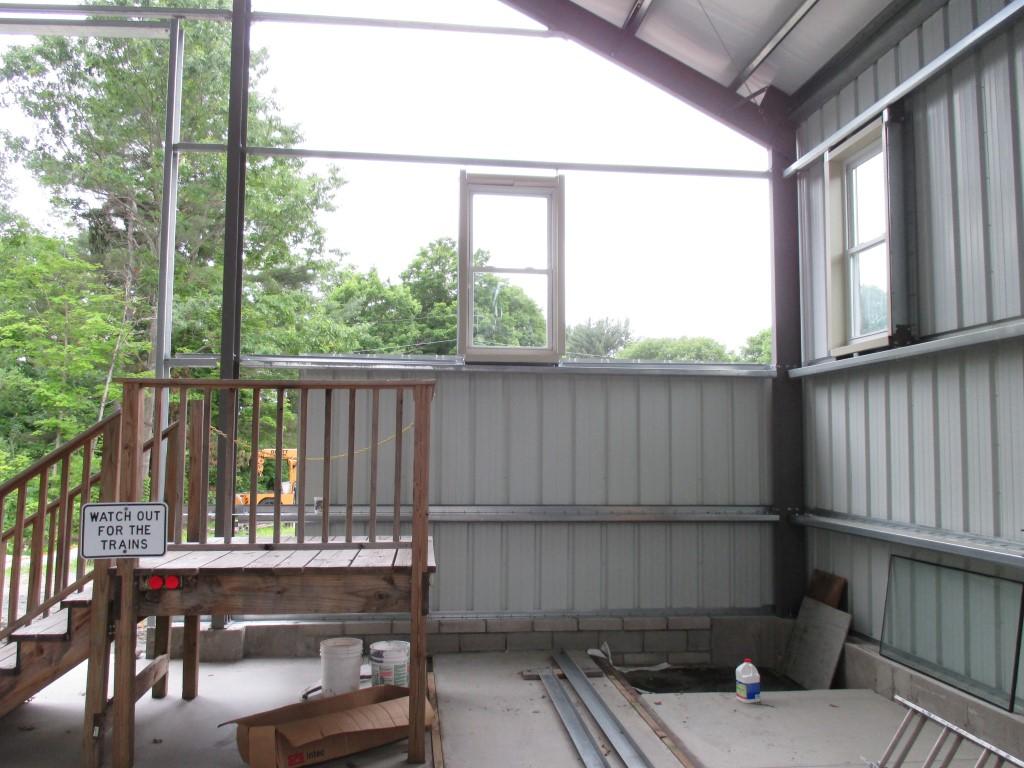

The window frames are in, the eave extensions are being installed.
car barn progress
All the work is up in the air at this point.
car barn progress
There are a lot of bolts in this building.

Spring 2015

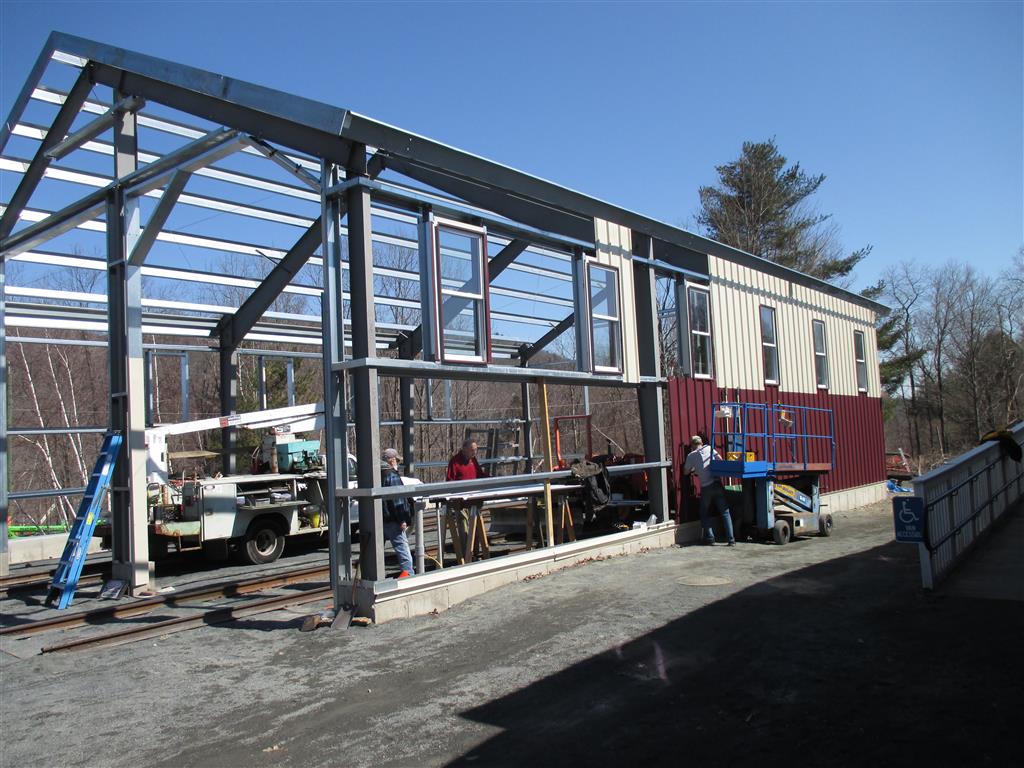

Cutting, installing and screwing on the siding sheets, installing the windows, putting on the roof. car barn progress

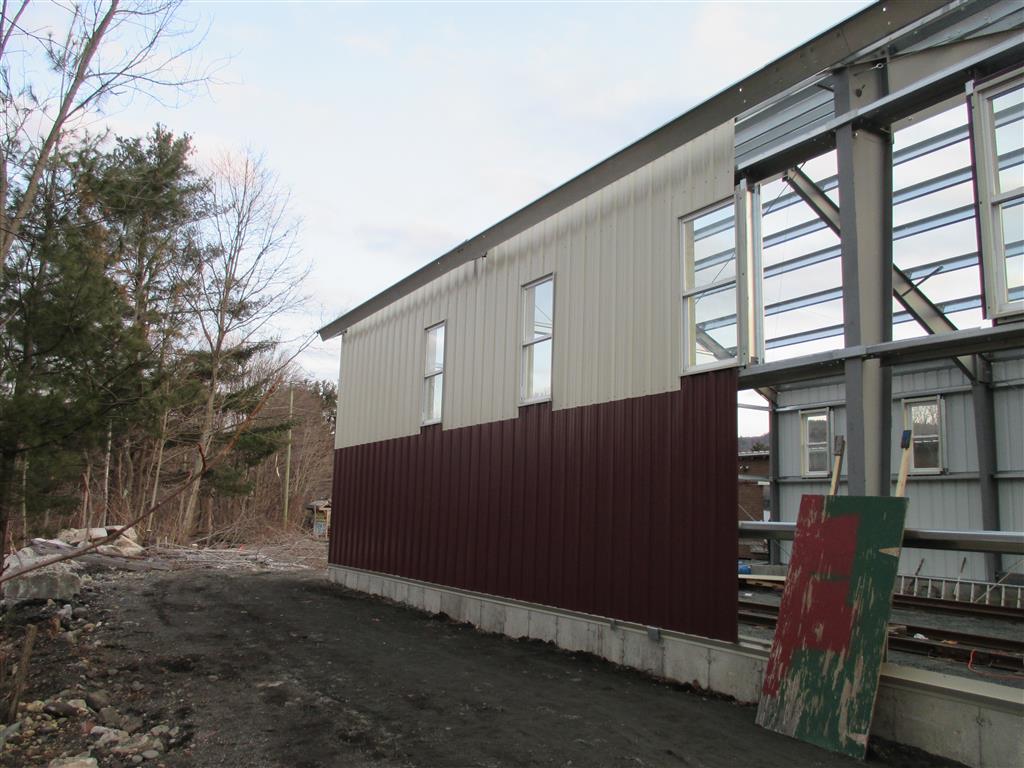

Starting to put the siding on.
car barn progress
The panels are two colors to match the B&M Freight House paint scheme.
car barn progress
The scissors lift has been very handy for this job.
car barn progress
Here you can see how the windows are framed, and the horizontal 'girts' that hold up the side panels.
car barn progress

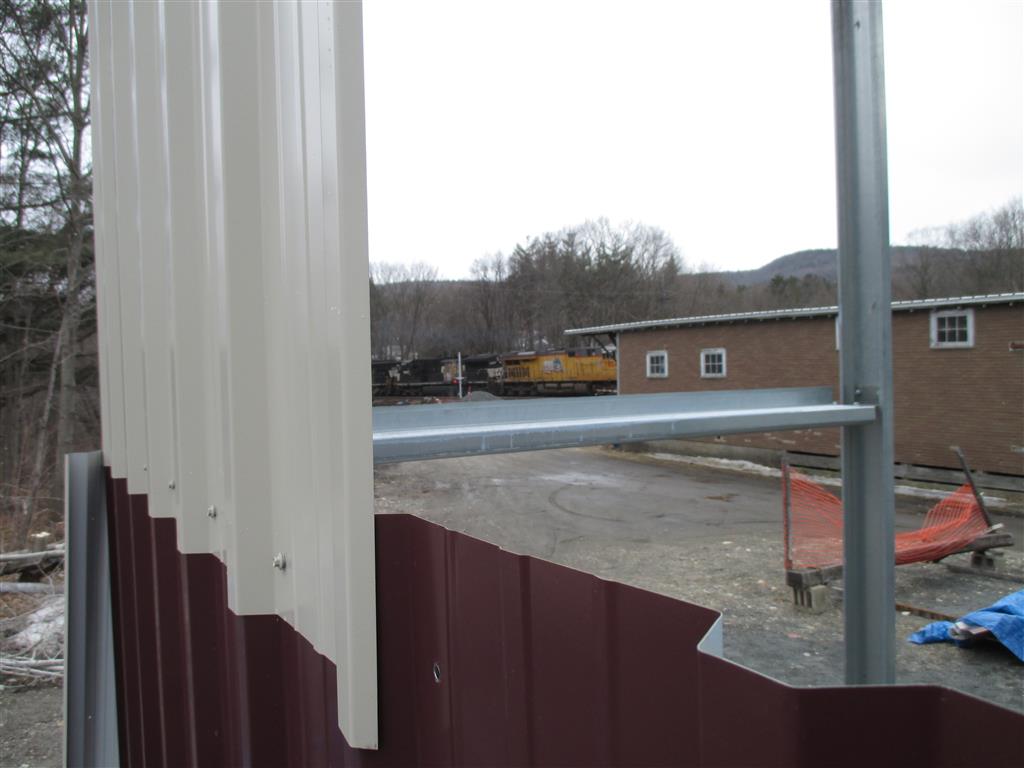

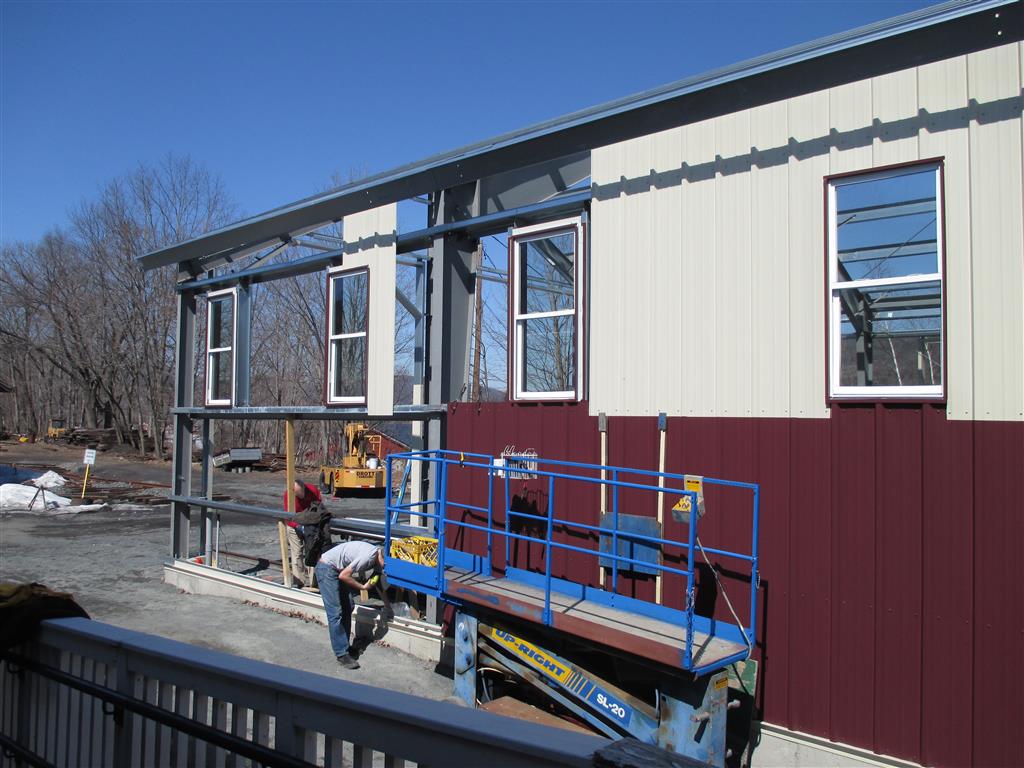

Work begins on the north side panels, as a train headed by UP and NS units passes Elm Street.
car barn progress
Each window requires the upper panels to be cut out of the sheets to fit the openings.
car barn progress

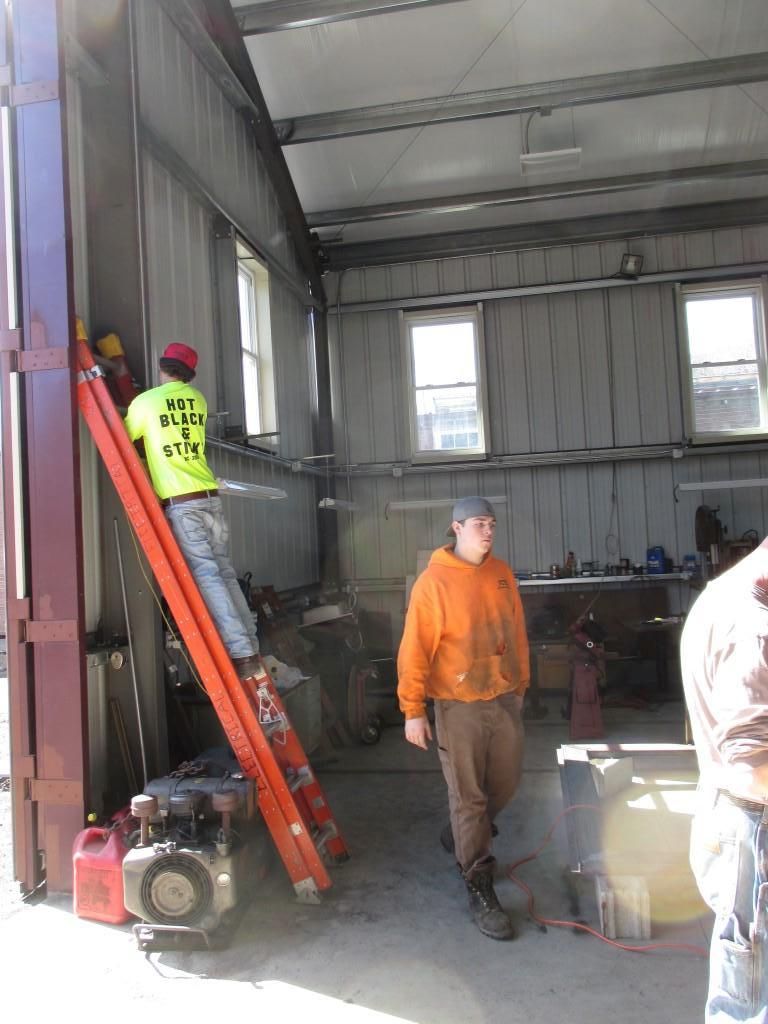

Workers from Gagne Fabrication roll out the insulation that goes under the roof sheeting.
car barn progress
This step required two lifts as there was no place to safely walk.
car barn progress
The roll has to go up one side and down the other.
car barn progress

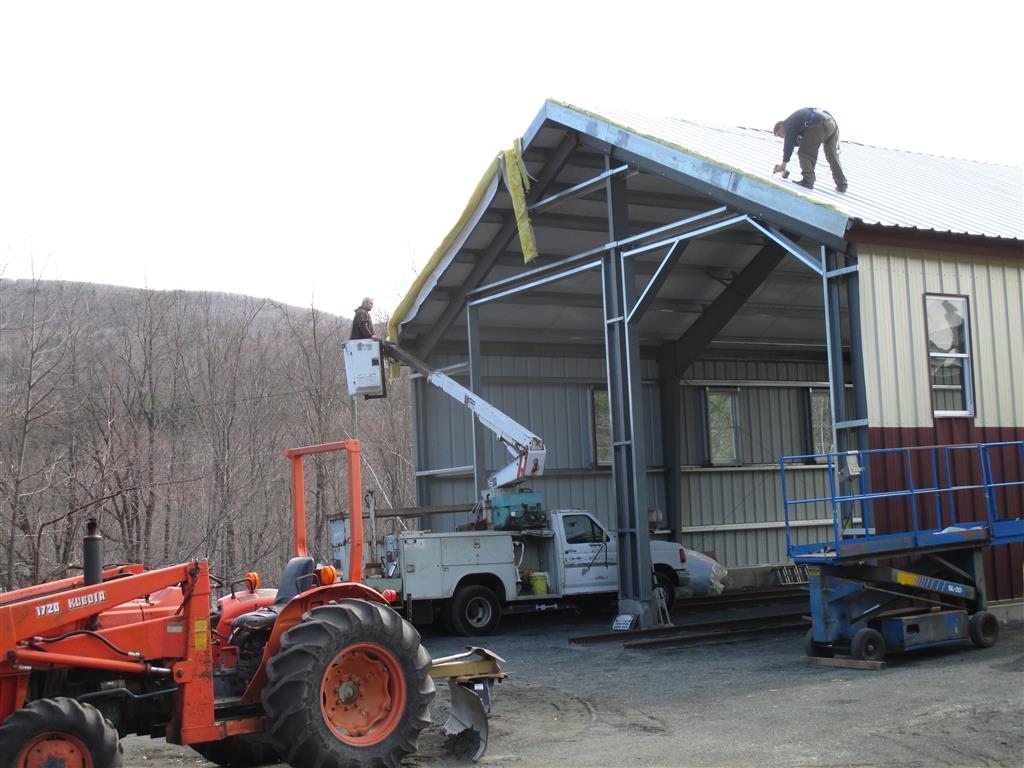

Then a roof sheet is pulled up.
car barn progress
car barn progress

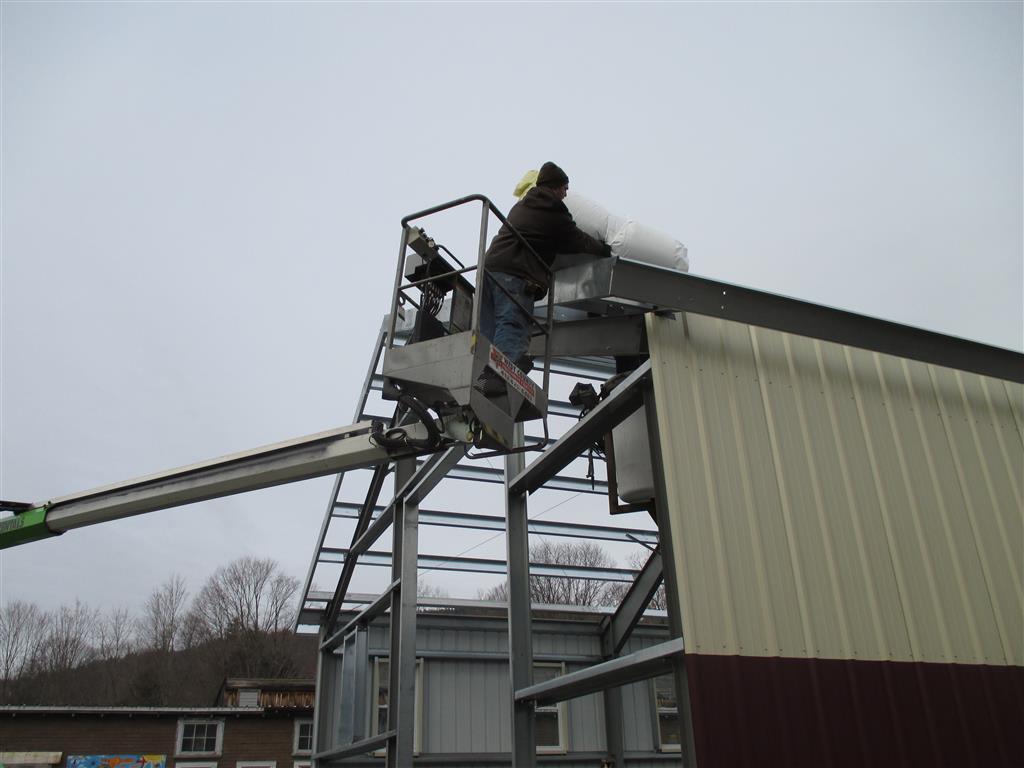

More insulation, half the roof is done now.
car barn progress

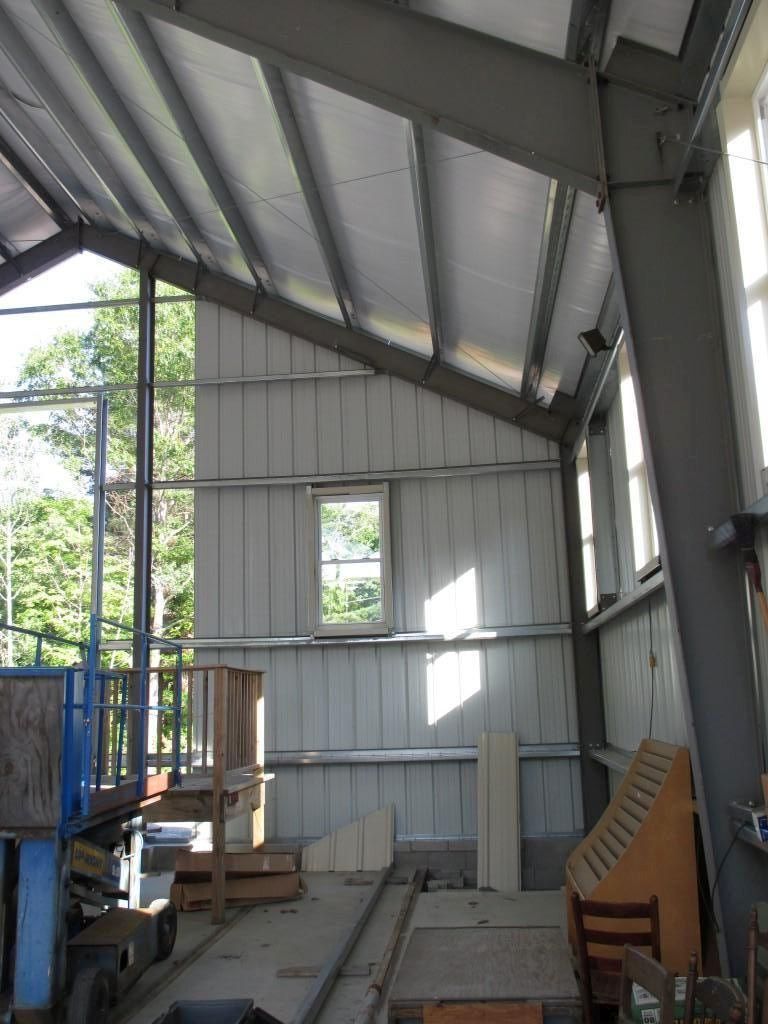

View from inside, no work today due to snow.
car barn progress
Screwing down the final sheets.
car barn progress
car barn progress
The worker on the roof was tied in at all times.
car barn progress

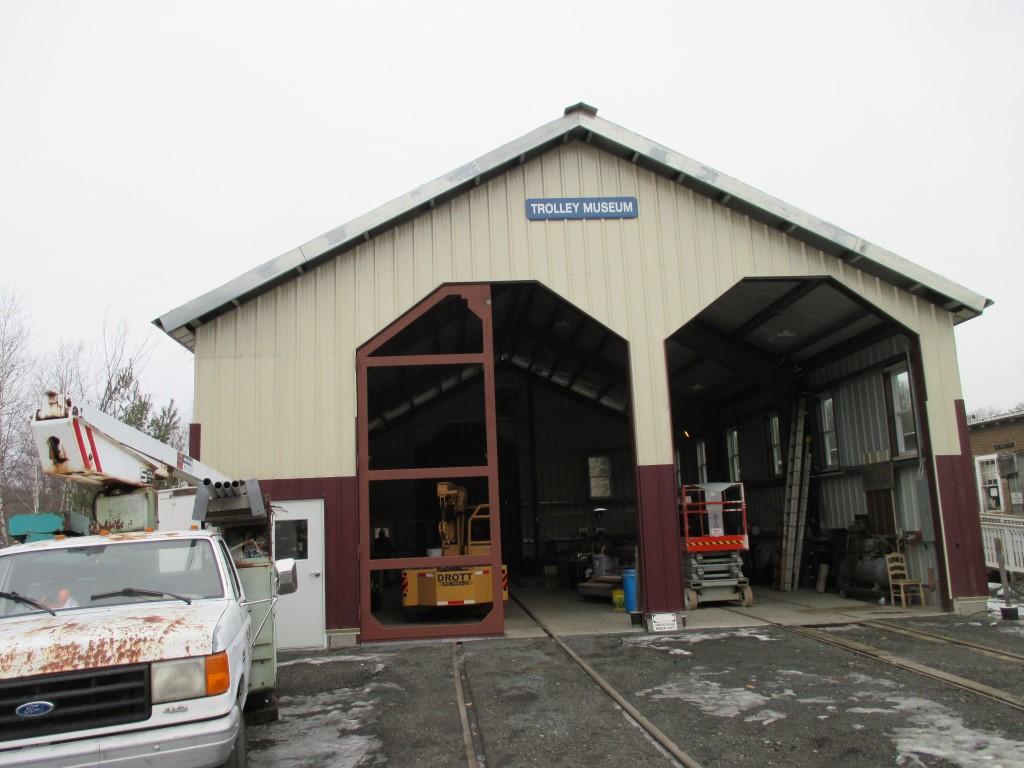

OK, that's done, what's next?.
car barn progress
View from Elm Street.
car barn progress
View through the building.

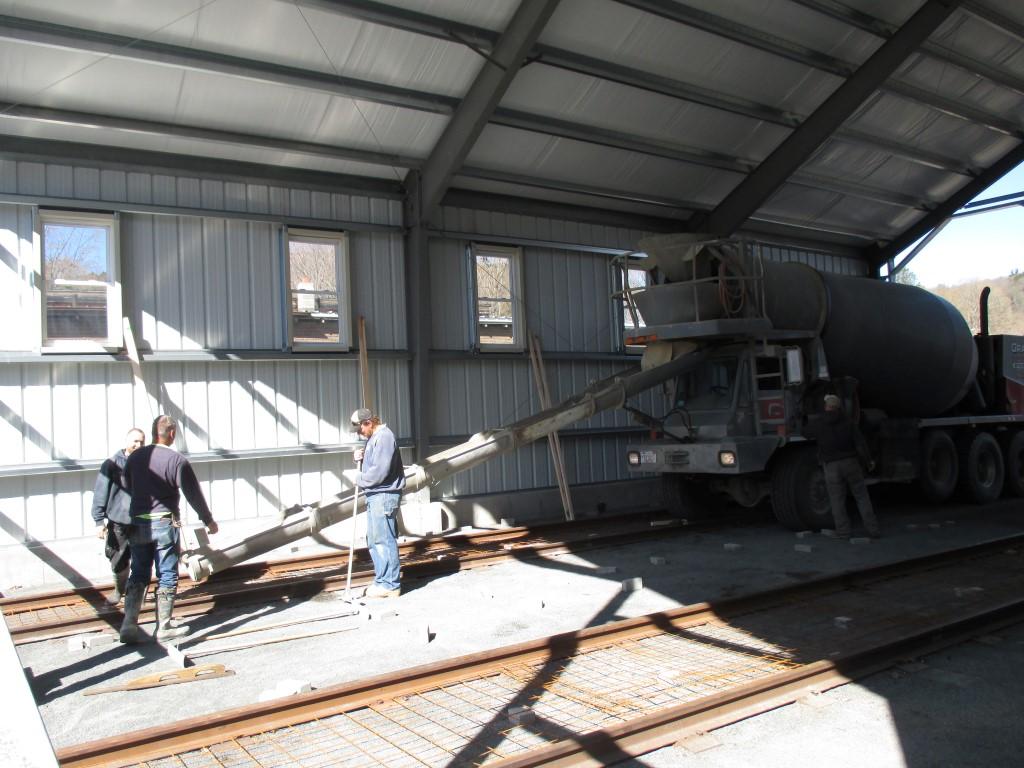

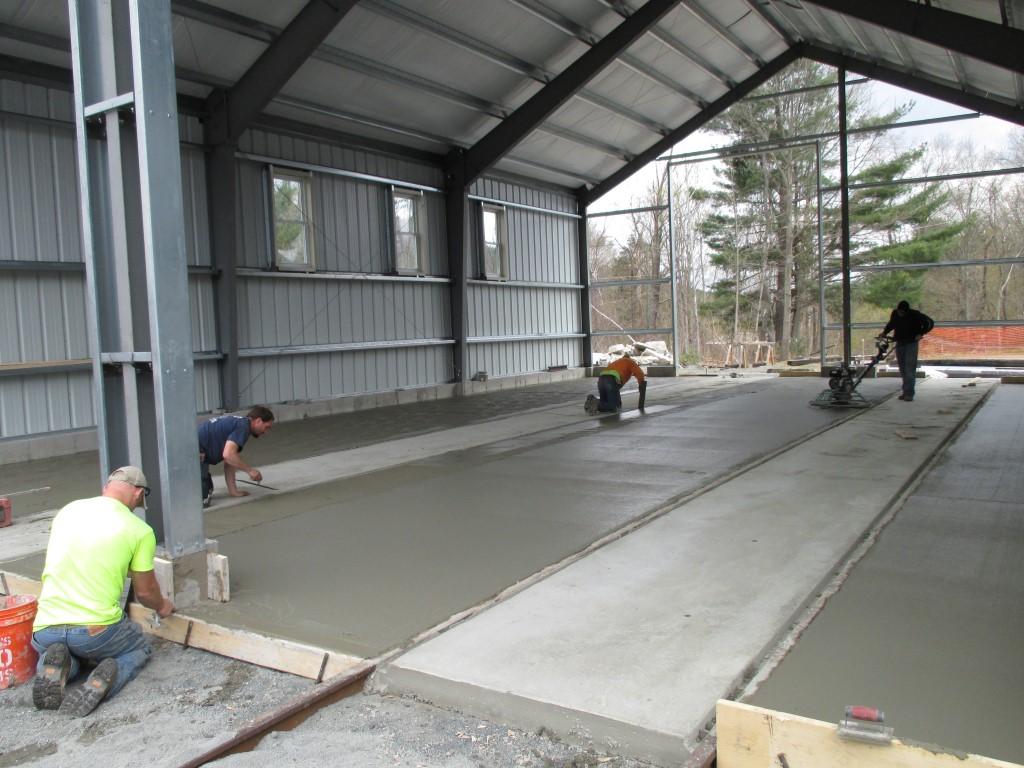

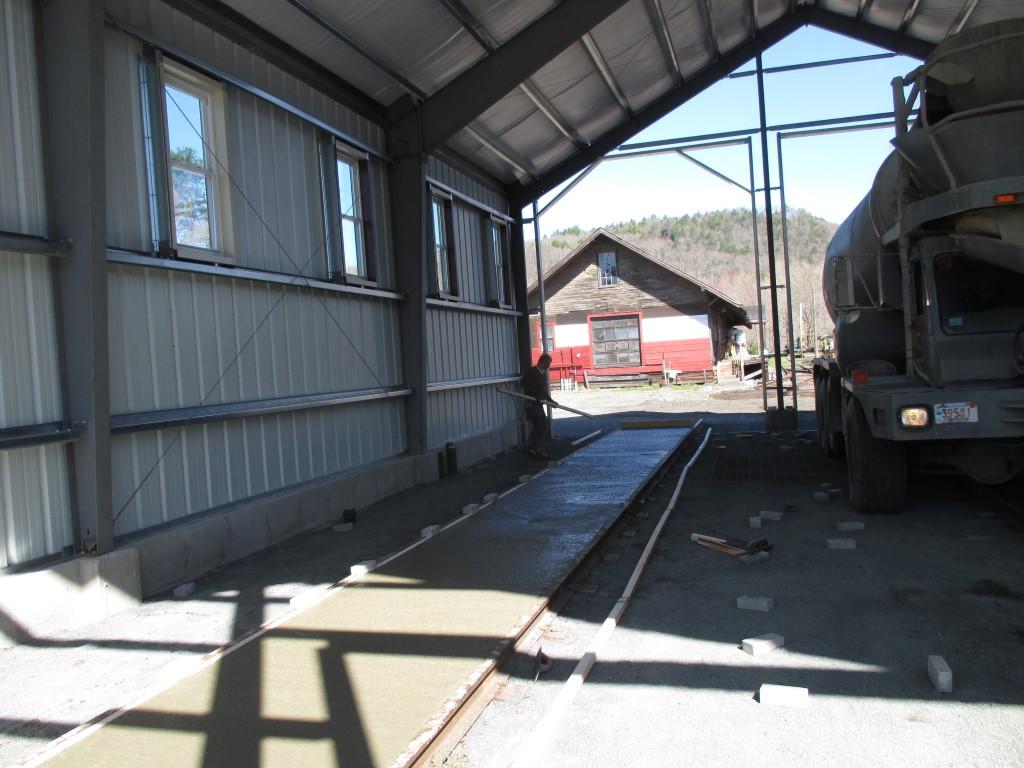

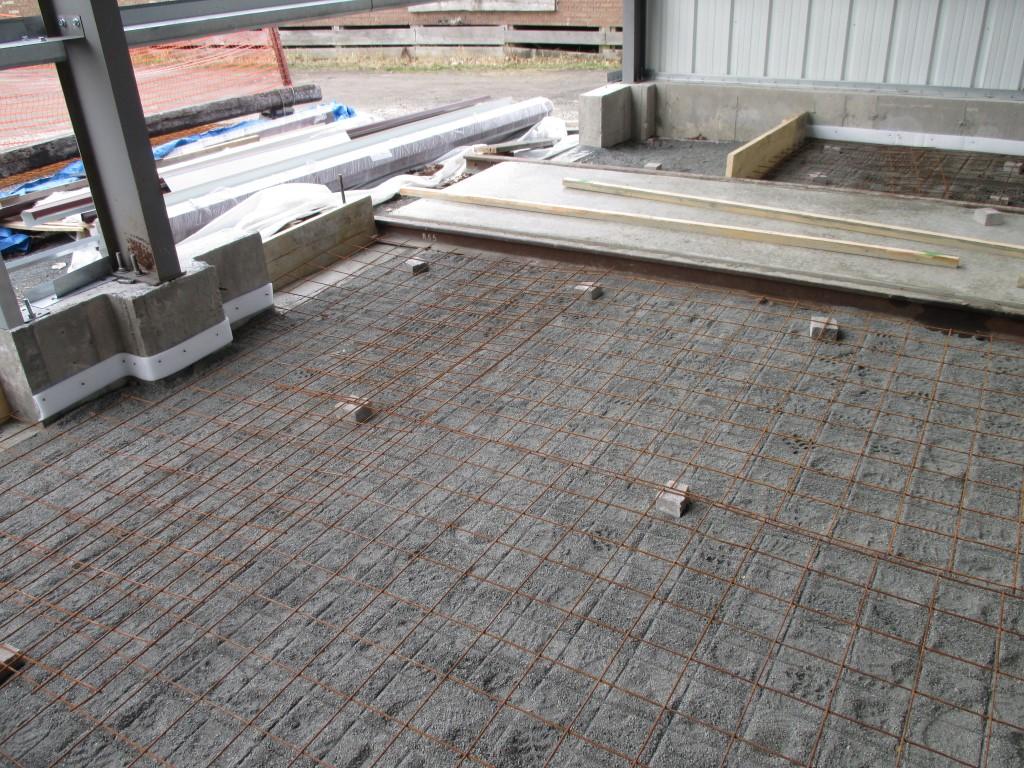

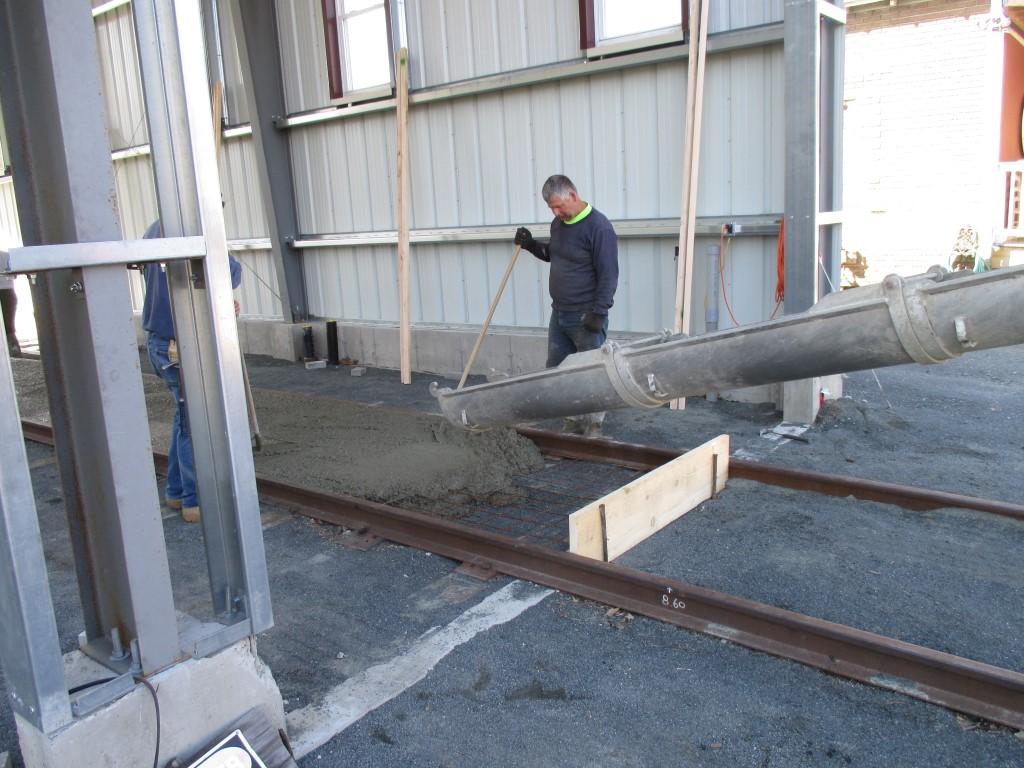

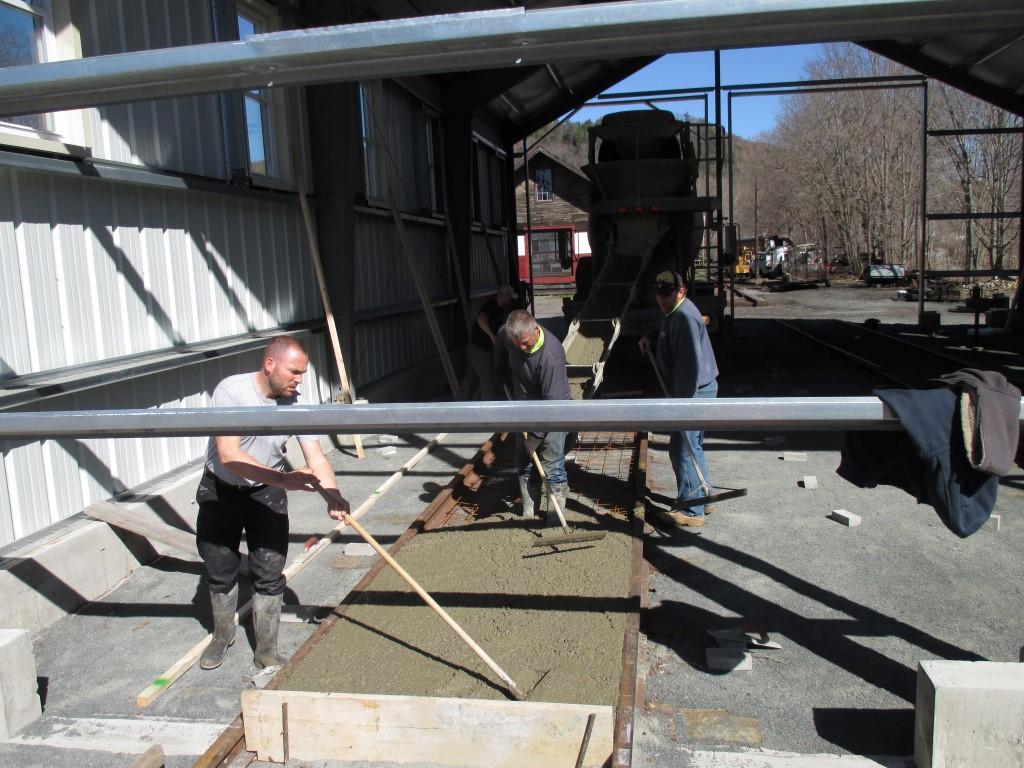

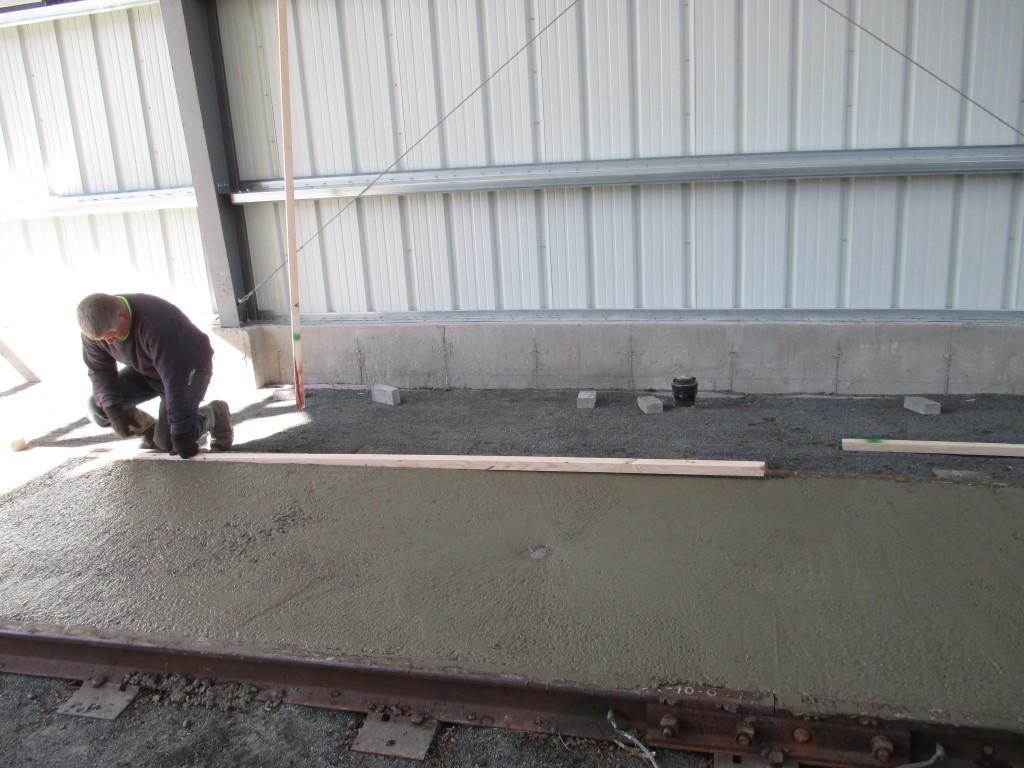

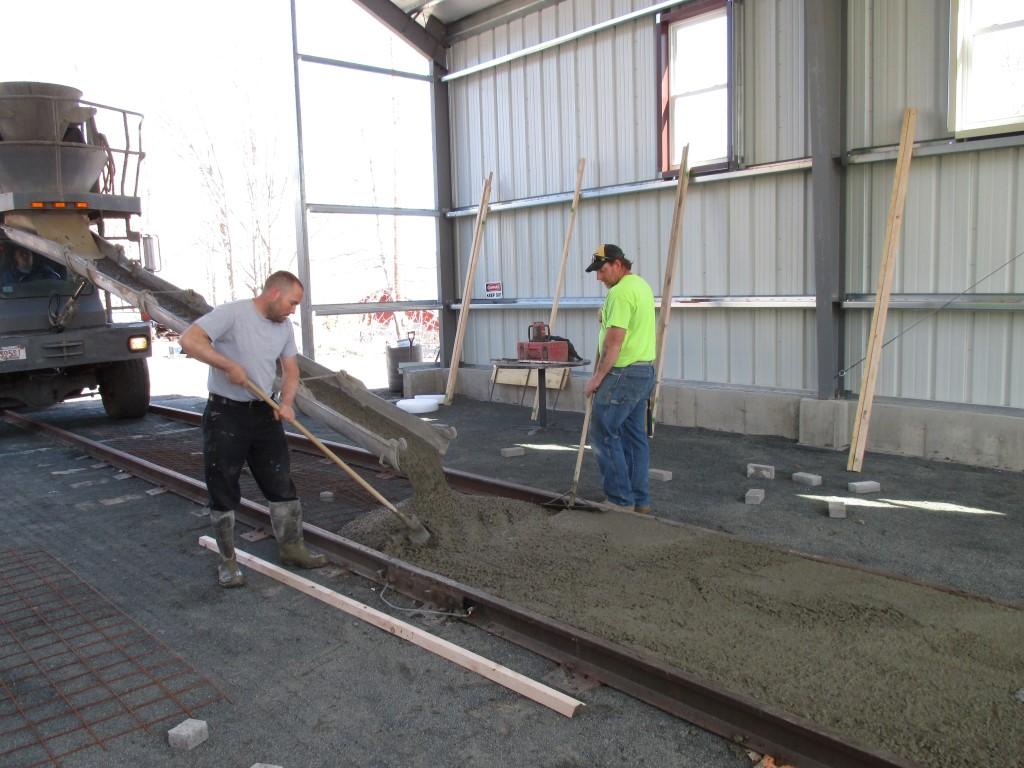

Spring 2015 The next step was to pour the concrete floor.

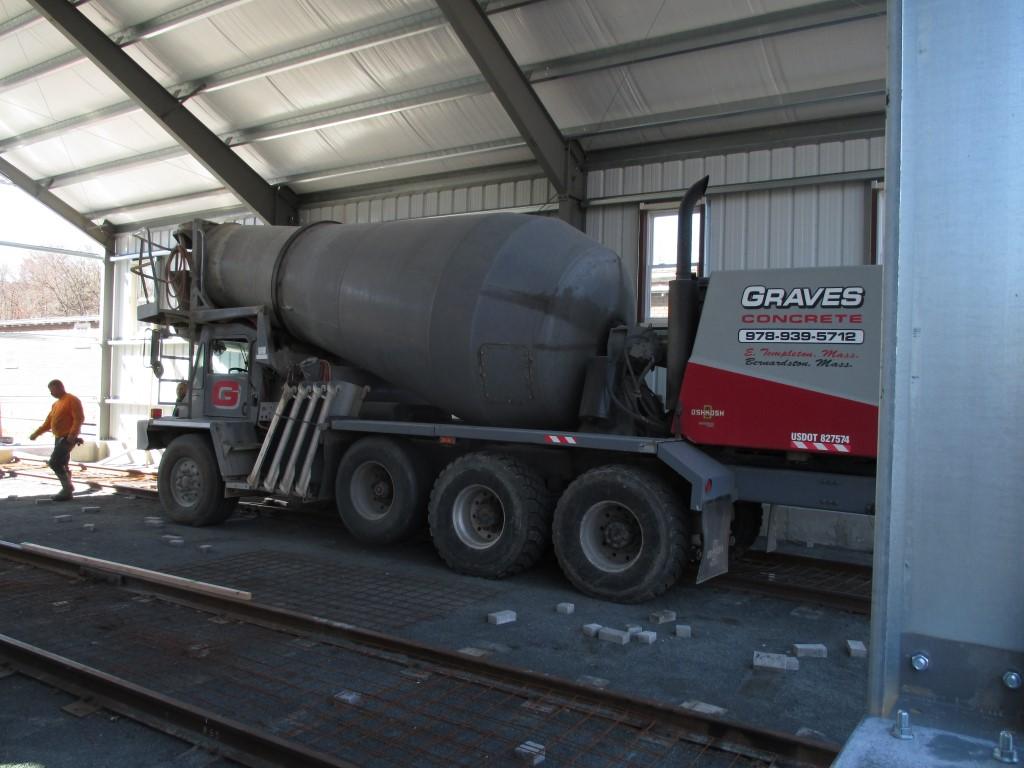

Valley Concrete did this part of the job. We had hoped to do it in the fall, but just as we were ready with the tracks it got cold. So we waited for spring.

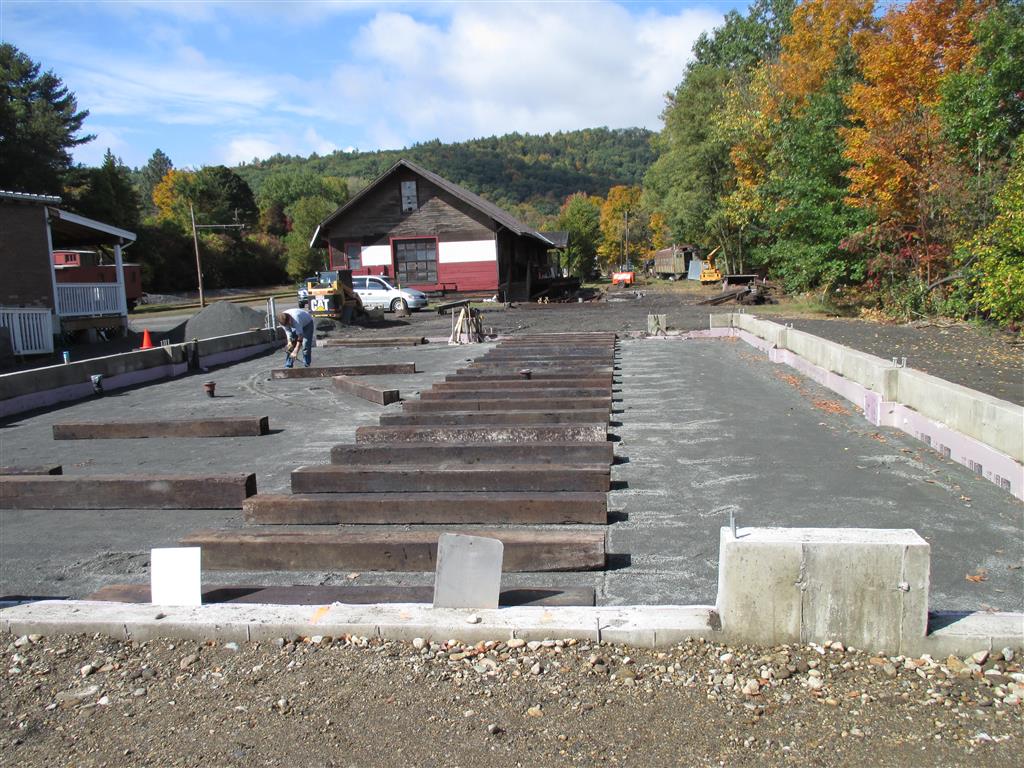

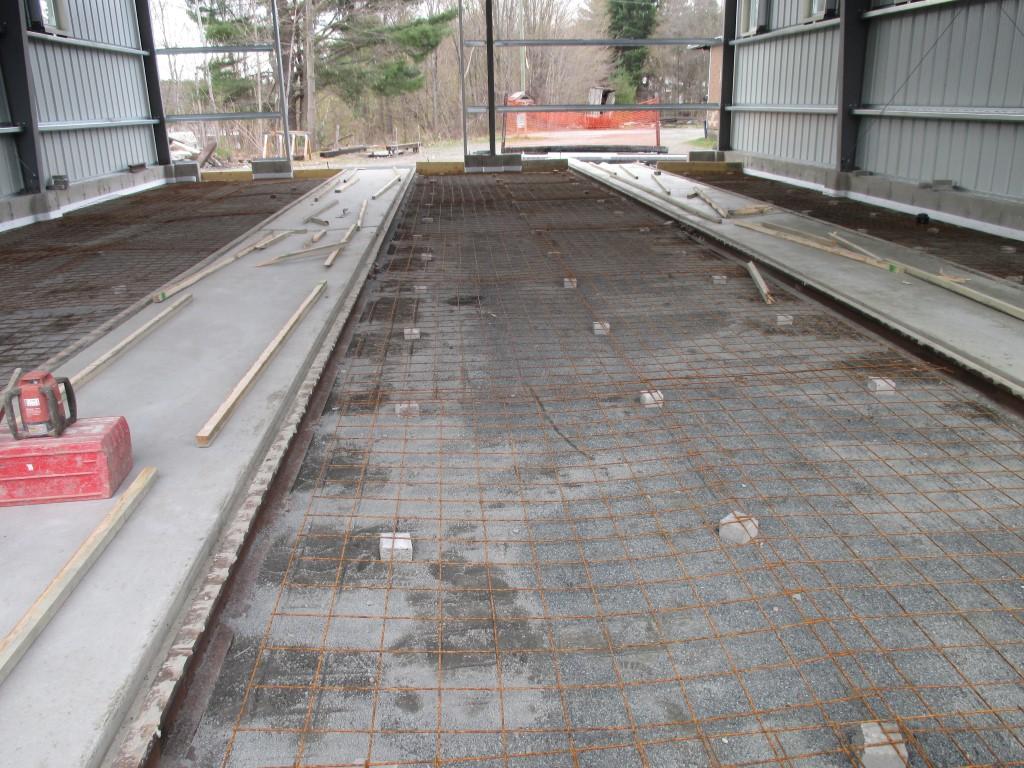

Below we can see that they poured the slabs between the rails first.
car barn progress
Reinforcing mesh is spread out and spaced off the grade.
car barn progress
The floor drain was covered so it wouldn't get concrete in it.
car barn progress

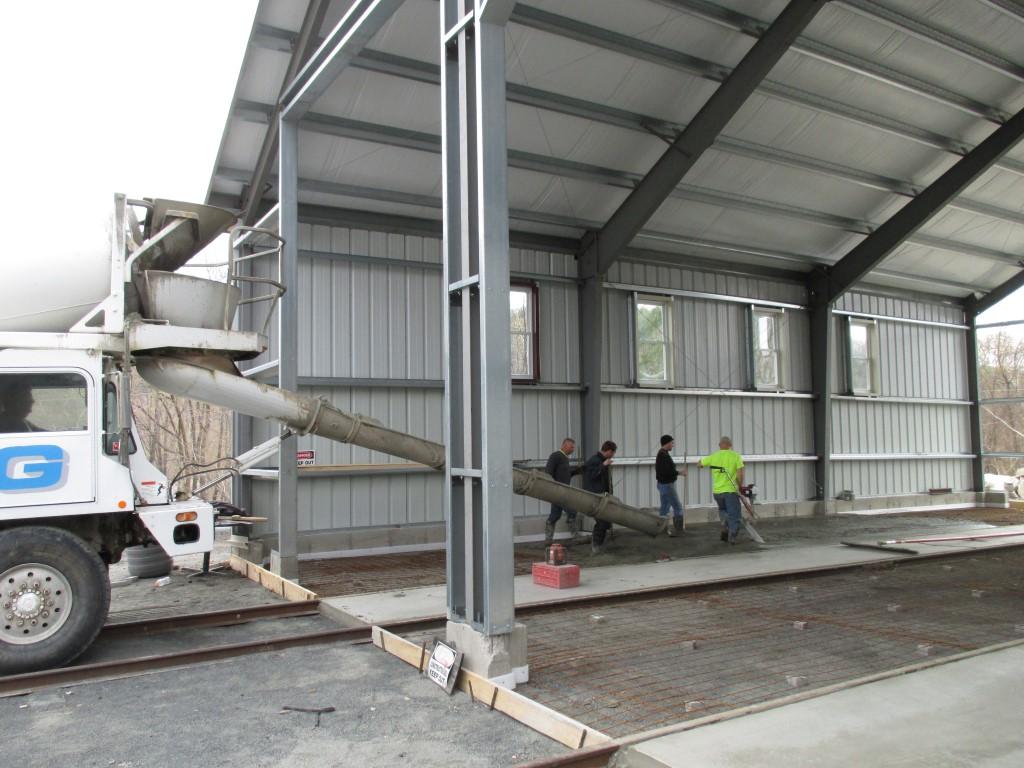

Nice to have a big building as they pour for Stall Two Track.
car barn progress
The 2x2s standing alongside are for forming the flangeways for the trolley wheels.
car barn progress
Spreading the mix..
car barn progress
Spreading the mix.
car barn progress
Spreading the mix.
car barn progress
Pushing in the flangeway forms.
car barn progress
The blocks keep the forms from floating back up.
car barn progress
Stall One Track gets filled next.
car barn progress
Stall Two is smoothed off, still some flange-fillers to be put in.
car barn progress
Finishing up Stall One Track.
car barn progress

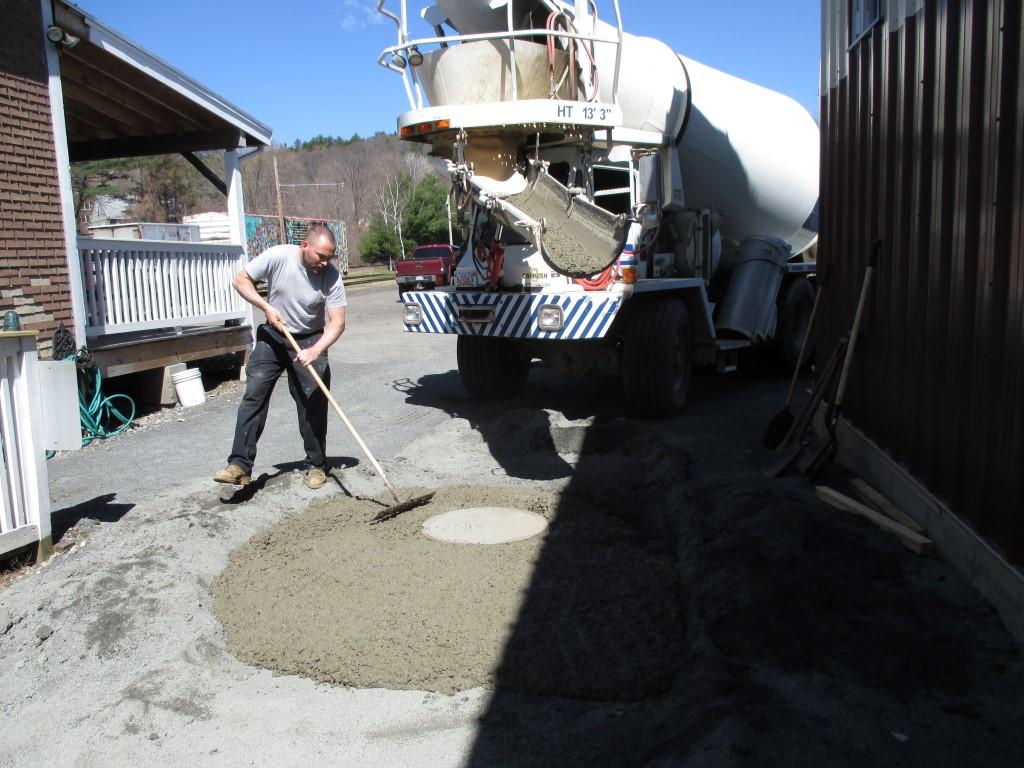

Some extra mix was filled around the oil-water separator to make it easier to plow.
car barn progress
Both Tracks are curing.

Now for the rest of the floor.
car barn progress

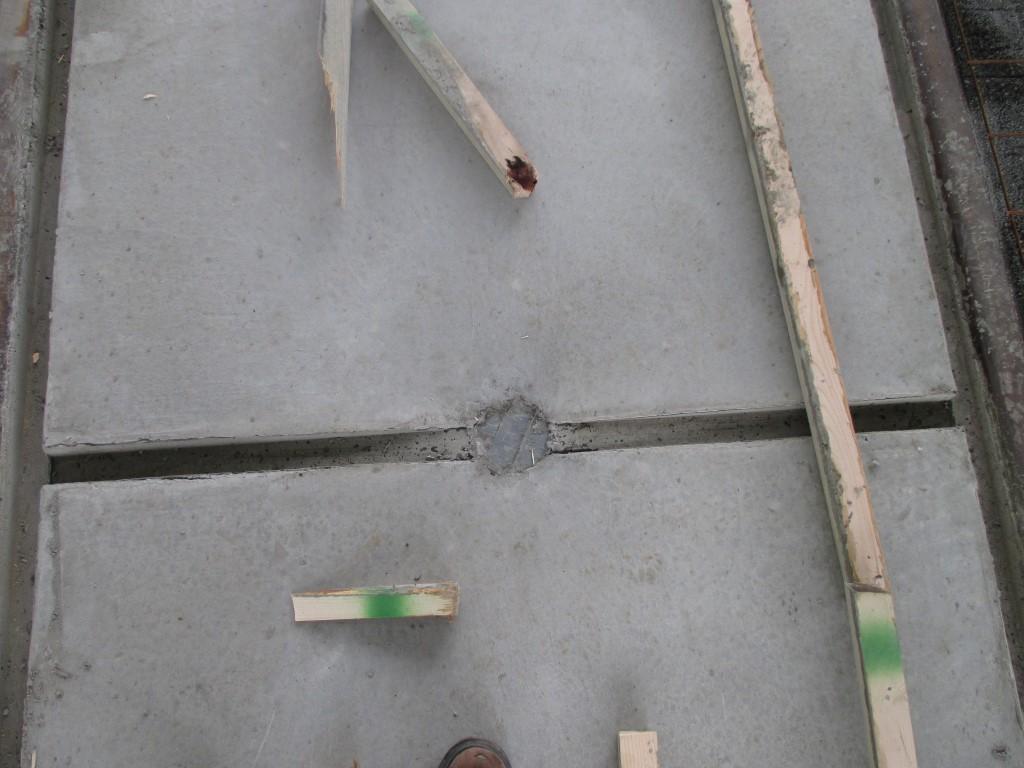

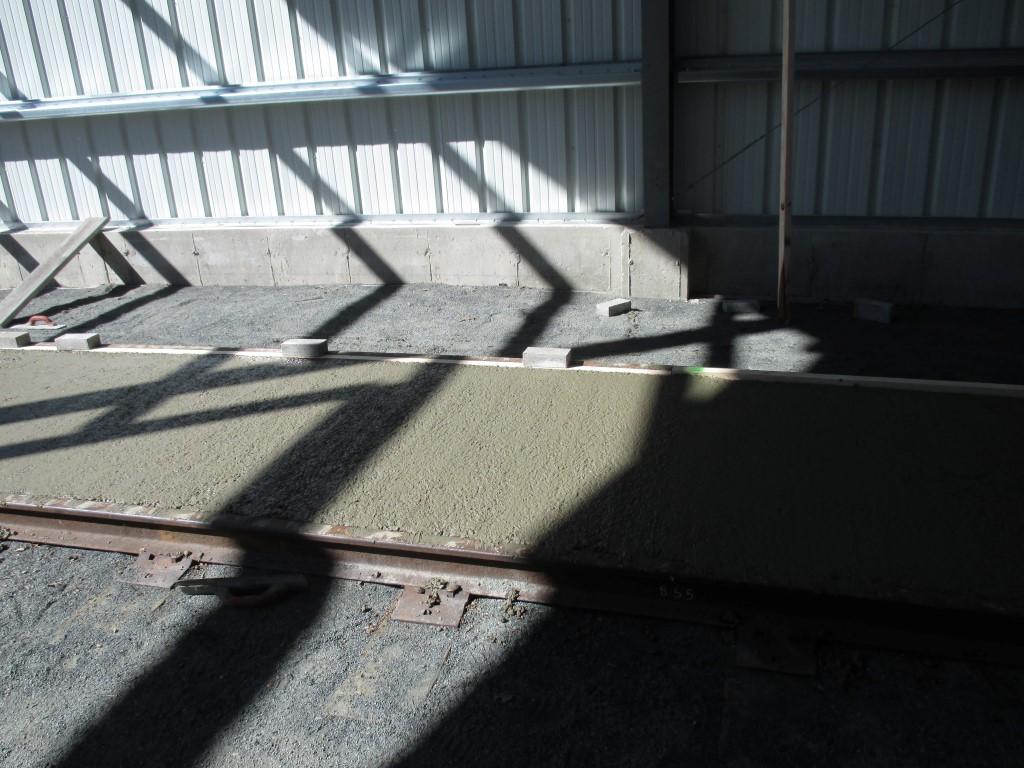

The 'gauge' slab (between the rails) is cured and the flange-forms removed, reinforcing mesh is spread.
car barn progress
A bond break was added along the walls to keep the slab and frost walls separated.
car barn progress
The floor drains use the flangeways as gutters.
car barn progress
In the far corner (SE) we left an opening so if we want to bring in water and sewer we won't have to bust open the floor.
car barn progress
More mix.
car barn progress
Good thing we hadn't sheathed the walls!.
car barn progress
Hard at work.
car barn progress
Smoothing it out, the gauge slabs make good work areas.
car barn progress
The floor is finally done.

Summer 2015

With the floor in place, we can get ready for David Bartlett's Celebration of Life - May 30, 2015.
car barn progress
Notice the concrete block wall at the end of Stall Two.
If we extend the building we can knock this out to extend the tracks.
car barn progress
The east end and Stall One 'back' door.
car barn progress
The nice open space very quickly attracts all sorts of stuff to fill it.
car barn progress
Meanwhile we were working on connecting the tracks, covered elsewhere.
car barn progress
Already some things are on display.
car barn progress
The two-part "To Boston and Maine Passenger Station" sign probably came from Northampton, MA.

Fall 2015 - The Track doors are very large, each half is 6 or 7 feet wide and 18 feet tall at the top.

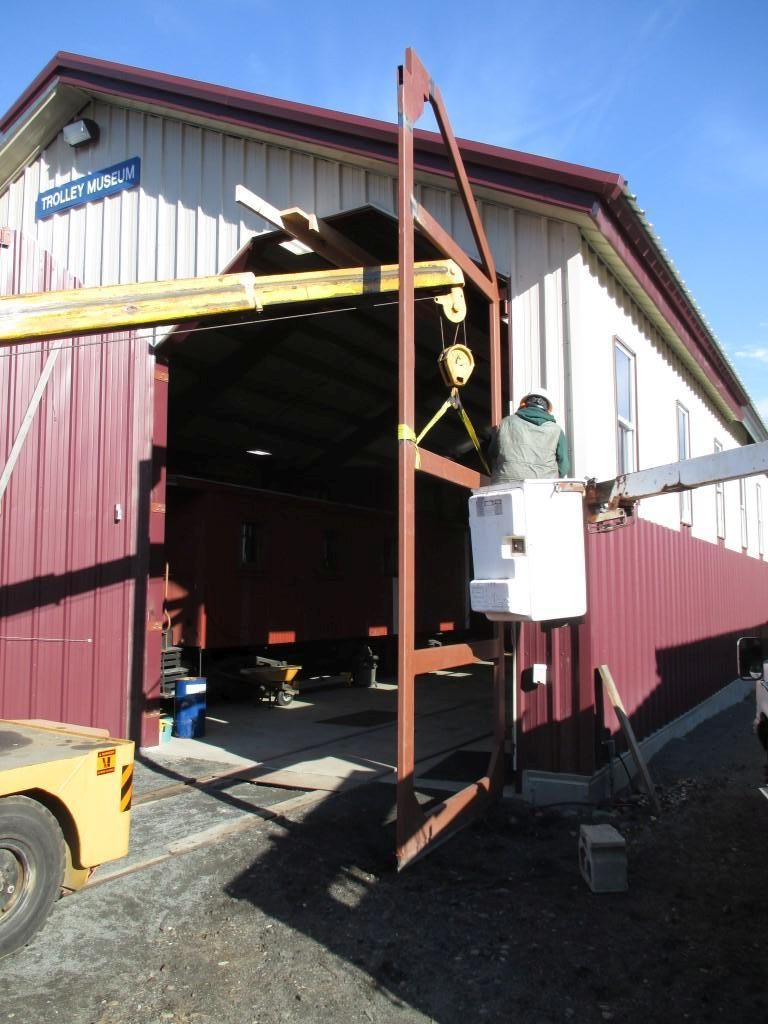

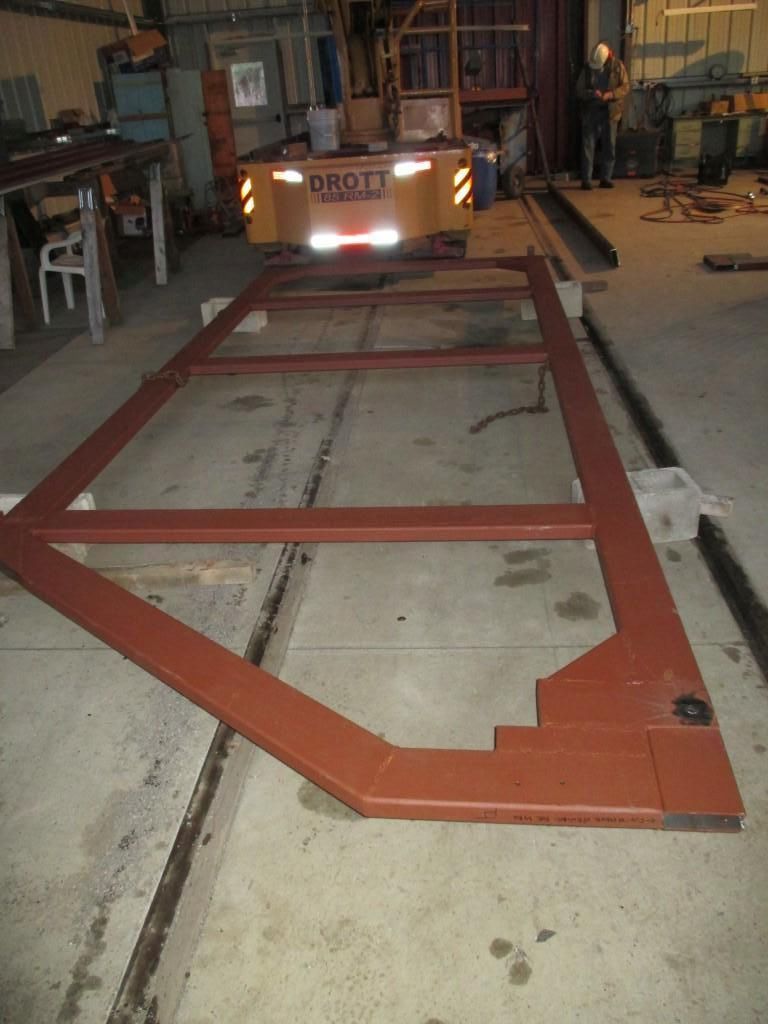

They weigh about 1000lbs each half. The following pictures show how we built them and installed them. car barn progress

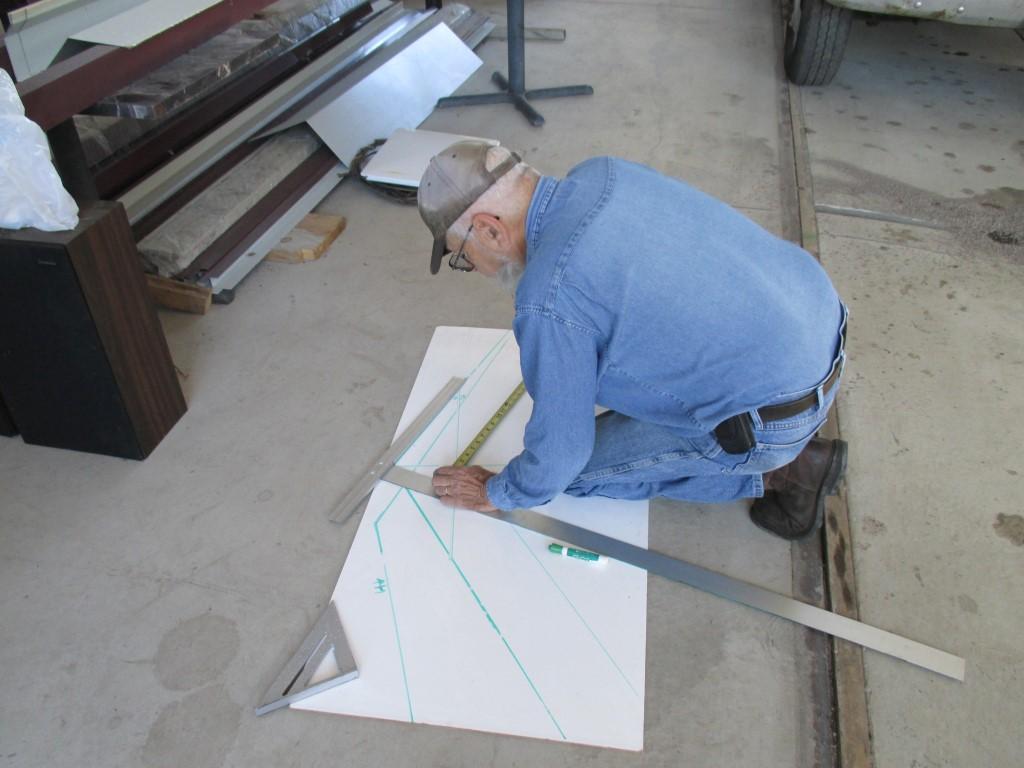

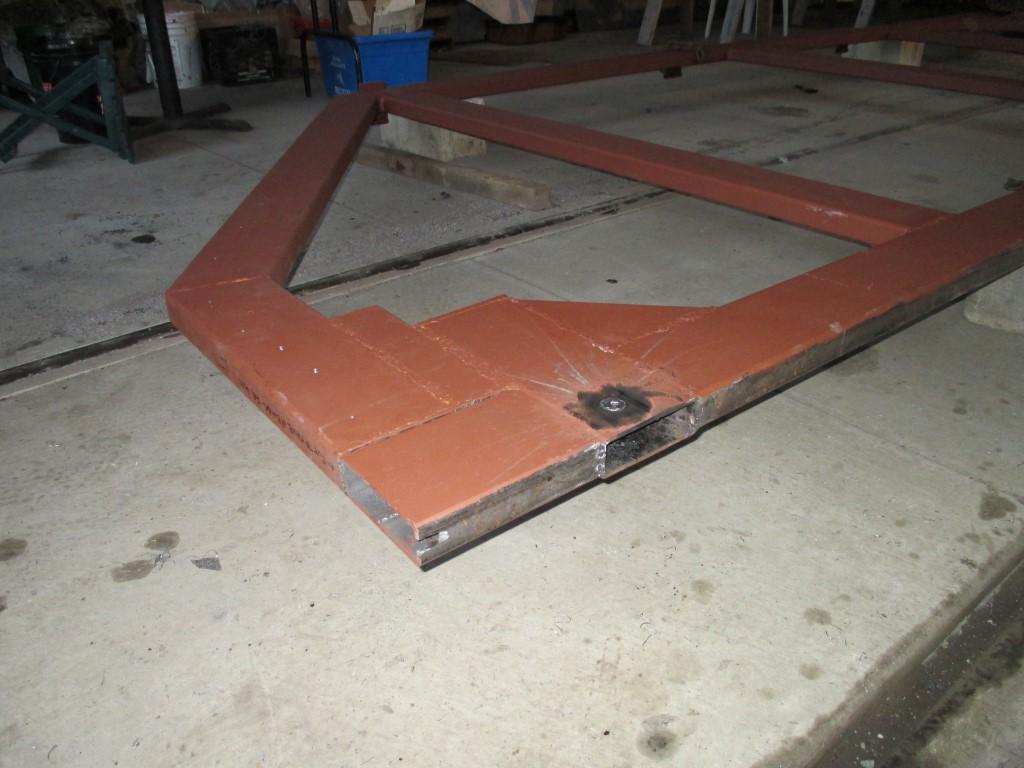

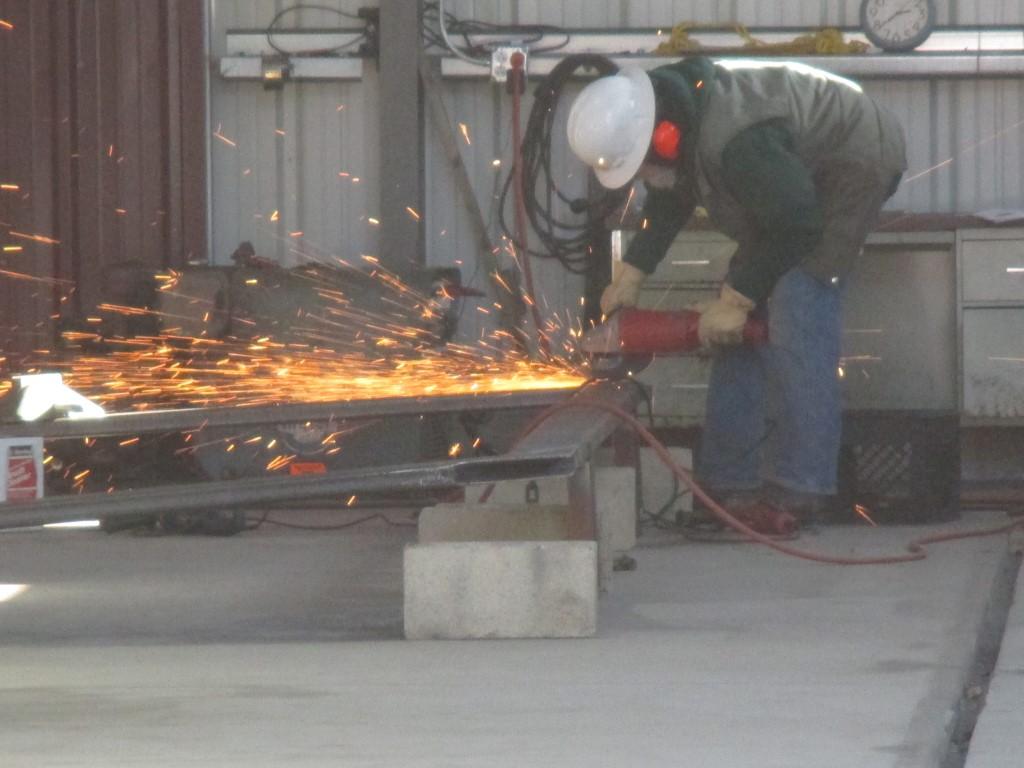

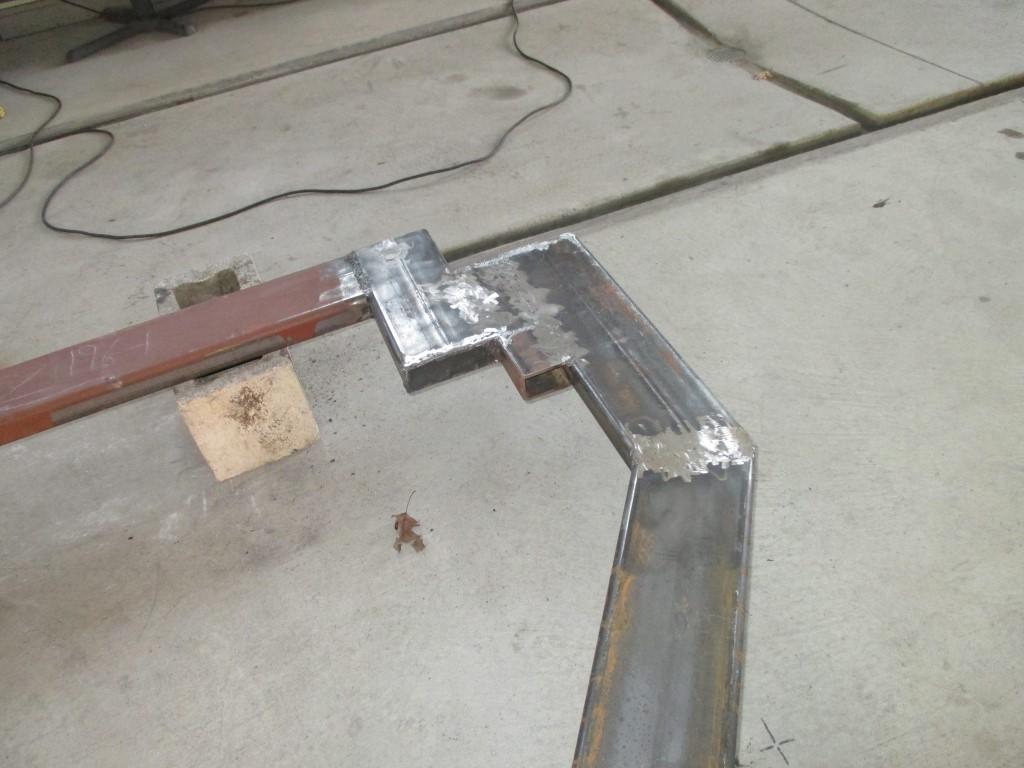

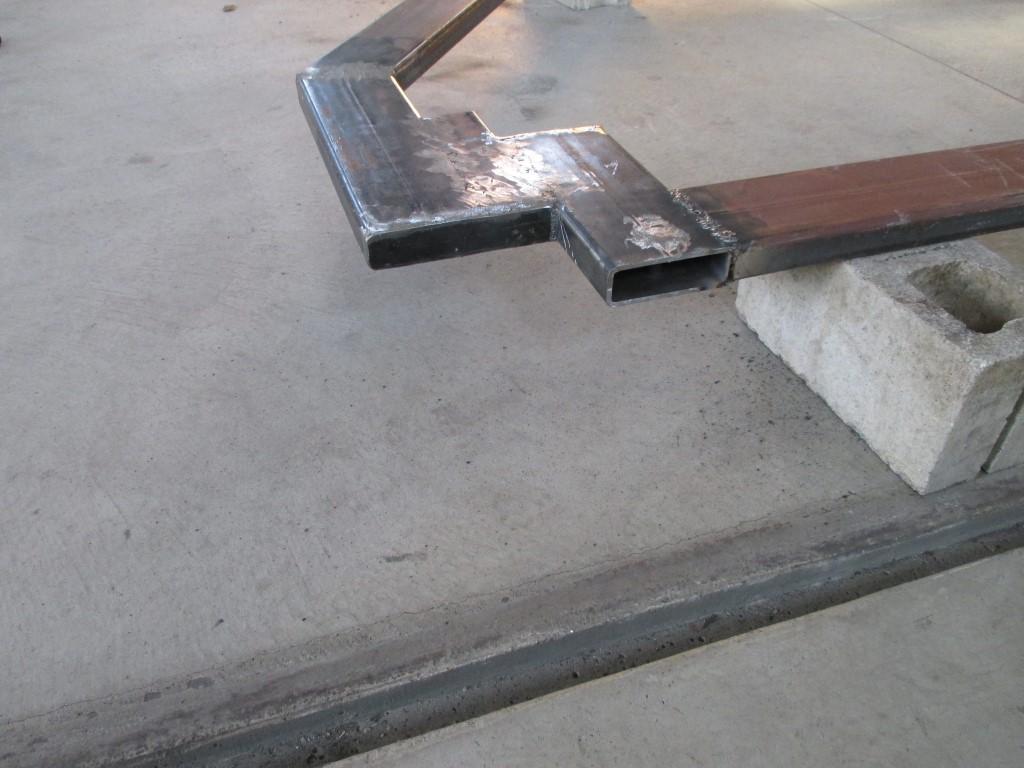

The angled top required some fussy design work, here our welder Larry works out the angles.
car barn progress
After much cutting and thinking and welding the first half is ready to hang.
car barn progress
The door has been clamped in place, Larry is welding the hinges to the frame.
car barn progress

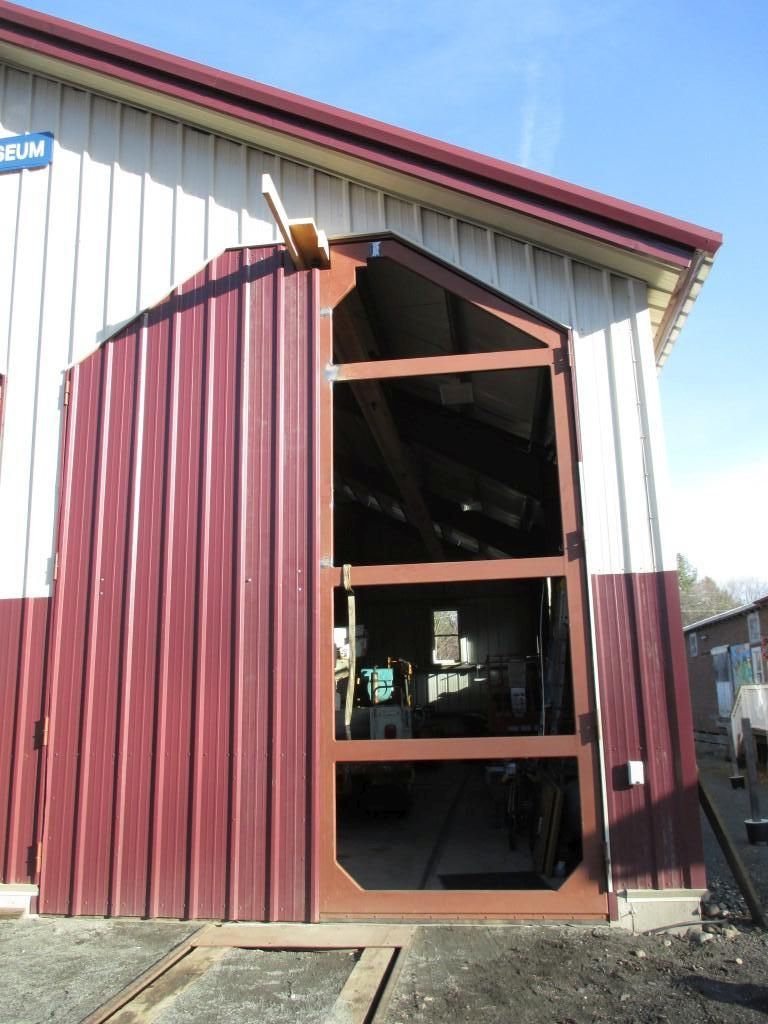

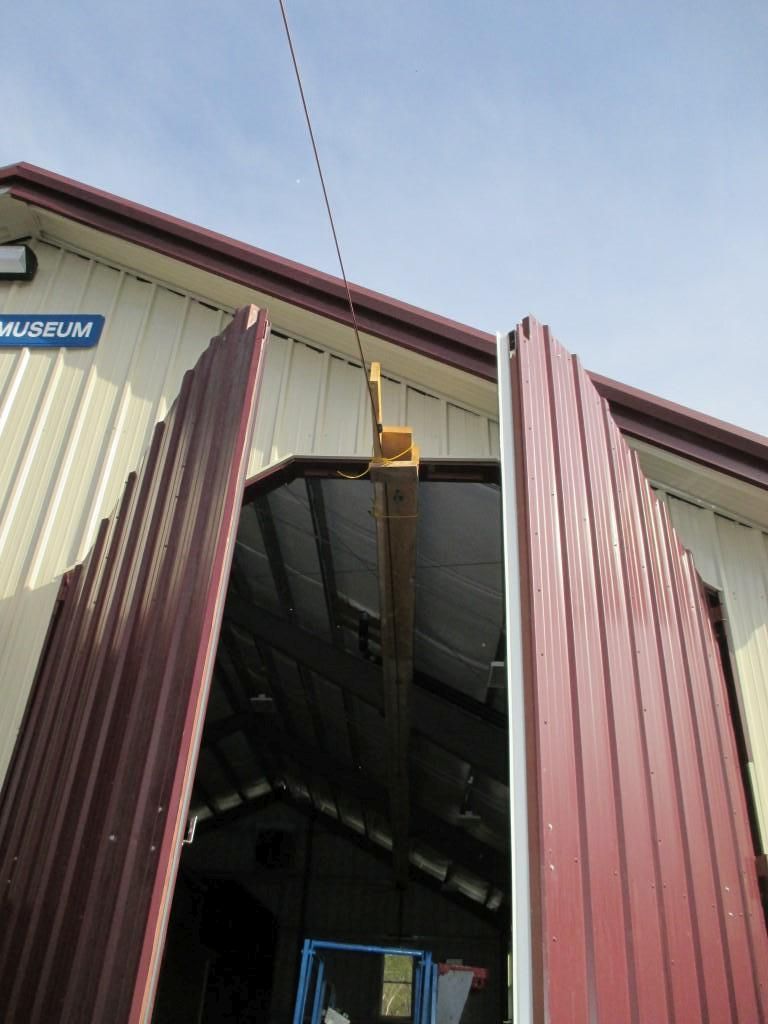

One down, five to go!
car barn progress
Filling up fast.....
car barn progress
Door half number 2, note the hinge halves on the building frame.
And some more sheathing and a pass door have been installed.
car barn progress
And sheathing and a pass door on the west end.
car barn progress
East end wall is finished, notice the vent fan up high.
car barn progress

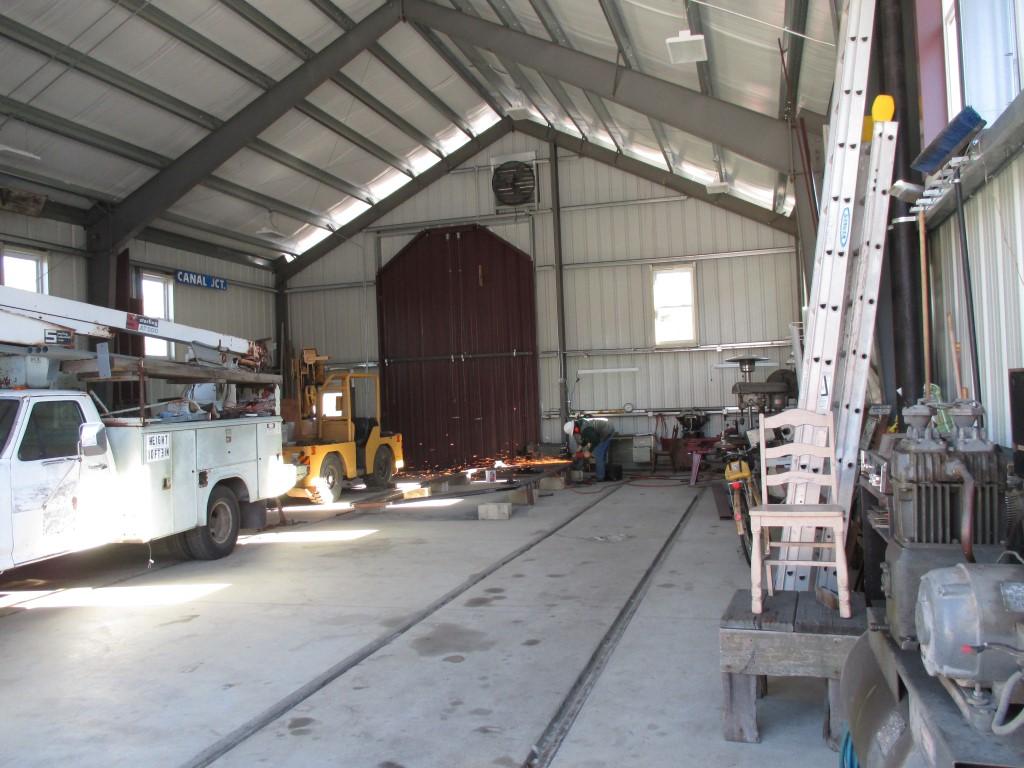

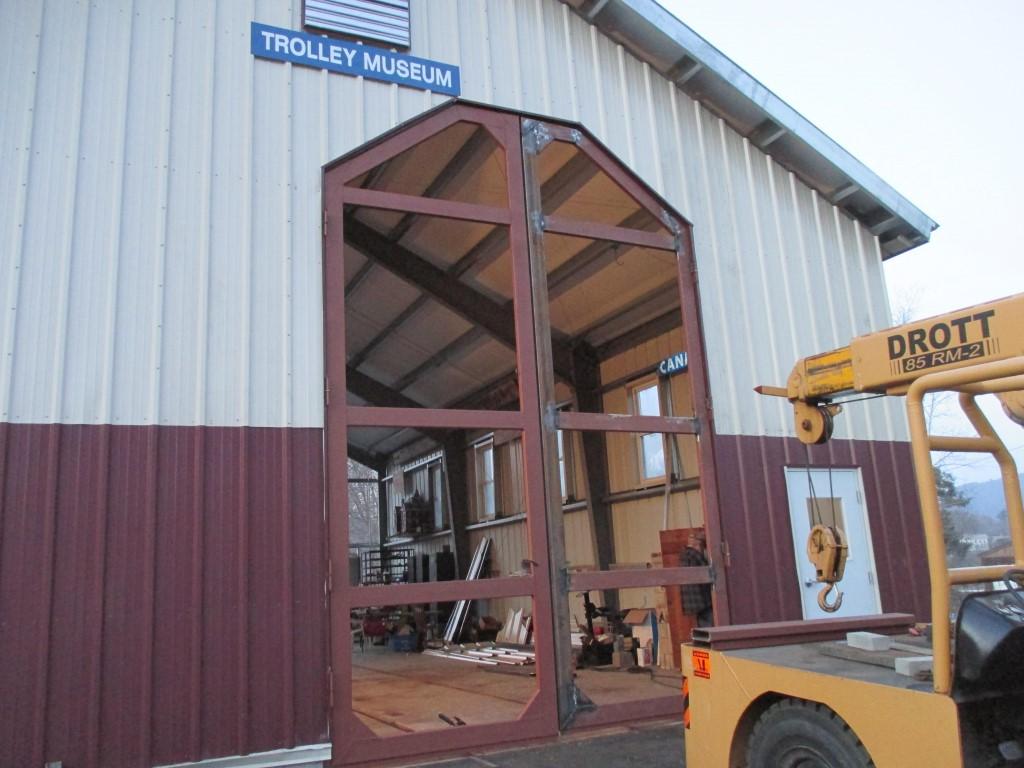

Both east doors are built, we primed them even though they will soon be sheathed over.
car barn progress
East doors complete on the outside, we are still going to sheath the inside too.
car barn progress

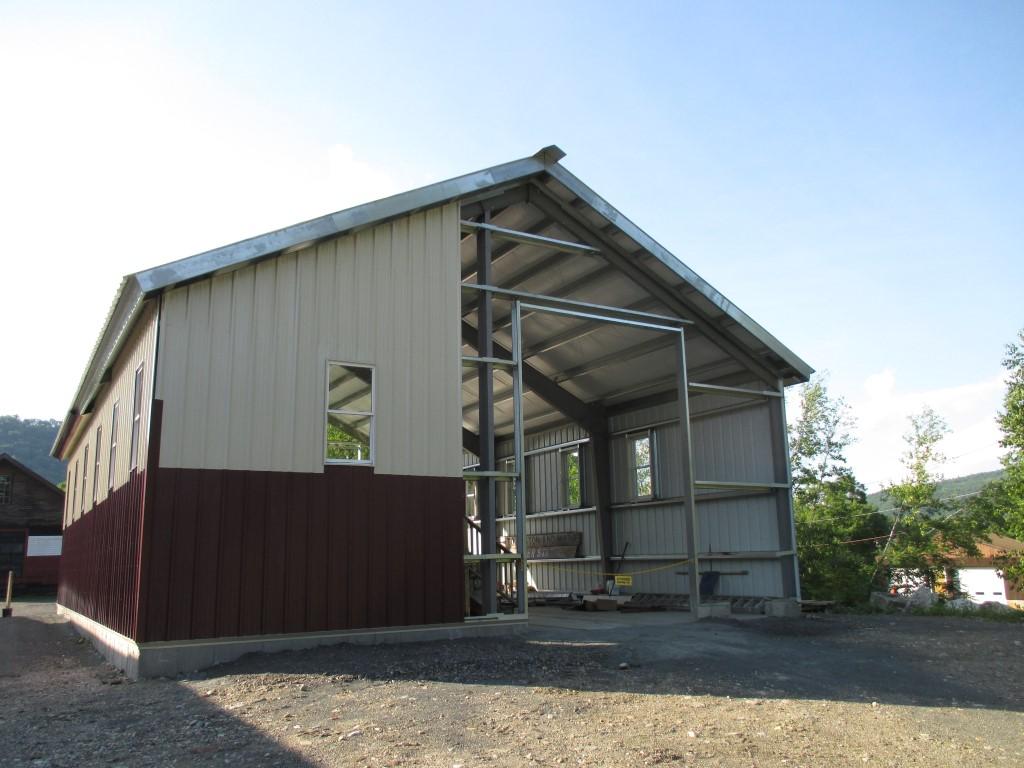

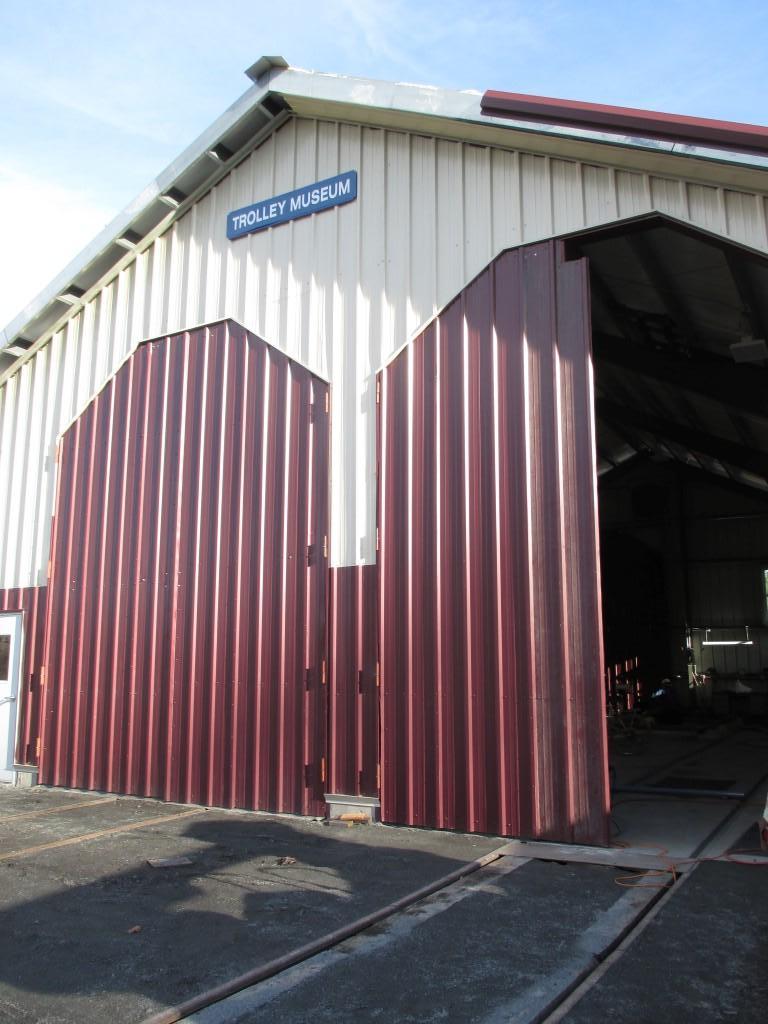

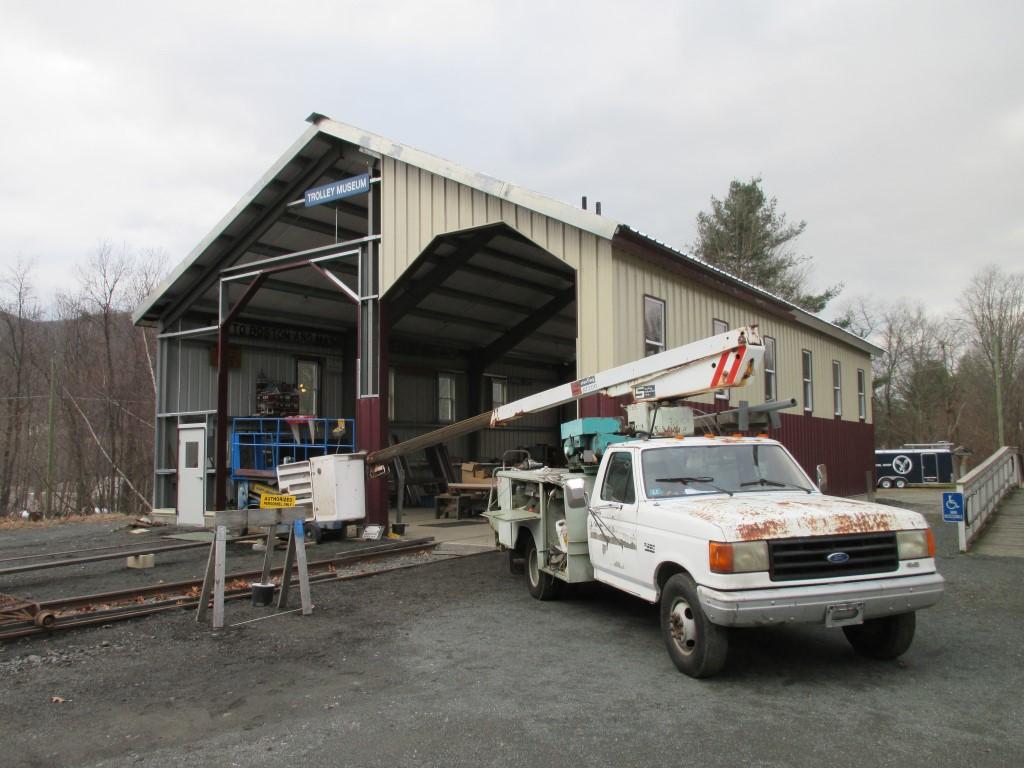

Like that. Seems we have everything here, even the kitchen sink if you look closely.
car barn progress

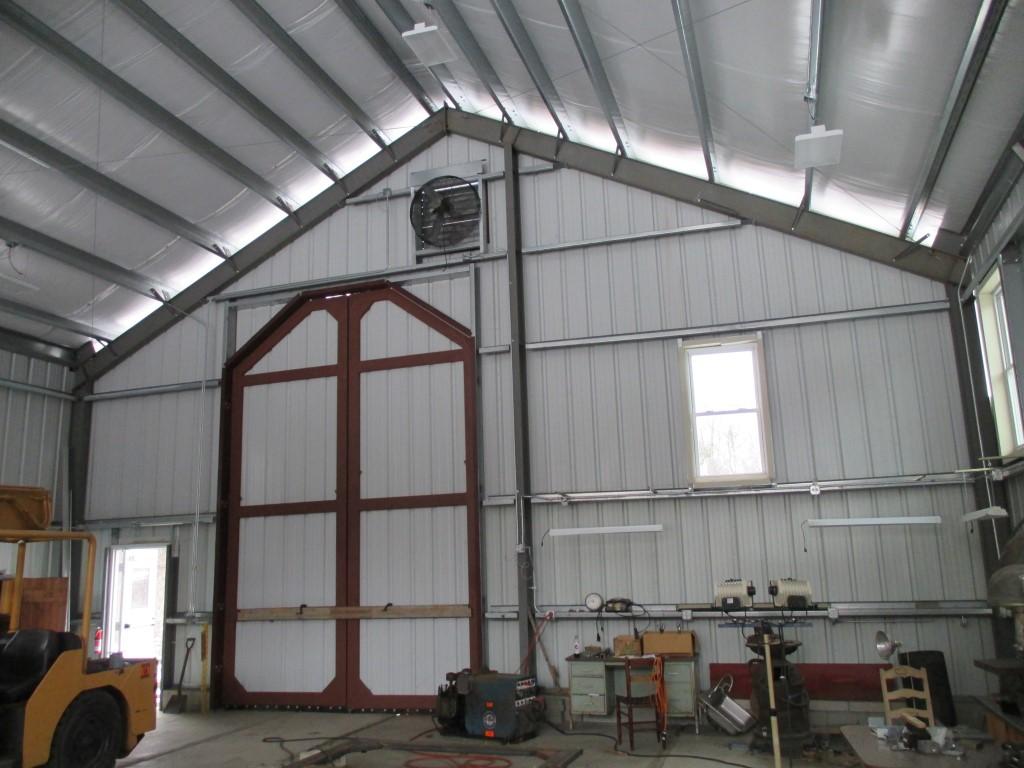

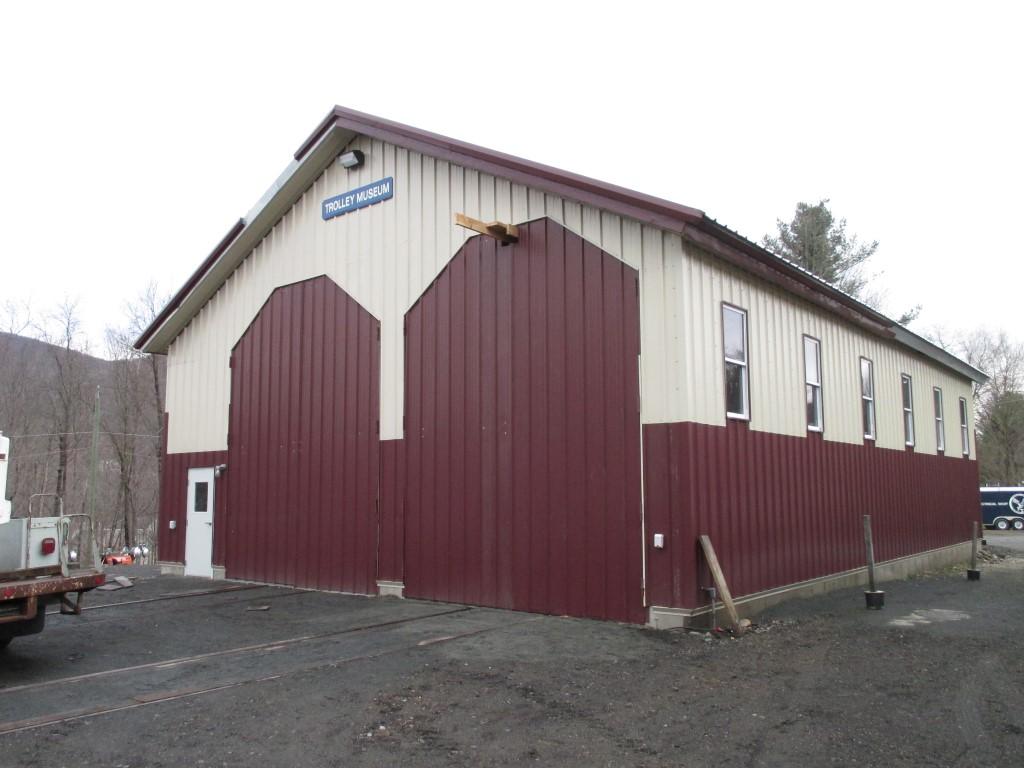

All done on the east end (except for trim and soffits).

On to the west doors, these are 7 feet wide each half.
car barn progress
The west end wall is sheathed and has a pass door.
car barn progress
Larry prefers to weld horizontally, we used the Drott crane a lot to keep flipping the door over.
We had to weld a little, then flip it and weld the other side a little, then back, to prevent warping.
car barn progress
These doors need to be able to have a trolley wire pass between them without touching.
We wanted the option to have a wire in Stall One, but aren't planning to put it in immediately.
This complicated-looking structure allows us to easily cut out the nearest block if we want to have a 8"x12" notch for the trolley wire.
This might make more sense when you see the finished doors for Stall Two, which have the wire notch.
car barn progress
The pin and opening on the right provide a lift point after the siding is on, if we ever need to remove a door.
The removable block is just tacked in to fill the hole.
car barn progress
Half-way done.
car barn progress
Pieces for door number 4 are laid out on the floor
car barn progress
Meanwhile, we put siding on the other door frame.
car barn progress
Here are the Stall One Track (left) and Stall Two Track and Turnout 7 emerging from the snow.
car barn progress
Stall One now has all its doors.
car barn progress
Larry cleans off some of his welds.
car barn progress

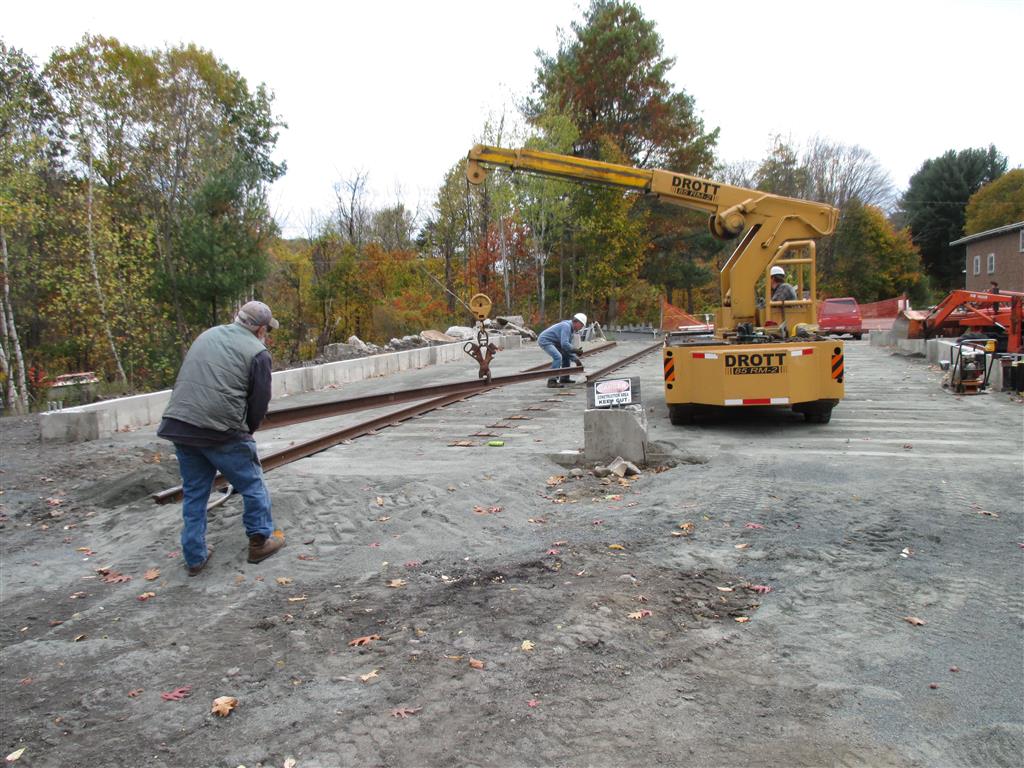

We hung the doors by picking them up with the Drott, then driving it to the opening and swinging it into place.
car barn progress
Last but one!
car barn progress
Here you can see better the notch to allow space for the trolley wire in Stall Two.
car barn progress

car barn progress
One end or the other of every frame 6"x2" tube (1/4" thick) was boxed off to keep weather out.
car barn progress
More sheathing.
car barn progress

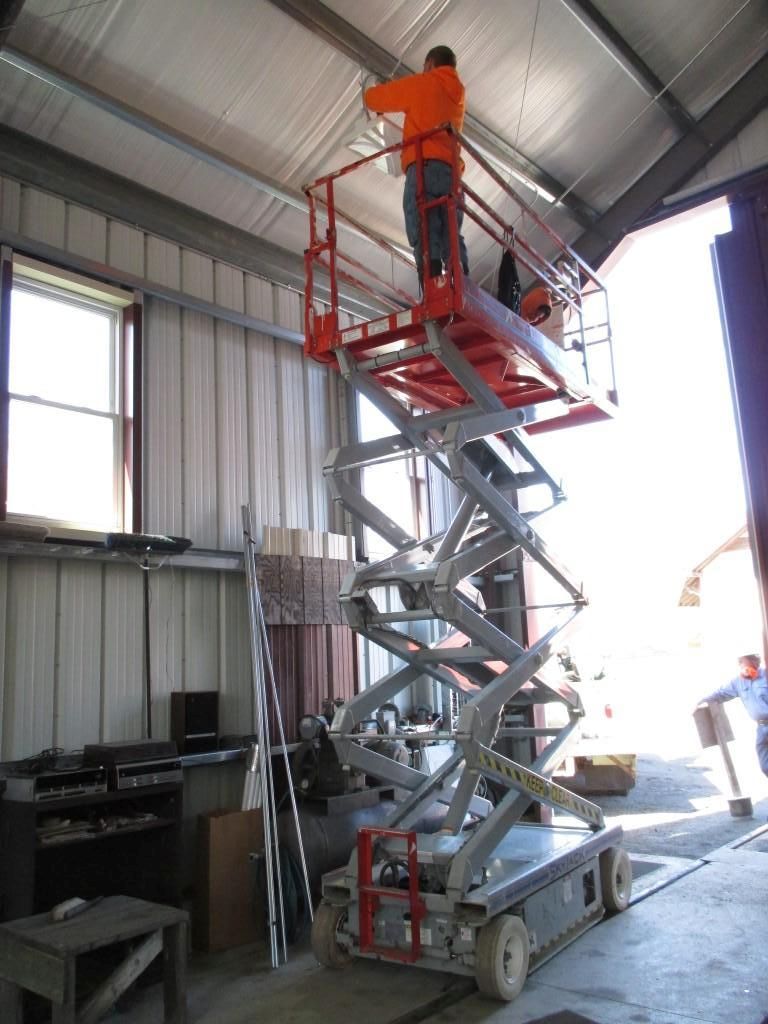

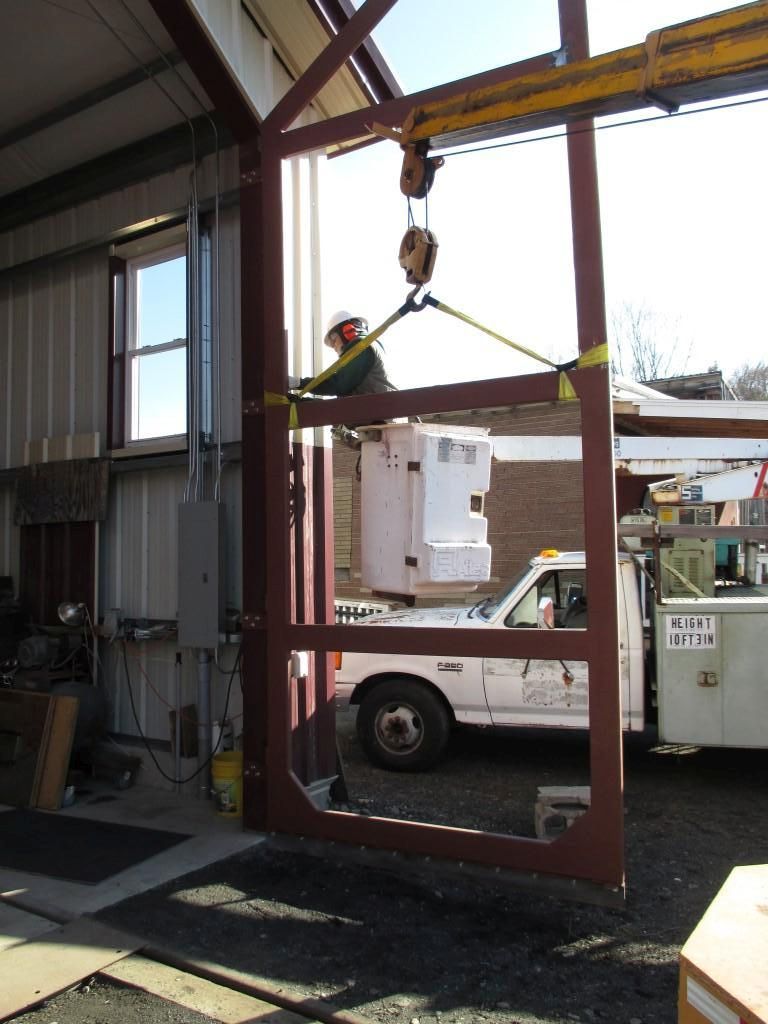

Larry installs the hinge pins from the bucket truck while the Drott holds the door.
car barn progress
We won't be able to lift the doors this way once the sheathing is on.
car barn progress
Last door frame is up! See the wire trough sticking through the notch in the top of the doors?
car barn progress

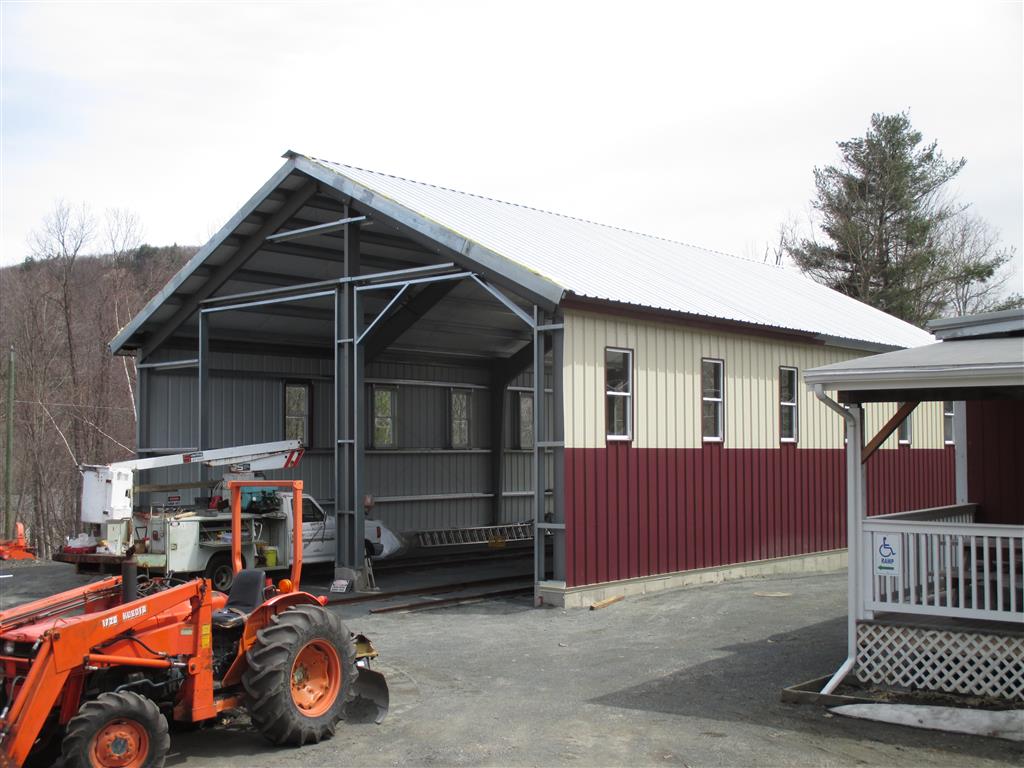

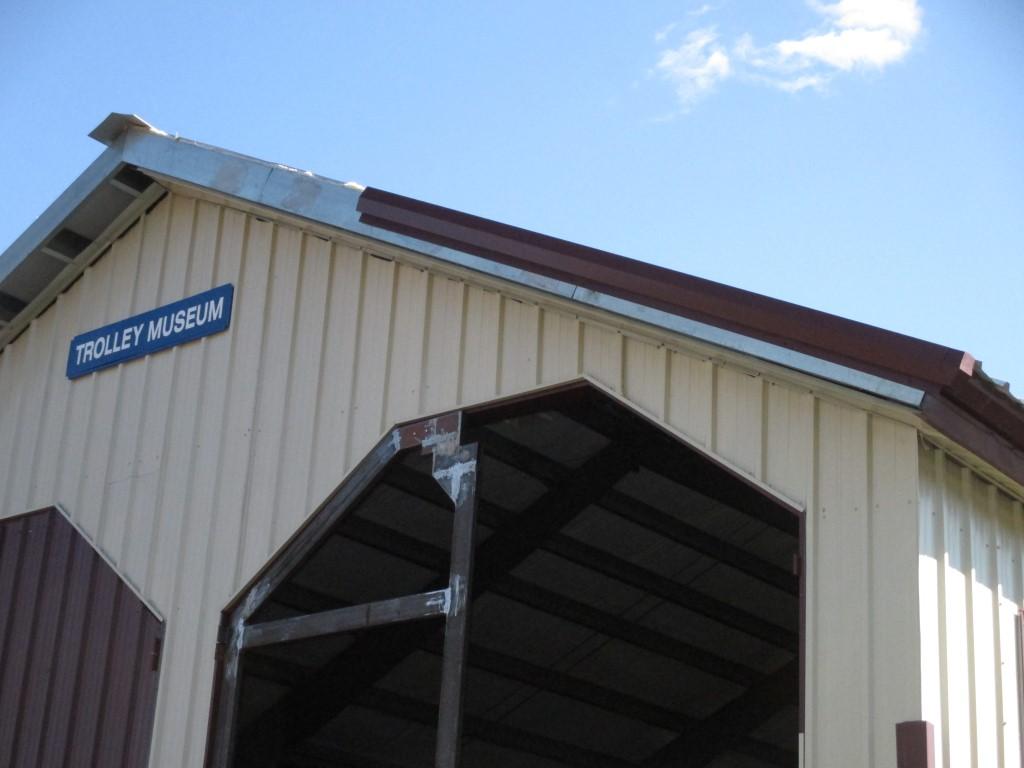

And all the siding is on, just some trim and soffits left.

Spring 2016 - Wiring the interior and overhead trolley wire.
Still lots to do, but it looks and feels a lot more complete with the doors on.
car barn progress
The wooden wire trough keeps the trolley pole from shorting the wire to the building.
car barn progress
Franklin County Technical School wiring students did our wiring, here they are putting up the LED lights.
car barn progress
This view also shows the LED lights and the vent pipes for the oil-water separator and floor drains.
car barn progress
Tech shool students installing the switch for the ventilation fan.
car barn progress
Lights, and the caboose is under cover.

Summer 2016 - We were also working on putting up the overhead wire (see pictures of that project here).
You can see the overhead wire coming in in the picture below. The heavy-duty door latches also show in this picture. car barn progress
No. 10 pokes her nose out from the New Carbarn!

This video by D. Goff shows No. 10 on one of her first test trips into Stall 2 of the New Carbarn, on the new Approach Tracks under the new trolley wire.
car barn progress
At Trolleyfest July 23, 2016, President Sam Bartlett welcomes guests, thanks donors and volunteers, and gives a brief history of the Carbarn Project.
car barn progress
At Trolleyfest July 23, 2016, No. 10 breaks the (very stretchy Caution Tape) ribbon to celebrate the completion (mostly) of this very important project.

At Trolleyfest July 23, 2016, No. 10 does the ribbon breaking honors. Video by D. Goff.

A big thank you to all the donors, large and small, and everyone who helped build this building, teenagers, college students, working people, retirees, octegenarians. It will protect No. 10 for decades to come, and allow our volunteer crews to maintain and restore our growing collection or trolley cars and rolling stock.

So that project is essentially done and paid for, with help from our members, supporters and volunteers. Now (2024) we are building an extension to our Car Barn.

If you want to support our future restoration projects (the MBTA Line Car 3283, the "Berkshire Hills" or the MBTA PCC car 3321, ) you can Renew your Membership or Join us as a new Member or join our crew of volunteers or make a donation at the bottom of the Membership page.

If you haven't already, you can see a report on the installation of the new trolley wire over the House Track and one on the rebuilding of the House Track which are part of this overall project.

Any questions? Contact Sam Bartlett at trolley@sftm.org.

Return to http://sftm.org/carbarn.shtml

Trolley Car No.10 is back ... On track!

Go to Shelburne Falls Trolley Museum Homepage

14 Depot Street Shelburne Falls MA 01370        413-625-9443       trolley@sftm.org
